Renewable Energy Financial Analysis: Investment Trends & ROI

Introduction

A C&I buyer in Maharashtra can receive three solar PPA quotes from different developers—same capacity, wildly different tariffs, and no clear way to compare landed costs after open access charges. That gap between quoted price and actual delivered value is where most renewable energy deals go wrong. Falling technology costs and rising grid tariffs have made the economics attractive, but evolving state regulations and complex procurement structures make it hard to verify whether a proposed deal will actually deliver over its 20-year term.

This guide covers how to evaluate renewable energy investments using financial metrics—IRR, NPV, payback period, and LCOE—with real numbers from the Indian market. It's built for C&I buyers and developers who need to move from quotes to decisions without leaving money on the table.

TLDR

  • C&I renewable projects in India deliver equity IRRs of 14–18%, outpacing utility-scale returns
  • Solar LCOE of ₹3.00/kWh vs. grid tariffs of ₹6.50–8.00/kWh creates payback periods of 3–5 years
  • Debt-to-equity ratios of 70:30 are standard; domestic debt costs 8.5–9.75%
  • Key risks include generation shortfall, regulatory changes, and DISCOM payment delays
  • Instant IRR, payback, and state-wise regulatory analysis can cut deal evaluation time significantly—covered in the final section

The State of Renewable Energy Investment in India

India's renewable energy sector is experiencing unprecedented capital inflows. In 2024, 83% of India's power sector investment went to clean energy, with the country receiving approximately USD 2.4 billion in development finance for clean energy generation. As of February 2026, India's total renewable installed capacity reached 266.68 GW, positioning the country firmly on track toward its 500 GW non-fossil fuel target by 2030.

C&I buyers are now among the largest drivers of renewable demand in India, and the numbers reflect a structural shift:

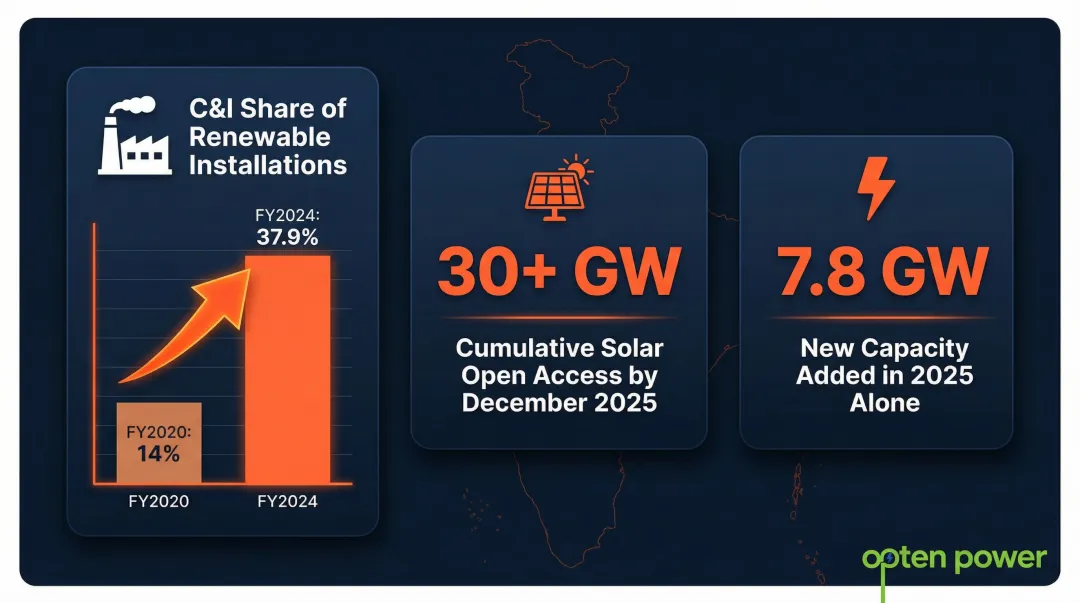

C&I renewable energy share growth from 14 percent to 37.9 percent FY2020 to FY2024

This surge in C&I adoption is backed by a financing structure that institutional lenders treat as low-risk. Globally, renewable energy project financing typically uses debt-to-equity ratios of 70:30 to 80:20; for Indian utility-scale solar specifically, the typical ratio sits at 70:30 to 75:25. This high leverage reflects institutional confidence in renewable asset stability and cash flow predictability — critical factors for project viability.

Core Financial Metrics Every Investor Must Understand

Internal Rate of Return (IRR)

IRR is the discount rate at which the net present value of all project cash flows equals zero. If the IRR exceeds your cost of capital, the project is financially attractive. C&I renewable projects in India currently deliver equity IRRs of 14-18%, outpacing utility-scale solar returns of 13-16% by 1-2 percentage points. These benchmarks reflect current market conditions, financing costs, and tariff arbitrage opportunities.

Net Present Value (NPV)

NPV converts a stream of future cash flows—energy cost savings or revenue—into today's value using a discount rate. A positive NPV means the investment creates value. Unlike IRR, NPV gives an absolute rupee figure — which matters when you're comparing a 2 MW rooftop project against a 50 MW open-access deal. Use both together for a complete picture.

Payback Period

The simple payback formula divides capital cost by annual savings. The discounted payback period accounts for the time value of money. Payback periods for C&I solar projects in India typically range from 3 to 5 years for continuous-load industries, depending on financing structure and tariff levels. With accelerated depreciation benefits, this can drop to under two years.

Levelized Cost of Energy (LCOE)

LCOE represents the per-unit cost of energy over the project lifetime, accounting for capital, O&M, and financing. The table below shows 2024 benchmarks versus typical DISCOM tariffs:

Energy SourceLCOE (2024)Typical DISCOM TariffCompetitiveness
Utility-Scale SolarUSD 0.038/kWh (~₹3.00/kWh)₹5.00–₹9.00/kWhHighly competitive
Onshore WindUSD 0.048/kWh (~₹3.80/kWh)₹5.00–₹9.00/kWhCompetitive

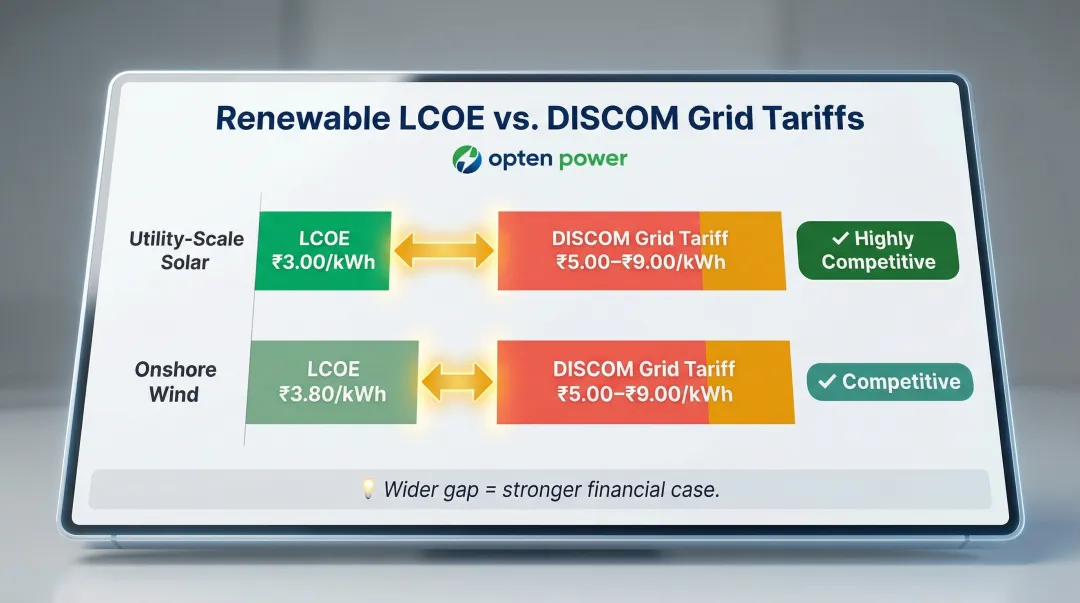

Solar and wind LCOE versus DISCOM grid tariff competitiveness comparison India 2024

The wider the gap between LCOE and your current tariff, the stronger the financial case for switching.

Stress-Testing a Deal: BCR and Sensitivity Analysis

Before committing capital, two tools help you pressure-test the numbers:

  • Benefit-Cost Ratio (BCR): Divides total discounted benefits by total costs — any ratio above 1.0 indicates a viable project; above 1.3 is generally considered strong for C&I renewable deals
  • Sensitivity Analysis: Adjusts key variables (tariff rates, capacity utilization, debt costs) to show how IRR or NPV shifts under pessimistic, base, and optimistic scenarios
  • Scenario Modeling: Runs multiple sensitivity cases simultaneously, giving a probability-weighted view of outcomes rather than a single-point estimate

Running these calculations across five or ten developer quotes simultaneously is where most procurement teams lose time. Opten Power automates IRR, payback, and regulatory analysis across live quotes on its platform — so you're comparing real numbers, not spreadsheet assumptions.

How to Calculate ROI on a Renewable Energy Project

Step 1: Establish the Baseline Energy Cost

ROI analysis begins with your current cost of grid power. This includes:

  • DISCOM base tariff
  • Cross-subsidy surcharge (CSS)
  • Transmission and wheeling charges
  • Demand charges (if applicable)

This comprehensive baseline is the benchmark that renewable procurement must beat. For example, Rajasthan's HT industrial base tariff is ₹6.50/kWh, but adding CSS of ₹1.58/kWh and wheeling charges of ₹0.62/kWh brings the effective cost to ₹8.70/kWh.

Step 2: Project Annual Energy Generation and Savings

Estimate annual output using the formula:

Annual Generation (kWh) = Installed Capacity (kW) × Capacity Factor × 8,760 hours

The national benchmark capacity utilization factor (CUF) for solar is 19-25%; for wind, P90 PLF assumptions for good sites are around 34%. Calculate year-one savings by multiplying generation by the cost differential between the PPA rate and current grid tariff.

Step 3: Account for All Project Costs

Non-EPC costs are where most ROI models fall short — account for every line item below:

  • Capital expenditure (EPC cost): Typically USD 550-650/kW for utility-scale solar
  • Operations and maintenance: 1-2% of capex annually
  • Insurance: Typically 0.3-0.5% of project value
  • Land/roof lease: Varies by location and arrangement
  • Regulatory charges: Open access fees, banking charges, state-specific surcharges

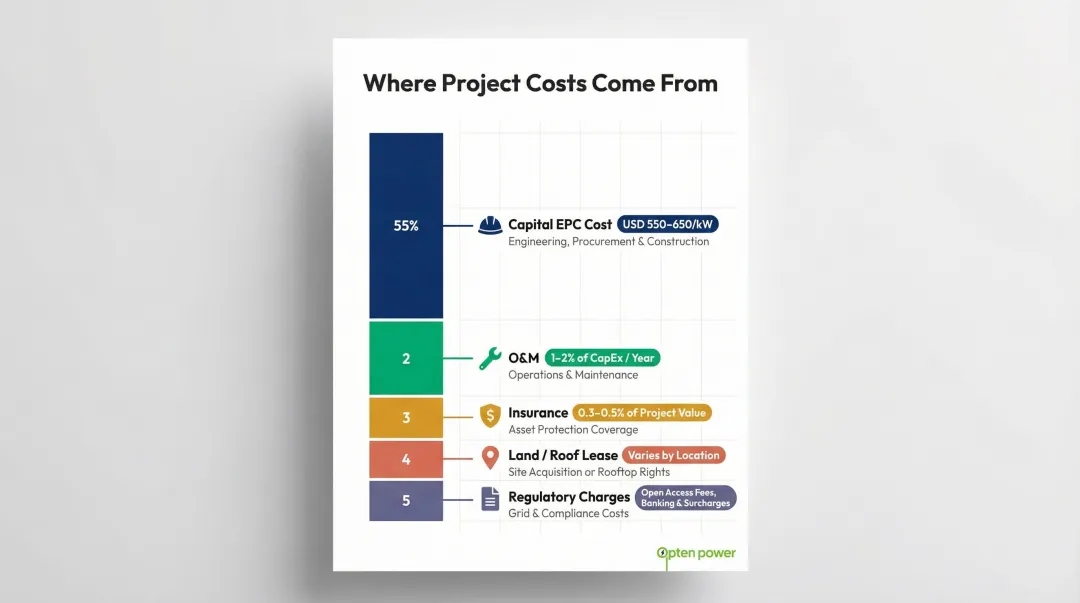

Five-component renewable energy project cost breakdown from EPC to regulatory charges

Step 4: Build the Cash Flow Model

Layer annual savings against annual costs over the project lifetime (typically 20-25 years). Apply a discount rate reflecting your cost of capital to arrive at NPV and IRR.

Pay close attention to escalation clauses in PPAs. A 3% annual escalation in the PPA rate steadily erodes savings if grid tariffs escalate at a faster pace — model both scenarios before committing.

Step 5: Compare Against the Investment Hurdle Rate

Green-light a renewable project when:

  • IRR exceeds the company's cost of capital or WACC, OR
  • NPV is positive at the required discount rate

Repeat this comparison under conservative and optimistic assumptions via sensitivity analysis. Test the impact of a 10-20% variation in generation, tariff rates, and financing costs on project IRR.

Financing Structures for Renewable Energy Projects

Three Primary Financing Categories

Equity (high risk, high return):

  • Project developers and institutional investors
  • Targets IRRs of 14-18% in the C&I segment
  • Bears first-loss risk but captures upside

Debt (medium risk):

Hybrid/grant financing:

  • Multilateral development banks, IREDA, MNRE subsidies
  • Viability Gap Funding (VGF) for hybrid projects
  • Reduces cost of capital and improves project IRR for equity investors

Power Purchase Agreements (PPAs)

PPAs are the financial backbone of most C&I renewable projects. A long-term PPA (typically 15-25 years) provides revenue certainty for developers and predictable cost savings for buyers. The PPA rate, escalation clause, and contract duration collectively determine financial returns for both sides.

Recent SECI solar-plus-storage auctions discovered tariffs of ₹2.86-2.87/kWh, while wind auctions ranged from ₹3.43-3.44/kWh. These benchmark tariffs directly shape the floor pricing that C&I buyers and developers negotiate in bilateral PPAs.

Green Financing Instruments

Capital markets are increasingly funding India's renewable pipeline. Key instruments shaping project finance include:

  • Green bonds: ReNew raised USD 600 million through 6.5% senior secured green bonds in January 2026, issued via GIFT City — a benchmark for large-scale issuances
  • SEBI Green Bond Framework: Mandates disclosures on use of proceeds, project evaluation, and periodic reporting to prevent greenwashing
  • REC market reforms (2022): Eliminated floor and forbearance prices, shifting to fully market-discovered pricing for renewable energy certificates

Key Risk Factors That Affect Renewable Energy Financial Returns

Resource Risk

Solar irradiation and wind variability affect actual vs. projected generation. Lenders typically require P90 energy yield assessments (a conservative scenario with 90% probability of exceedance) to size debt and ensure repayment reliability under underperformance scenarios. A 10-15% shortfall from P50 projections can materially compress IRR.

Regulatory Risk

Counterparty Risk

DISCOMs' accumulated debt of ₹6.84 trillion creates persistent payment uncertainty, stalling over 50 GW of successfully auctioned capacity. Offtaker creditworthiness in PPAs is the top financing barrier.

Beyond offtaker uncertainty, market-level variables introduce a separate layer of financial exposure.

Financial and Market Risks

  • Interest rate fluctuations: Affect debt service costs
  • Currency risk: For equipment with import components
  • Grid tariff trajectory: If grid tariffs fall faster than PPA escalations, savings erode

Identifying these risks is only half the equation — structuring projects to manage them is what determines actual returns.

Risk Mitigation Tools

  • Performance guarantees from EPC contractors
  • Generation-based insurance products
  • Contractual protections in PPAs (force majeure, change-in-law clauses)
  • Comprehensive security packages when approaching lenders

How to Evaluate and Compare PPA Deals for Maximum ROI

Why PPA Comparison Is Harder Than It Looks

Different developers quote different rates, offer varying contract terms, use different escalation structures, and have different grid connectivity and regulatory approval statuses. Making an apples-to-apples comparison is difficult without standardized data.

Key Variables to Compare Across PPA Offers

  • Quoted tariff (₹/kWh): Base rate before regulatory charges
  • Annual escalation rate: Typically 2–4% per year — compounding over 15–25 years, this significantly affects total cost
  • Contract tenure: 15–25 years standard; shorter tenures offer flexibility, longer ones lock in lower base rates
  • Technology type: Solar, wind, or hybrid — each carries different capacity factor and risk profiles
  • Capacity factor: Determines actual generation volume against contracted capacity
  • Open access approvals: Pre-approved projects reduce timeline risk; pending approvals carry regulatory uncertainty
  • DISCOM landing price: Inclusive of all charges (CSS, wheeling, transmission) — the number that actually matters for savings calculations
  • Developer track record: Financial stability and project execution history signal delivery reliability

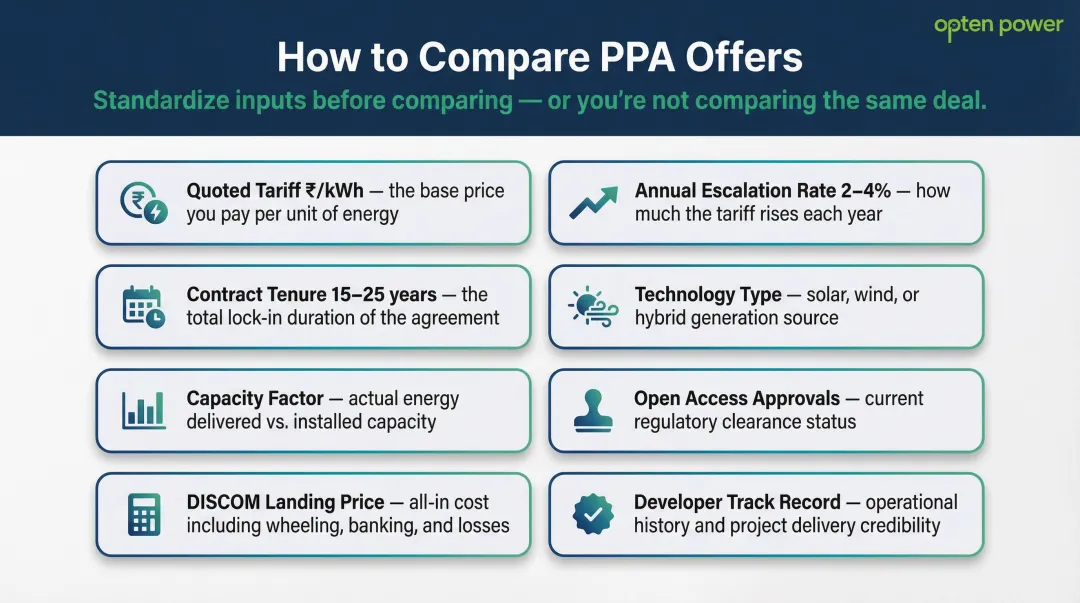

Eight-variable PPA evaluation framework for comparing renewable energy developer offers

Run a Comparative Financial Model

For each PPA offer:

  1. Calculate the effective cost of energy over the contract period (including escalations)
  2. Compare against the projected grid tariff trajectory
  3. Compute the NPV of total savings using your discount rate

The offer with the highest positive NPV is the financially superior choice — but that conclusion is only as reliable as the input data behind it.

The Role of Real-Time Market Intelligence

State-wise DISCOM charges, open access regulations, and landing prices vary significantly across India and change frequently. For example, Karnataka halved its additional surcharge to ₹0.40/kWh for FY2026, while Gujarat reduced it to ₹0.76/kWh. Up-to-date regulatory data is a prerequisite for accurate ROI calculations.

Opten Power addresses this directly. The platform provides standardized, updated landing prices across all 16 states — so tariff comparisons reflect actual regulatory conditions, not outdated estimates. Businesses can run instant IRR and payback analysis across multiple developers in real time, turning a process that typically takes weeks of research into a decision made in minutes.

Frequently Asked Questions

What is a good IRR for a renewable energy project in India?

Typical equity IRRs for C&I solar and wind projects in India range from 14–18%, depending on project type and financing structure. Any project IRR above your company's WACC is financially viable and worth pursuing.

How is ROI calculated for a solar or wind energy investment?

ROI is calculated by comparing total discounted savings (reduced energy costs over project life) against total investment cost. Metrics like NPV, IRR, and payback period are the standard tools used to express this.

What is the typical payback period for a C&I renewable energy project?

Payback periods for C&I solar projects in India typically range from 3 to 5 years for continuous-load industries, depending on financing structure and grid tariff. PPA models can reduce payback risk by shifting capex to the developer.

How does a Power Purchase Agreement affect financial returns?

A PPA delivers revenue certainty for developers and cost predictability for buyers. The PPA rate, escalation clause, and contract term are the three variables that determine whether the deal creates lasting financial benefit.

What are the biggest financial risks in renewable energy investment?

The top three risks are generation shortfall vs. projections, regulatory/policy changes affecting open access or charges, and counterparty/offtaker credit risk. Sensitivity analysis and strong contractual protections are the primary mitigation tools.

How can I compare multiple renewable energy developers before committing to a deal?

Evaluate each developer on PPA rate, escalation terms, capacity factor, DISCOM landing price, and NPV of total savings. Requesting a standardized financial model from each bidder — using the same assumptions — keeps the comparison objective and decision-ready.
