Challenges in Solar Project Financing: Solutions & Best Practices

Introduction

India's solar sector is expanding fast, yet a persistent problem keeps projects from reaching financial close. Between 2020 and 2024, 38.3 GW of utility-scale renewable tenders were cancelled, largely because DISCOMs refused to sign Power Sale Agreements.

For developers, C&I buyers, IPPs, and financiers, the real challenge is navigating high capital requirements, fragmented state regulations, and offtake risk at the same time. Solar project financing ranks among the most complex exercises in infrastructure finance.

TLDR

  • 70-80% of project costs are upfront, with 70:30 to 75:25 debt-to-equity norms placing heavy burdens on equity
  • A 100-150 bps rise in lending rates can wipe out equity returns entirely
  • Open access charges, banking provisions, and cross-subsidy surcharges vary sharply across states
  • DISCOM payment delays totalling ₹673 billion and unsigned PSAs push developers toward C&I corporate PPAs
  • Interconnection approvals add 12-24 months to project timelines, inflating interest during construction

Why Solar Project Financing Is Uniquely Complex

The Front-Loaded Capital Problem

Solar projects are fundamentally different from conventional infrastructure because 70-80% of total costs occur upfront — modules, inverters, civil works, and grid connections must be paid before a single rupee of revenue is earned. Solar modules alone account for over 50% of project costs. Revenue then accrues gradually over 20-25 years, creating a persistent capital structure challenge.

That front-loaded cost burden shapes how lenders approach the asset class. Indian lenders typically underwrite projects at debt-to-equity ratios of 70:30 to 75:25. The Power Finance Corporation (PFC) explicitly states: "Debt Equity ratio (D/E) of the project shall not exceed 75:25 (i.e. equity not lower than 25% of project cost)". This forces developers to deploy significant equity upfront, compressing returns and deterring smaller players without strong balance sheets.

The Multi-Party Alignment Challenge

A solar financing deal requires simultaneous alignment across five parties:

  • Developer/EPC contractor: holds construction risk and must guarantee performance milestones
  • Lender/bank: commits 70-75% of capital against strict DSCR thresholds and security packages
  • Off-taker: a DISCOM or C&I buyer whose PPA underpins the entire revenue forecast
  • Grid operator: controls evacuation infrastructure, with interconnection delays a leading COD risk
  • State regulator: determines open access charges, banking rules, and cross-subsidy surcharges

Misalignment among any one party can delay or kill a deal. For example, if a grid operator cannot provide timely interconnection approval, the project misses its scheduled COD, triggering penalty clauses in the PPA and jeopardising lender disbursements.

Three Primary Financing Structures in India

StructureHow It WorksBest Suited For
Project Finance (Non-Recourse Debt)Debt underwritten against PPA cash flows of a ring-fenced SPV; limited recourse to developer's balance sheetUtility-scale and large C&I projects
Balance-Sheet LendingDeveloper or corporate buyer uses own creditworthiness to secure debtRooftop or captive projects where PPA structures aren't feasible
RESCO / Corporate PPAThird-party developer owns and operates the asset; C&I buyer pays only for energy consumedBuyers seeking zero upfront capital deployment

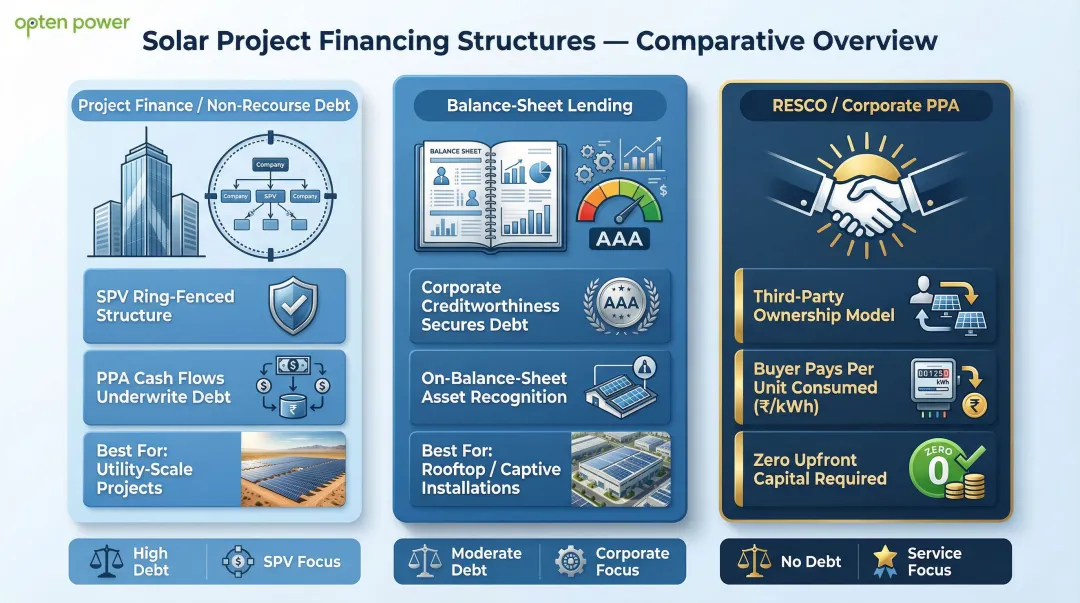

Three solar project financing structures in India comparison infographic

Challenge 1: High Capital Costs and Interest Rate Sensitivity

Why Solar Projects Are Exposed to Rate Movements

Solar projects lock in a fixed IRR at financial close based on the PPA tariff and cost of debt. Unlike operational businesses with flexible cost structures, solar developers cannot adjust pricing once the PPA is signed. A 100–150 bps rise in interest rates wipes out equity returns entirely — at that point, projects become unviable before construction begins.

Indian domestic lending rates remain elevated compared to global benchmarks:

LenderBase Rate RangeKey Concessions
PFC8.95% – 10.25%25 bps post-COD rebate; 10 bps for 75%+ domestic content
REC Ltd.8.95% – 9.70%10 bps rebate for 75%+ domestic content
SBI9.15% EBLR + SpreadGreen initiative concessions available

By comparison, developers accessing international DFIs or green bond markets often borrow 200–300 bps cheaper — a gap that directly compresses equity IRRs on Indian projects.

The DSCR Trap: Debt Sizing Constraints

Indian banks require a Debt Service Coverage Ratio (DSCR) of 1.3x–1.5x, meaning project cash flows must cover debt service by at least 30–50%. This conservative requirement limits the volume of debt available, forcing higher equity contributions. For smaller developers, the resulting thin equity returns make projects unattractive — particularly when competing against well-capitalised IPPs who can absorb the gap.

The Construction Financing Gap

Compounding the equity squeeze is a timing problem that hits before long-term debt is even in place. Projects need bridge loans or construction finance upfront, and the cost and availability of that capital is a frequent bottleneck — particularly for developers without strong balance sheets or those working on their first few projects.

Solutions: Hedging, Green Bonds, and DFI Capital

Three financing strategies can offset rate exposure and ease capital access:

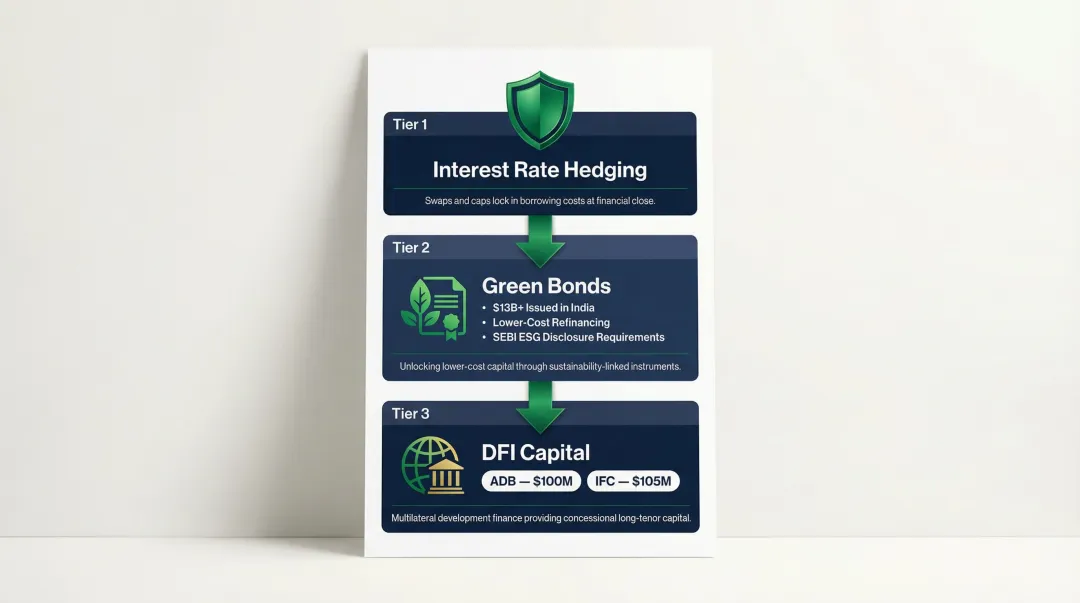

Three strategies to reduce solar financing cost interest rate hedging green bonds DFI capital

The Viability Gap Problem

Even with hedging and DFI access, rate sensitivity alone doesn't explain every financing failure. When competitive bidding drives discovered tariffs too low, debt serviceability breaks down regardless of the financing structure. SECI's cancellation of a 7.5 GW solar tender in Leh and Kargil — driven by transmission infrastructure costs that made tariffs unworkable — is a direct example of how thin tariff margins render projects unbankable at any interest rate.

Challenge 2: Regulatory and Policy Risk Across States

The Patchwork of State Regulations

India's electricity sector is a concurrent subject — states can override or modify central policy. Developers working across multiple states face varying Open Access regulations, banking provisions, cross-subsidy surcharges, and wheeling charges. This creates unequal financing conditions.

State-Level Differences in Banking and Charges:

StateBanking SettlementCross-Subsidy Surcharge (CSS)
Tamil NaduMonthly banking; 8% in-kind charge; unutilised energy sold at 75% of tariffCSS and additional surcharges apply
MaharashtraMonthly banking; 8% in-kind charge; unutilised energy lapsesCSS waived for green hydrogen/ammonia production
KarnatakaMonthly banking; 8% in-kind chargeCSS formula applied; additional surcharge for stranded costs

The shift from annual to strict monthly banking settlements, combined with 8% in-kind charges, severely degrades C&I solar economics that rely on banking to match generation with consumption.

DISCOM Financial Health

Many state DISCOMs carry large accumulated losses and persistent payment delays. As of March 2024, accumulated losses stood at ₹6,92,269 crore with a negative net worth of ₹1,73,365 crore. This directly raises the perceived credit risk of state PPA offtake, making lenders nervous and pushing up the risk premium on debt.

Policy Risks That Persist Beyond Financial Close

Beyond DISCOM health, two structural risks continue to undermine investor confidence:

  • Retrospective tariff and policy changes: Mid-project revisions to net metering caps, banking rules, or RPO targets can materially alter project economics. Andhra Pradesh's move to slash tariffs to ₹2.44/kWh triggered prolonged litigation that spooked investors well beyond that state.
  • Inconsistent RPO enforcement: Renewable Purchase Obligation mandates are meant to anchor demand, but uneven enforcement means off-takers in several states have not followed through on procurement commitments — eroding long-term revenue certainty for developers.

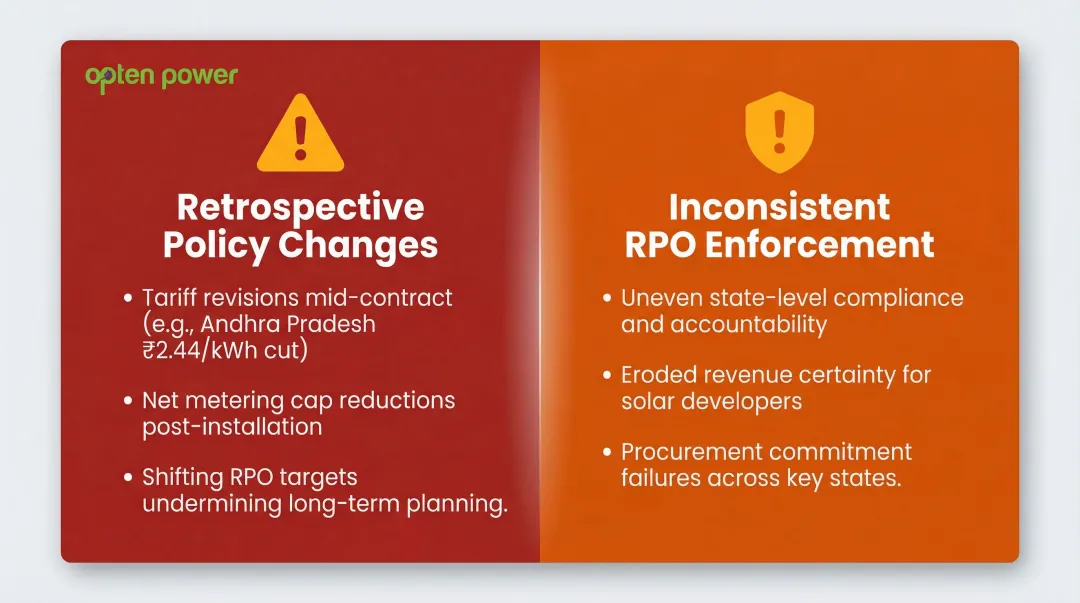

India state-level solar regulatory risk factors open access charges banking provisions comparison

Solution: Real-Time Regulatory Intelligence

Developers and buyers can mitigate regulatory risk through due diligence tools that track state-level tariff and regulatory data in real time. Opten Power's Real-Time DISCOM Intelligence covers standardised landing prices across 16+ states, giving developers and C&I buyers a clear, current picture of project feasibility before capital is committed.

Challenge 3: Offtake Risk and Revenue Uncertainty

The Centrality of the PPA to Project Finance

Lenders underwrite solar debt primarily against contracted cash flows, so the creditworthiness of the off-taker is a direct input to loan pricing and availability. Investment-grade corporate off-takers are easier to finance, while state DISCOMs with poor payment histories require payment security mechanisms such as Letters of Credit or Debt Service Reserve Accounts.

The PPA Tenor Mismatch

Lenders in India typically require PPAs of 15-25 years to match loan tenor. However, many C&I buyers prefer shorter contracts (7-12 years) for flexibility, creating a financing gap for rooftop and open access solar projects targeting the C&I segment.

Curtailment Risk: When Must-Run Status Fails

Even with a signed PPA, actual energy yield depends on grid availability and DISCOM willingness to absorb generation. In Rajasthan, nearly 4 GW of wind-solar energy was curtailed in 2025, with curtailment reaching 51.5% during peak solar hours due to transmission delays. This directly affects projected revenues and lender confidence.

Solution: Corporate PPAs with Creditworthy Off-Takers

Structuring a Corporate PPA (C-PPA) with a creditworthy industrial or commercial off-taker — instead of depending on DISCOM offtake alone — can materially improve bankability. Qualifying off-takers typically include:

  • Data centres and IT parks with high, predictable load profiles
  • Hospitals and commercial complexes with 24x7 consumption
  • Manufacturing plants, steel, cement, and textile units with long-term energy commitments

A well-structured C-PPA can cut energy costs by up to 40% for the buyer while giving lenders the revenue certainty they need to price debt competitively.

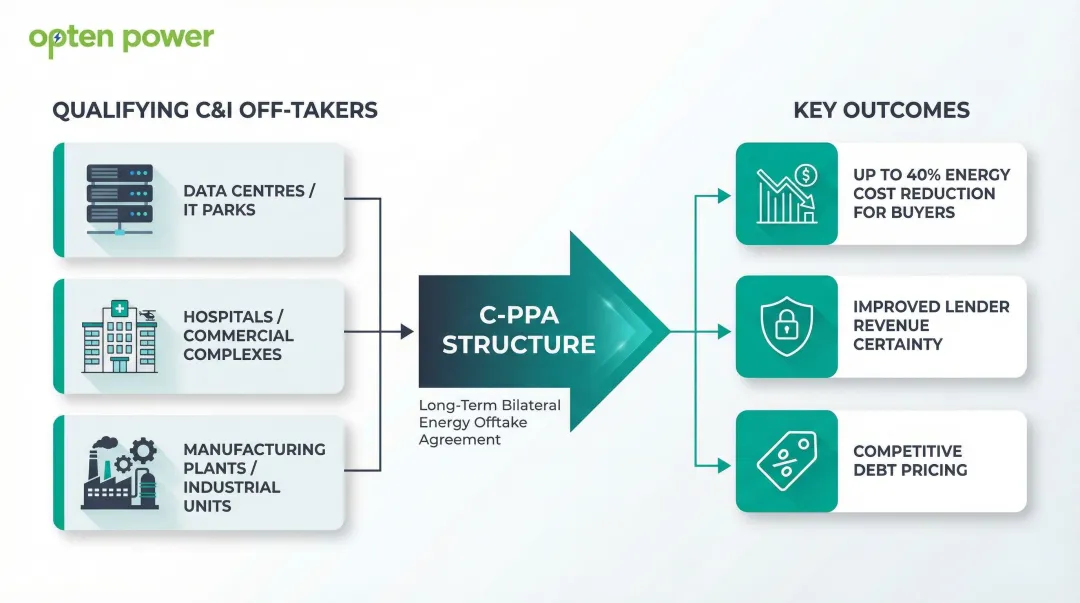

Corporate PPA qualifying off-taker segments and 40 percent energy cost savings benefit

Grid Connectivity Delays and Land Acquisition Hurdles

Interconnection Approvals: The 12-24 Month Delay

Grid connectivity is consistently one of the top reasons for project delays in India. STU/CTU interconnection approvals, substation capacity constraints, and transmission line construction can add 12-24 months to timelines, inflating both project costs and interest during construction. CERC's General Network Access regulations mandate that the Nodal Agency intimate in-principle grant of Connectivity within 60-90 days depending on augmentation requirements, but actual implementation often lags.

Land Acquisition: The Compounding Challenge

Unclear title, encumbrances, and community resistance can delay financial close or trigger cost overruns. Lenders typically require clean land title as a pre-condition for disbursement, yet land issues are often discovered late in the process, forcing developers to scramble for alternatives or accept penalty clauses.

Solution: Early Grid Engagement and Standardised RFPs

Both grid and land challenges share a common root: issues surfacing too late to course-correct without cost. Addressing them at the feasibility stage — before land acquisition is finalised — gives developers a meaningful head start.

Practical steps that compress the pre-financial-close timeline include:

  • Engaging the grid operator early to identify substation capacity constraints and augmentation timelines
  • Conducting title due diligence in parallel with grid feasibility, not after it
  • Using automated RFP tools that embed state-level grid and land-use constraints upfront
  • Presenting lenders with complete, audit-ready documentation from day one to avoid disbursement delays

Best Practices for Improving Solar Project Bankability

1. Prioritise creditworthy off-takersChoose corporate buyers with strong credit profiles. When working with DISCOMs, insist on Letters of Credit, Debt Service Reserve Accounts, or state government guarantees to protect against payment delays.

2. Clear permits before approaching lendersLenders will not disburse without land title clearance, environmental clearances, and grid connectivity approvals — all four of which take independent timelines to resolve. Completing these upfront shortens the path from term sheet to financial close.

3. Commission bank-grade energy yield assessmentsLenders size debt based on P90 energy yield predictions — the annual output that will be exceeded with 90% probability. Without a high-quality independent energy yield report, most lenders won't advance past initial screening.

4. Stress-test the financial model before lender presentationsRun sensitivity analyses showing how project IRR and DSCR hold up under adverse scenarios: rising interest rates, lower-than-expected tariffs, or 10–15% curtailment. Lenders who see a model pre-tested against downside cases move faster through credit approval.

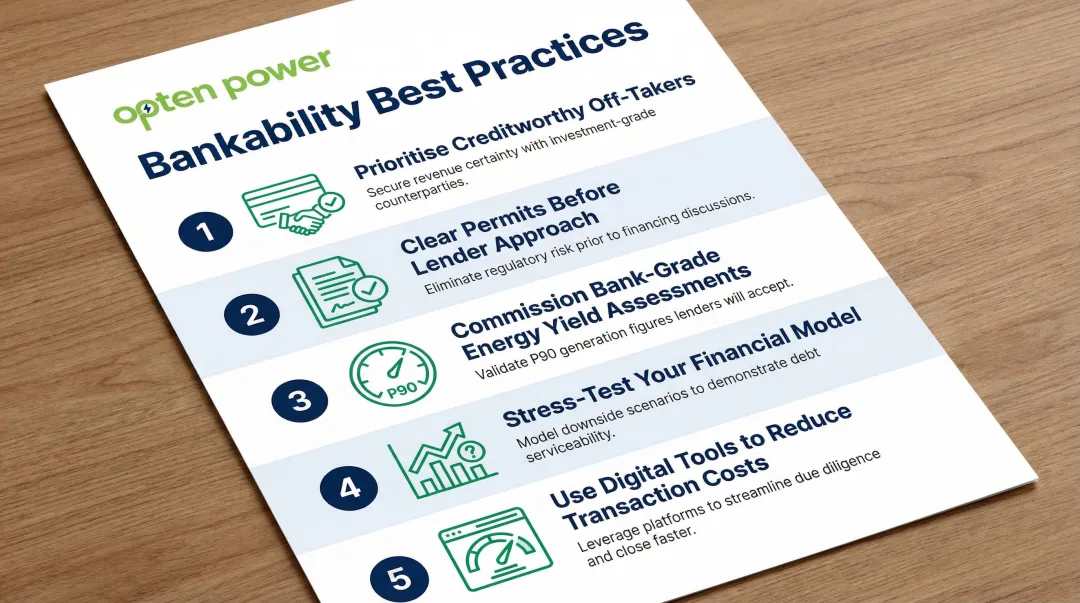

Five best practices for solar project bankability from off-taker selection to financial model stress testing

5. Use digital tools to reduce transaction costsPlatforms like Opten Power's Automated Tender Engine and pre-approved contract templates allow developers to close deals up to 50% faster. Standardised, audit-ready documentation also gives financiers fewer reasons to pause — the single biggest source of delay in credit approvals.

Each of these practices directly addresses what lenders flag during due diligence. The next question is how to package that work into a document that actually gets read.

What Lenders Look for in an Information Memorandum

A well-structured Information Memorandum (IM) and financial model should include:

  • DSCR calculations at P75 and P90 energy yield levels (minimum 1.3x–1.5x)
  • Project and equity IRR under base, upside, and downside scenarios
  • Debt tenor match with PPA — demonstrate how cash flows cover debt service through loan maturity
  • O&M cost assumptions — realistic, inflation-indexed operating costs
  • Liquidated damages in EPC contracts — clear recourse if the contractor fails to deliver on time or performance

Having this documentation audit-ready before approaching lenders shortens deal timelines and signals professionalism.

Frequently Asked Questions

How are solar projects financed?

Solar projects in India use three primary routes: project finance (non-recourse debt backed by PPA cash flows), balance-sheet financing (using the developer's or buyer's own creditworthiness), and RESCO/Corporate PPA models (third-party ownership, buyer pays for power). DFIs like ADB and IFC and green bonds are growing sources of long-tenor, lower-cost capital.

What are the 20% and 33% rules for solar panels?

The 20% rule advises against oversizing a system beyond 20% of average energy consumption to avoid net metering penalties; the 33% rule caps solar at one-third of a building's peak load to maintain grid stability. Both are general thresholds that vary by state DISCOM norms.

What is the biggest challenge in solar project financing in India?

DISCOM credit risk, multi-state regulatory fragmentation, and high domestic cost of capital are the three most consistently cited barriers. Projects targeting C&I buyers with strong credit profiles tend to finance more easily than those relying on DISCOM offtake.

How do Power Purchase Agreements (PPAs) reduce financing risk for solar projects?

A long-term PPA with a creditworthy buyer guarantees a revenue stream that lenders can underwrite against, reducing the risk premium and improving debt availability on the project.

What are the key metrics lenders evaluate for solar project bankability?

Lenders focus on four metrics: DSCR (minimum 1.3x–1.5x), IRR (project and equity), P50/P90 energy yield ratios, and PPA residual tenor relative to the loan repayment period. Strong performance across all four drives the most competitive debt terms.

How does regulatory risk affect solar project financing across Indian states?

Variation in open access charges, banking provisions, and DISCOM tariff payment histories across states creates unequal financing conditions. Projects in states with supportive regulations and financially healthy DISCOMs attract cheaper debt, while those in high-risk states face higher spreads or struggle to reach financial close.
