Winning the M&A Race for Renewable Energy Developers

Introduction

India's renewable energy sector is experiencing a surge in M&A activity as developers race to consolidate capacity ahead of the country's 500 GW target by 2030. As deal competition intensifies, the difference between winning and losing an acquisition comes down to speed, preparation, and market intelligence.

The risks are real. Between 2020 and 2024, approximately 38.3 GW of utility-scale renewable capacity was cancelled—19% of total issued capacity during that period. Since 2022, the Central Transmission Utility of India Limited (CTUIL) has revoked grid connectivity for 6,343 MW of renewable energy capacity strictly due to developer delays in meeting commissioning timelines.

With hundreds of early-stage projects in the pipeline and only a fraction ever reaching operation, buyers must be more disciplined than ever—yet faster than their competitors.

This article examines the forces driving India's M&A surge, what separates winning acquirers from the rest, and how to build a repeatable, high-speed deal process.

TLDR

  • India's renewable energy M&A market is intensifying as capacity demand outpaces organic development timelines
  • Early-stage project failure rates are high; skipping due diligence before committing capital is where deals go wrong
  • Winning acquirers combine speed with rigorous valuation frameworks, not speed alone
  • Deal sourcing and pipeline breadth determine who gets to the table first; the widest view of available projects wins
  • Platforms and automation tools are compressing deal timelines and giving data-forward developers a structural edge

Why Renewable M&A in India Is Accelerating

Bridging the Capacity Gap Through Acquisitions

India has committed to achieving 500 GW of non-fossil fuel electricity generation capacity by 2030. As of November 2025, total non-fossil power installed capacity reached 262.74 GW, leaving roughly 237 GW to add in under five years. With greenfield development cycles unable to close that gap alone, M&A offers a faster route to capacity consolidation.

That urgency is compounded by surging power demand. The IEA projects India's electricity demand to grow at 6.4% per year through 2030—among the fastest rates globally—driven by cooling loads, industrial expansion, and the electrification of transport and agriculture. For acquirers with capital ready to deploy, buying established platforms compresses timelines that greenfield development cannot match.

Robust Deal Volume Despite Market Headwinds

Despite global macroeconomic headwinds, India's renewable M&A volume remains strong. In 2025, 37.4 GW of large-scale solar projects were acquired, with 52% of these acquisitions driven by project developers and IPPs. Landmark platform acquisitions illustrate the scale and strategic intent:

  • ONGC NTPC Green acquired Ayana Renewable Power's 4.1 GW portfolio for $2.3 billion, securing SECI/NTPC-backed PPAs
  • JSW Neo Energy acquired O2 Power's 4.7 GW portfolio for $1.47 billion, vaulting its total renewable capacity well ahead of its original build targets
  • Shell acquired Sprng Energy's 2.9 GW portfolio for $1.55 billion, tripling its operational capacity in India
  • Gentari acquired Brookfield's 1.6 GW portfolio for approximately $900 million

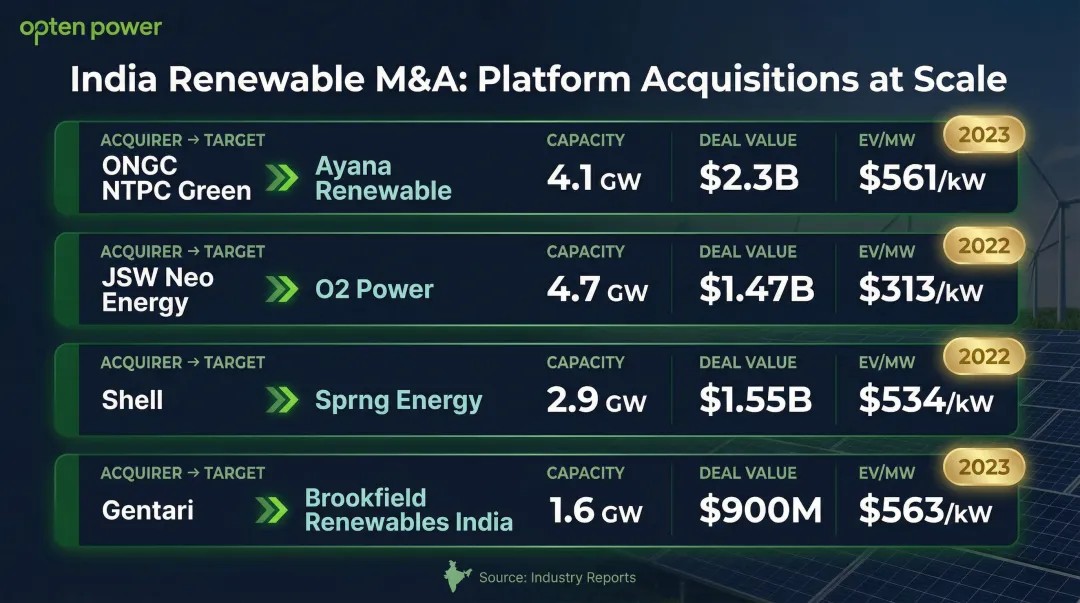

Four landmark India renewable energy M&A deals comparison infographic 2022-2025

The Supply-Side Catalyst: A Seller's Market Emerges

A pipeline of developers who built early-stage projects during the boom now face capital constraints, PPA pressure, or portfolio pruning. This creates real openings for acquirers who can move decisively. Valuations, however, remain complex. With domestic debt costs for greenfield solar and wind projects ranging between 8.5% and 9.75%, buyers must hold firm on valuation discipline — even as competition for quality assets intensifies.

What Sets Winning Acquirers Apart in India's Renewable Market

Strategic Clarity Narrows Decision Cycles

Winning acquirers enter the process with a pre-defined acquisition thesis—specific technology type (solar, wind, hybrid), project stage (early, late, operational), geography (state-level), and target capacity range—rather than pursuing deals opportunistically. This clarity eliminates wasted time evaluating mismatched opportunities and accelerates decision-making when the right target emerges.

Regulatory Literacy at the State Level

India's renewable M&A landscape is complicated by state-specific DISCOM policies, open access regulations, wheeling and banking charges, and grid connectivity norms. Buyers who understand these variables in advance avoid costly surprises post-acquisition.

For example:

Acquirers who factor these state-specific risks into their valuation models avoid overpaying for assets with hidden regulatory headwinds.

PPA Quality Separates Strong Targets from Weak Ones

In the Indian context, a "bankable" PPA is defined by:

  • Offtaker creditworthiness: Central intermediaries like SECI/NTPC eliminate state DISCOM payment risk through sovereign credit backing
  • Tariff levels and tenure remaining: Longer PPA tenures with favorable tariffs command higher valuations
  • Escalation clauses and change-in-law provisions: Protections against regulatory changes preserve project economics

Projects with 25-year PPAs backed by SECI/NTPC command the highest premiums due to zero payment default risk.

Competitive Intelligence Decides Who Closes

Developers who track live market capacity, tariff benchmarks, and competitor acquisition activity across states can identify undervalued assets before they are broadly marketed. Information asymmetry in India's renewable market is decisive—off-market deals close before most buyers know they exist.

Most acquirers piece together state landing prices from fragmented sources—broker calls, past bids, and outdated tariff orders. Opten Power's Real-Time Discom Intelligence addresses this gap directly, providing standardized, updated landing prices across all states so buyers have a live, comparative benchmark rather than stale estimates. That visibility enables acquirers to spot pricing anomalies and act before competitors are even aware of the opportunity.

The Winner Profile

The acquirers who win in India's renewable market share one trait: they treat preparation as a competitive advantage. State-level regulatory fluency, rigorous PPA analysis, and real-time market intelligence compound—each capability shrinks the gap between identifying a target and closing on it. In a market where the best assets rarely surface through formal processes, that speed is the difference between leading a deal and losing it to someone who was simply more ready.

Due Diligence That Protects You: Key Commercial Considerations

The Project Failure Risk Is Real

In India, 38.3 GW of utility-scale renewable capacity was cancelled between 2020 and 2024—19% of all issued capacity during that period. Land acquisition disputes, transmission delays, grid curtailment, and DISCOM payment reliability are the recurring culprits—and each must be stress-tested during diligence.

Three Layers of Commercial Due Diligence

1. Resource and Technical Assessment

  • Wind/solar yield quality
  • Plant load factor (PLF) assumptions
  • Degradation rates over project life

2. Contractual Assessment

  • PPA terms and enforceability
  • EPC warranties and performance guarantees
  • O&M agreements and cost escalation clauses

3. Market and Regulatory Assessment

  • State DISCOM financial health
  • Open access policy stability
  • Grid infrastructure adequacy

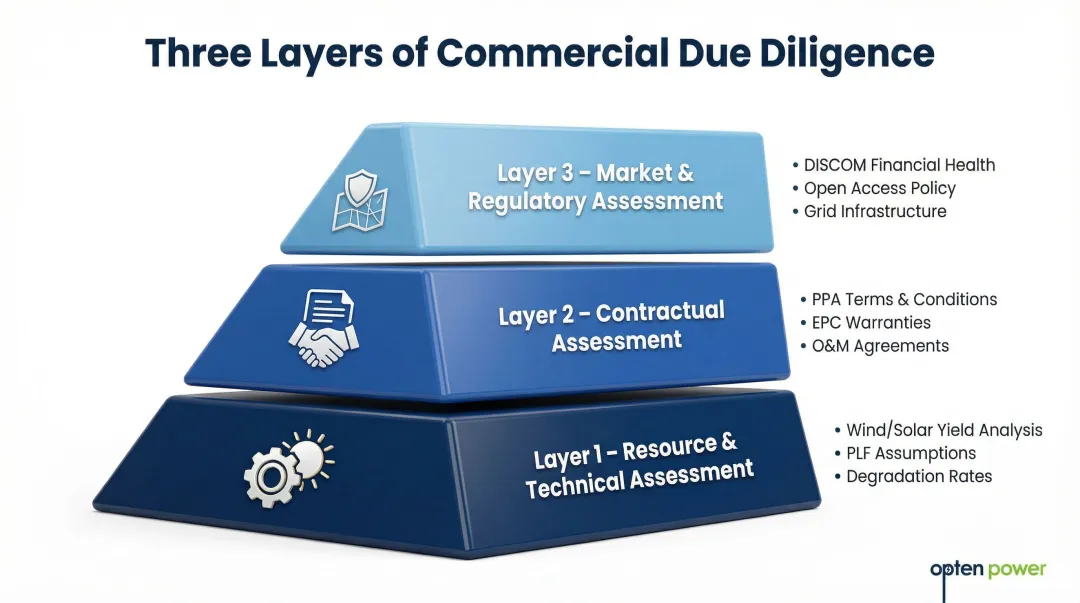

Three-layer commercial due diligence framework for renewable energy acquisitions India

Land and Clearance Risk: The Silent Deal-Killer

In India, land title disputes, forest clearance delays, and right-of-way issues for transmission lines are among the most common deal-killers. A thorough land diligence process should cover:

  • Clear title verification with government records
  • Encumbrance certificates and mutation status
  • Lease agreement terms, renewal provisions, and escalation clauses
  • Environmental and forest clearances

Any of the following should prompt deeper scrutiny before proceeding:

  • Pending litigation on land parcels
  • Unclear ownership or disputed boundaries
  • Missing or expired environmental clearances
  • Transmission right-of-way issues

Independently Validate Financial Model Assumptions

Many sellers present optimistic PLF and tariff escalation assumptions. Buyers must re-run models using conservative, third-party benchmarks for:

  • Capacity utilization rates
  • DISCOM payment timelines
  • O&M cost inflation

The payment delay risk is not theoretical. As of February 2025, DISCOM outstanding dues to generators stood at ₹645.77 billion, heavily concentrated in Uttar Pradesh, Andhra Pradesh, and Maharashtra—states where seller models routinely understate collection risk.

Diligence Findings Drive Deal Structuring

Commercial due diligence findings directly affect deal structuring. When diligence reveals uncertainty in project performance or PPA enforceability, acquirers can use:

  • Earnouts tied to commissioning milestones
  • Escrow arrangements for disputed payments
  • Deferred consideration based on performance

These mechanisms transfer risk to the seller and cap the buyer's downside.

Valuation Frameworks for Renewable Energy Assets

Two Primary Valuation Approaches

1. Discounted Cash Flow (DCF)The most detailed but assumption-sensitive method. DCF models project future cash flows from the asset and discount them to present value using a weighted average cost of capital (WACC). Given that domestic debt costs range between 8.5% and 9.75%, equity IRR requirements typically fall in the 12-16% range for operational assets.

2. Price Per MWA quick-reference comparable that varies significantly by project stage, technology, and state. Recent platform acquisitions provide implied benchmarks:

TransactionCapacityEnterprise Value (USD)Implied EV/MWAsset Profile
ONGC - Ayana (2025)4.1 GW$2.3 Billion~$0.56 Million/MWOperational & Under-Construction; SECI/NTPC PPAs
JSW - O2 Power (2024)4.7 GW$1.47 Billion~$0.31 Million/MW2.2 GW operational by 2025; blended tariff ₹3.37/kWh
Shell - Sprng (2022)2.9 GW$1.55 Billion~$0.53 Million/MWHigh-quality operational assets

EBITDA Multiple Approach for Operational Assets

For operating renewable projects with long-term PPAs, EBITDA multiples offer a fast valuation reference. Key drivers of those multiples include:

  • Remaining PPA tenure (longer = higher multiple)
  • DISCOM creditworthiness (SECI/NTPC backing commands premium)
  • Capacity utilization factor (higher PLF = higher multiple)
  • Technology mix (hybrid projects with higher CUF command better valuations)

Stage-Based Valuation Adjustments

Early-stage (pre-PPA, pre-permit) assets carry a steep discount to reflect development risk, while late-construction and operating assets command a premium for certainty. Risk-adjusted return expectations:

  • Early-stage (pre-PPA): 18-22% IRR required to compensate for execution risk
  • Late-stage (PPA signed, under construction): 14-18% IRR
  • Operational assets: 12-16% IRR

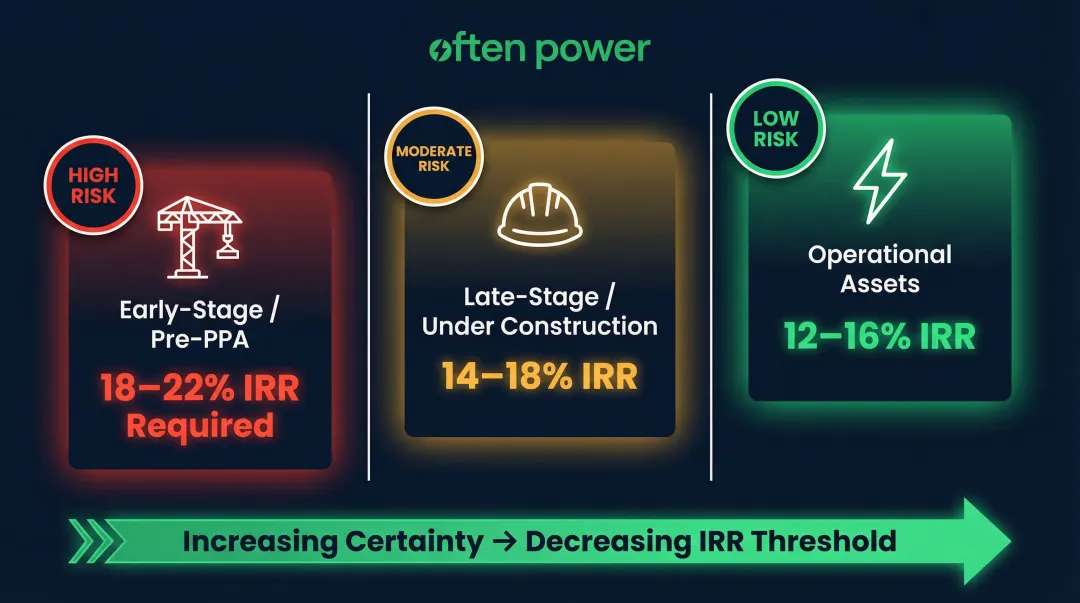

Renewable energy asset stage IRR thresholds early-stage to operational comparison chart

The Discom Intelligence Factor

Those IRR thresholds don't exist in isolation — the financial health of the offtaker shapes every number above them. In India, the state DISCOM purchasing the power is a material valuation input: states with high AT&C losses or poor payment track records justify a higher risk discount on any modeled cash flow.

Opten Power's Real-Time Discom Intelligence addresses this directly. It provides standardized, updated landing prices across all states, giving buyers a live, comparative benchmark for DISCOM creditworthiness — one fewer assumption left to negotiate.

Speed as a Strategic Advantage: Closing Deals Before the Competition

Time-to-Close Is a Competitive Differentiator

In a market with multiple bidders, the developer who can credibly signal fast execution—through pre-approved internal mandates, ready financing, and standardized documentation—often wins over the highest bidder. In a market where 6.3 GW of grid connectivity has been revoked due to developer delays, speed to financial close gives acquirers a decisive edge over competing bidders.

Bottlenecks That Slow Most Acquirers

Common causes of deal slippage include:

  • Manual RFP processes requiring weeks to prepare and distribute
  • Sequential (rather than parallel) diligence review tracks
  • Lack of standardized contracts requiring extensive negotiation
  • Repetitive regulatory checks across states
  • Documentation gaps such as unclear land titles and pending right-of-way clearances

Opten Power's platform is built specifically to close each of these gaps — before they cost you the deal.

The Platform Advantage

Opten Power's Automated Tender Engine—with modular RFP templates and pre-approved contracts—enables developers to cut deal timelines by up to 50%, compressing the process from initiation to close and reducing the window in which competing bidders can enter. With 4+ GW of pre-vetted projects across 16 states, qualified deal flow is immediate — no relationship-dependent sourcing required.

The platform handles the steps that typically stall acquisitions:

  • RFP creation: Modular templates replace weeks of manual drafting
  • Bid collection: Structured intake eliminates back-and-forth coordination
  • Contract finalization: Pre-approved agreements cut negotiation cycles
  • Regulatory checks: State-level compliance data built into the workflow

The result is a measurably shorter path from discovery to signed contract — giving developers a structural advantage that no amount of manual effort can replicate.

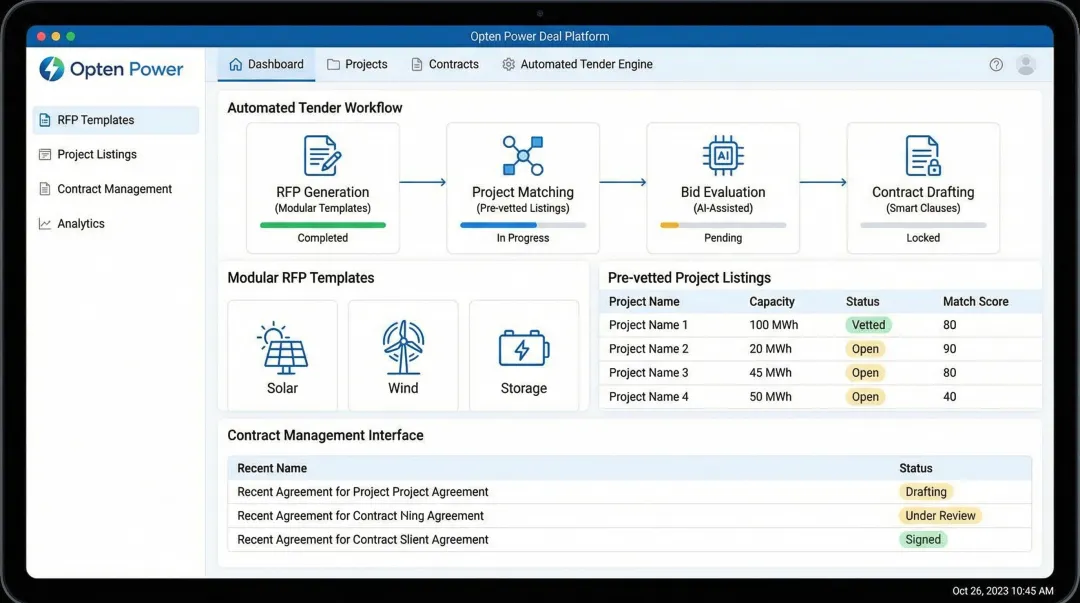

Opten Power automated deal platform dashboard showing RFP templates and project pipeline

Building a Winning M&A Pipeline in India's Renewable Sector

Pipeline Breadth Determines Deal Quality

Developers who rely solely on broker introductions or reactive deal flow see a narrow, often overpriced slice of the market. A proactive pipeline—built through direct developer relationships, platform access, and early-stage deal tracking—gives acquirers more choices and a stronger negotiating position.

Platform-based marketplaces are now surfacing a wider range of developers—including mid-size players with quality assets—who were previously inaccessible outside of established broker networks.

Portfolio Diversification Reduces Concentration Risk

Winning acquirers think across multiple dimensions:

  • Solar, wind, and hybrid projects balance intermittency and maximize capacity utilization
  • State-level diversification protects against localized curtailment and regulatory shocks — in 2025, India curtailed 2.3 TWh of solar power between May and December due to grid security concerns, and concentrated single-state exposure can destroy returns
  • Operating assets provide immediate cash flow; late-stage projects offer near-term commissioning; early-stage positions capture long-term upside
  • Cross-state presence also hedges against state-specific DISCOM payment delays and open access policy reversals

A blended portfolio reduces concentration risk in India's variable regulatory environment.

Post-Acquisition Integration Planning

Portfolio construction is only half the equation. The execution risks that erode returns — grid connectivity delays, PPA novation, DISCOM onboarding — must be planned before signing, not after. Developers who under-invest in integration consistently underperform.

Critical integration milestones:

  • Secure Change in Control approvals from CTUIL prior to COD
  • Complete PPA novation and obtain offtaker consent
  • Confirm transmission queue position before financial close
  • Transition O&M contracts and transfer performance guarantees
  • Onboard DISCOM payment and billing system integrations

Frequently Asked Questions

What makes a renewable energy asset attractive for M&A in India?

A bankable PPA with a creditworthy offtaker (preferably SECI/NTPC), strong resource yield (PLF), clean land title, secured grid connectivity, and location in a state with favorable DISCOM payment history. Assets meeting these criteria command premium valuations and close faster.

What are the biggest risks in acquiring early-stage solar or wind projects in India?

Land disputes, transmission connectivity delays, permit lapses, DISCOM curtailment risk, and the possibility the project never reaches commissioning. Robust due diligence—including land title verification, transmission readiness assessment, and regulatory risk analysis—is the primary mitigation.

How is valuation typically determined for renewable energy assets in M&A?

DCF and price-per-MW are the most common approaches, with multiples varying by project stage, PPA tenure, and state DISCOM quality. Buyers should always independently validate seller assumptions on PLF, tariff escalation, and payment timelines.

How long does a typical renewable energy M&A deal take in India?

Deal timelines vary by project stage and complexity. Developers using automated RFP tools, standardized contracts, and pre-vetted project databases can materially compress the process compared to traditional manual approaches—cutting timelines by up to 50% in some cases.

What regulatory approvals should buyers verify before closing a renewable energy deal in India?

Key approvals include environmental clearance, land conversion status, grid connectivity sanction from the relevant SLDC or ISTS utility, and commissioning certificates for operating assets. For under-construction projects, buyers should confirm the project hasn't breached any milestone timelines under the PPA, as delays can trigger termination clauses or PPA renegotiation.

Who are the biggest renewable energy developers active in India's M&A market?

Large IPPs (Adani, ReNew), PSU developers (NTPC, ONGC), international infrastructure funds (Brookfield, Actis), and domestic conglomerates (JSW, Tata) dominate platform acquisitions. Platforms like Opten Power are also surfacing mid-size developers with quality assets who were previously inaccessible outside established broker networks.
