How to Invest in Wind Energy Projects: Complete Guide

Introduction

India's wind energy sector has an 85 GW capacity gap to close by 2030. With 55.13 GW installed as of February 2026 against a 140 GW target, that gap represents one of the largest clean energy investment pipelines in Asia.

Industrial and commercial sectors are increasingly treating wind projects as financial assets — sources of long-term cost reduction and portfolio diversification — not just sustainability targets.

Investing in wind energy isn't one-size-fits-all. Returns, risks, and routes vary significantly based on investor type, ticket size, project structure, and whether you're entering via direct ownership, Corporate PPAs, or financial instruments. A manufacturing unit in Tamil Nadu seeking to offset electricity costs faces entirely different considerations than a financial investor targeting equity returns from a utility-scale project in Rajasthan.

This guide walks through the exact steps, what to prepare, what drives returns, and the mistakes that trip up first-time investors in India's wind energy market.

TL;DR

  • Wind energy in India offers multiple routes—direct ownership, Corporate PPAs, green bonds, and listed equities—each with different capital needs
  • Payback periods run 7–15 years in India, shaped by site PLF, PPA tariffs (typically ₹3–5/kWh), and your financing mix
  • Plant Load Factor (PLF), PPA tariff, regulatory environment, and financing mix determine your actual returns
  • Developer track record, grid connectivity, and DISCOM payment reliability are non-negotiable due diligence checkpoints
  • Opten Power lets investors compare live wind project proposals, tariffs, and IRR projections across developers on one platform

How to Invest in Wind Energy Projects

Step 1: Define Your Investment Objective and Investor Profile

Before evaluating projects, identify your core goal. Are you seeking financial returns through equity or debt instruments? Trying to reduce operational energy costs through a Corporate PPA? Or diversifying a portfolio with long-duration, inflation-linked assets? Each objective maps to a different investment structure and level of involvement.

Next, determine your investor category:

  • C&I energy consumer looking to offset power costs through open access or captive consumption
  • Financial investor seeking yield through project equity, debt instruments, or green bonds
  • Enterprise with direct capex appetite for project ownership and long-term asset control

This classification shapes every downstream decision—from contract structure to risk exposure.

Step 2: Understand India's Wind Energy Landscape

Policy Framework

India's renewable energy policy environment has tightened compliance requirements while expanding incentives. Key instruments include:

  • Renewable Purchase Obligations (RPO): The wind-specific RPO scales from 0.67% in FY25 to 3.48% by FY30, with strict penalties for non-compliance under the Energy Conservation Act
  • Wind-Solar Hybrid Policy: Mandates that one resource must be at least 33% of the other's rated capacity, offering cross-subsidy surcharge exemptions in states like Gujarat
  • Open Access Regulations: Short-term and long-term open access mechanisms vary significantly by state, affecting wheeling charges and banking provisions

High-Potential States

According to NIWE's 150-meter wind atlas, India's exploitable wind potential reaches 1,164 GW. The top states include:

State150m Potential (GW)Key Considerations
Rajasthan284.20Highest potential but DISCOM payment delays (₹1,442 Cr overdue)
Gujarat180.80Strong policy support, 100% CSS exemption for captive projects
Maharashtra173.90Significant DISCOM overdues (₹2,297 Cr) require careful structuring
Andhra Pradesh123.30Moderate payment risk (₹1,411 Cr overdue)
Tamil Nadu95.10Established wind corridor but grid curtailment risks

State-level DISCOM reliability directly affects payment security and project cash flows, making this a critical due diligence factor.

Step 3: Choose Your Investment Route

Four Primary Investment Routes:

1. Direct Project Ownership or Co-Development

  • Capital requirement: High (₹5-7 Cr per MW)
  • Typical structure: 70:30 or 75:25 debt-equity ratio
  • Return profile: 12-16% equity IRR (varies by PLF and tariff)
  • Risk level: High (takes on development, construction, and operational risk)

2. Corporate PPA (Power Purchase Agreement)

  • Capital requirement: Zero to minimal upfront capex
  • Contract duration: 10-25 years
  • Return profile: Immediate cost savings (up to 40% below grid tariffs)
  • Risk level: Low to moderate (counterparty and regulatory risk only)

For C&I investors, Corporate PPAs are the most accessible entry point. They lock in below-grid tariffs for extended periods with no upfront capital — and generate measurable cost savings alongside verifiable sustainability credentials. Marketplaces that aggregate developer proposals, such as Opten Power, let businesses compare live PPA offers across 4+ GW of wind capacity in 16 states, with instant IRR and payback calculations built in.

3. Green Bonds or Project Debt

  • Capital requirement: Typically ₹1-5 Cr minimum (varies by instrument)
  • Return profile: 8-11% fixed or floating rate returns
  • Risk level: Moderate (secured by project assets and cash flows)

4. Listed Equities or Wind-Focused Funds

  • Capital requirement: Market-dependent (can start with equity share purchases)
  • Return profile: Market-linked, dividend yield + capital appreciation
  • Risk level: Market volatility plus sector-specific risks

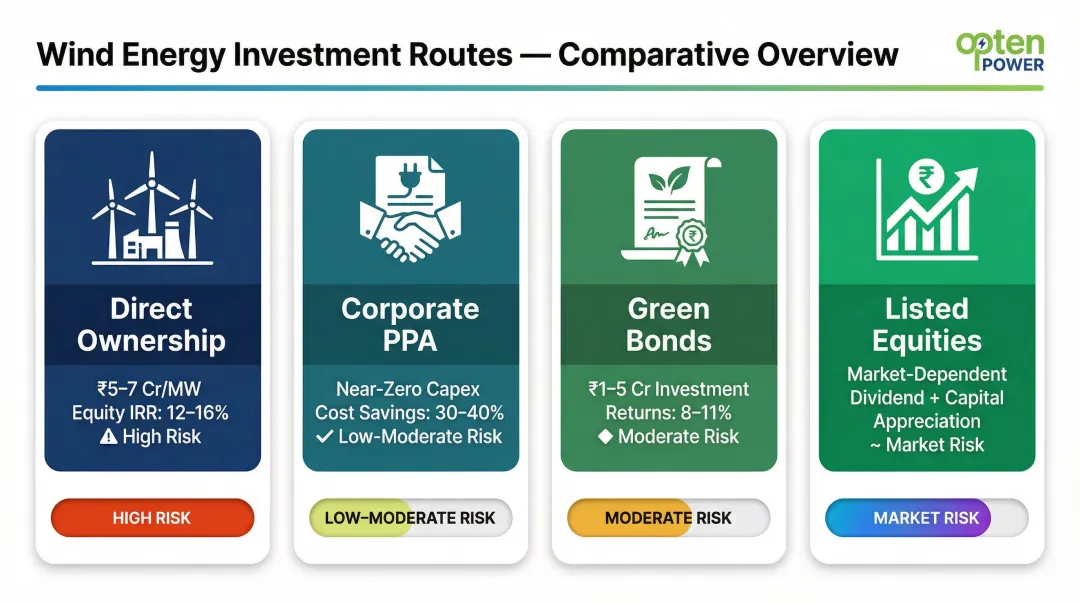

Four wind energy investment routes comparison with capital requirements and risk levels

Step 4: Evaluate Projects and Conduct Due Diligence

Technical Fundamentals Assessment

The wind resource assessment is the single most critical technical variable. Lenders rely on P90 estimates (generation level expected to be exceeded 90% of the time) for underwriting. Over 60% of Indian wind assets have lagged their P90 estimates in recent years — a product of shifting wind patterns that developers don't always disclose upfront.

Key technical metrics to evaluate:

  • P50/P90 generation estimates: Insist on independent resource assessment, not just developer projections
  • Plant Load Factor (PLF): Typical Indian wind projects achieve 25-35% PLF; a 10% PLF difference on a 100 MW project translates to ₹32.15 Cr annual revenue variance at ₹3.67/kWh tariff
  • Turbine specifications: Modern 120-150m hub height turbines unlock higher wind speeds and better generation
  • Grid evacuation infrastructure: Confirm transmission capacity and connectivity approvals to avoid curtailment

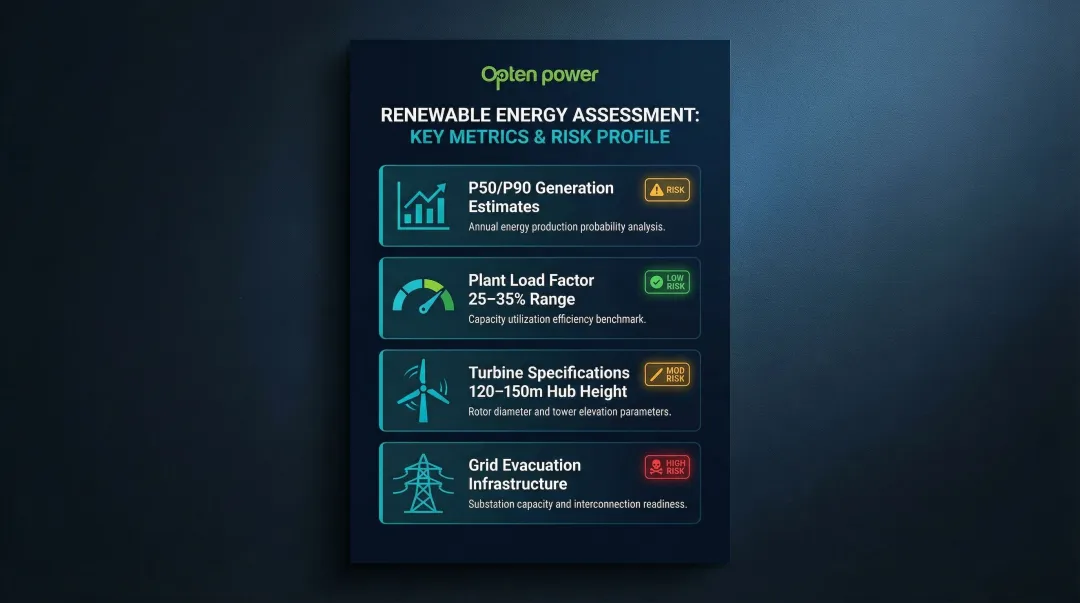

Wind energy project technical due diligence checklist with four key assessment metrics

Developer and Counterparty Risk

Review the developer's track record thoroughly:

  • Commissioned project portfolio and operational performance history
  • EPC credentials and construction completion rates
  • Financial health and balance sheet strength
  • If investing on debt/equity side, scrutinize the offtaker's creditworthiness

Regulatory and Compliance Checklist

  • Land acquisition status and clear title documentation
  • Environmental clearances and forest approvals (if applicable)
  • DISCOM approval and grid connectivity agreements
  • Open access regulations in the target state
  • Transmission constraints and evacuation infrastructure

Real-time DISCOM intelligence tools can cut research time significantly. Opten Power, for instance, provides standardized landing price data across states, making it easier to flag high-risk DISCOM jurisdictions before committing capital.

Step 5: Structure the Deal and Monitor Performance

Key Contractual Components

Finalize these critical elements before signing:

  • PPA term and tariff escalation clauses: Fixed vs. escalating tariff dramatically changes IRR profile
  • Grid curtailment risk sharing: Define compensation mechanisms for forced curtailment
  • O&M responsibility: Clarify who handles operations and what performance guarantees apply
  • Performance guarantees: Set minimum generation thresholds with penalty provisions
  • Exit provisions: Establish clear exit rights and transfer mechanisms

Each clause materially affects IRR. A PPA without curtailment compensation erodes returns by up to 150 basis points under sustained 50% curtailment — a scenario more common in grid-constrained states than most term sheets acknowledge.

Performance Monitoring

Once invested, track these metrics actively:

  • Energy generation against P50 projections (monthly and annual)
  • Payment timelines from DISCOM or offtaker (flag delays immediately)
  • Regulatory changes in the state (RPO mandates, open access charges)
  • Grid curtailment incidents and compensation claims

Investors who skip active monitoring rarely catch DISCOM payment slippage or curtailment creep until it shows up as a meaningful IRR shortfall — often six to twelve months after the problem starts.

When Does Wind Energy Investment Make Sense for You?

Wind energy investment works well for specific buyer profiles — not every business or investor. Here's how to tell where you stand.

High-Consumption C&I Buyers

  • Electricity consumption above 100 kW (minimum for Green Energy Open Access), with 1 MW+ recommended for utility-scale economics
  • Long planning horizons of 10+ years
  • Operations in states with strong wind resources and clear open access policy

These fundamentals matter because wind investments are structured around long-duration contracts — buyers without stable, high-volume load profiles rarely extract full value.

Specific Scenarios Where Wind Delivers

  • Industrial units in high-tariff states (₹10–15/unit) seeking cost reduction via open access or Corporate PPAs
  • Businesses with ESG mandates and Scope 2 emission reduction targets
  • Financial investors seeking long-duration, inflation-linked yield backed by power purchase contracts
  • Heavy industries with 24×7 operations — steel, cement, textiles — requiring base load power

When Wind Energy Isn't the Right Fit

  • Businesses with highly variable or low electricity load
  • Investors with short-term liquidity needs
  • Projects in states with frequent DISCOM payment delays or grid curtailment issues
  • Cases where solar or hybrid projects offer better risk-adjusted returns due to higher capacity utilization

What You Need Before Investing in Wind Energy Projects

Financial Readiness

Capital commitment ranges vary by investment route:

Investment RouteCapital RequirementKey Condition
Direct project investment₹5-7 Cr per MW70:30 debt-equity structure
Green bonds₹1-5 Cr minimumAccredited investor threshold
Corporate PPANear-zero capexCreditworthy balance sheet required

Developer and Platform Access

India's renewable market has historically been fragmented — developers, financiers, and buyers operate in silos, making deal discovery slow and counterparty risk hard to assess. Working through a structured marketplace or advisor with pre-vetted developers and pre-approved contracts cuts discovery time significantly.

Platforms like Opten Power address this directly, connecting C&I buyers with verified project developers across 16 states, with standardized contracts designed to close deals faster.

Regulatory and Technical Knowledge

Before committing, investors need working knowledge of:

  • Open access rules in target states — including wheeling charges, banking terms, and cross-subsidy surcharge
  • Grid connectivity norms and evacuation infrastructure requirements
  • RPO compliance frameworks and applicable penalties

These vary significantly by state and can swing project economics materially. A 2% difference in cross-subsidy surcharge alone can compress equity IRR by 100+ basis points.

Advisory and Legal Support

Engage legal counsel experienced in renewable energy contracts and a technical advisor for independent resource assessment review. Skipping professional advisory on PPA terms is one of the most common — and costly — shortcuts investors make.

Budget ₹10-25 lakh for comprehensive legal and technical due diligence on utility-scale projects.

Key Factors That Determine Your Wind Energy Returns

Two investors in similar-sized wind projects can see dramatically different outcomes. The variables below explain why.

Plant Load Factor (PLF) / Capacity Utilization Factor (CUF)

PLF is the ratio of actual generation to maximum possible generation — the most important technical variable. It directly determines annual revenue. The difference between a 25% PLF site and a 35% PLF site is enormous.

Consider a 100 MW wind project at ₹3.67/kWh tariff:

  • 25% PLF: 219,000 MWh annual generation = ₹80.37 Cr revenue
  • 35% PLF: 306,600 MWh annual generation = ₹112.52 Cr revenue
  • Revenue delta: ₹32.15 Cr annually

High-wind states like Gujarat and Rajasthan achieve 30-35% PLF with modern turbines, while average sites deliver 22-28%. Developers often present optimistic P50 figures; investors should insist on independent resource assessment and underwrite to P90 levels.

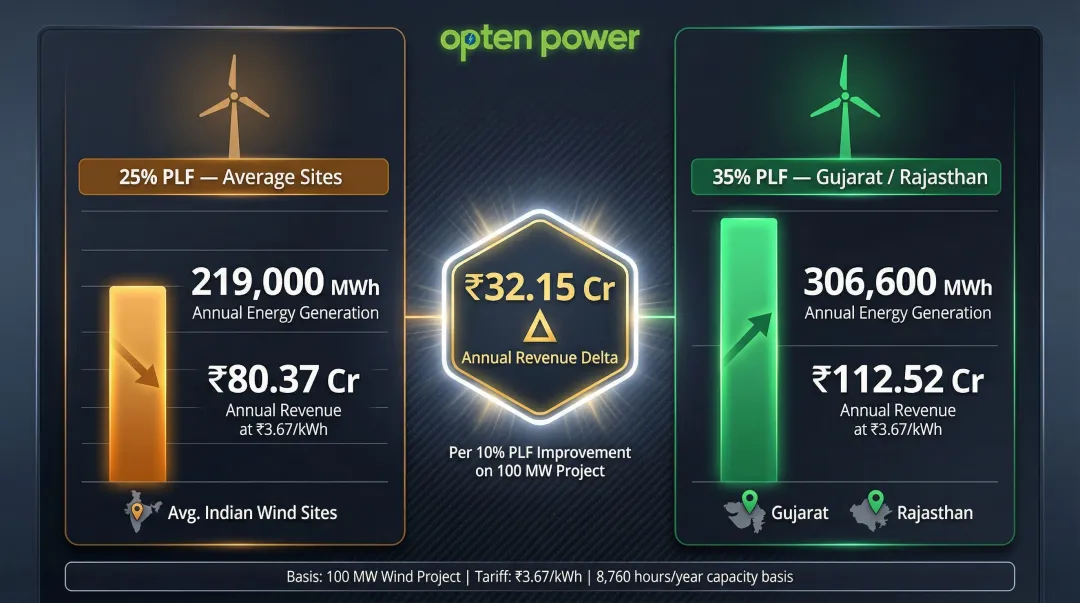

PLF impact on 100MW wind project annual revenue at 25 percent versus 35 percent

PPA Tariff Structure and Escalation Clauses

The PLF tells you how much energy you'll generate — the PPA tariff determines what you earn for it. The tariff locked in at signing governs revenue for the project's entire life, and whether the contract includes escalation, a fixed rate, or market-linked pricing can shift your IRR profile substantially.

Recent SECI Tranche XIX auctions discovered tariffs between ₹3.67-3.69/kWh. The trade-off:

  • Fixed tariff: Predictable cash flows but exposed to inflation erosion over 20-25 years
  • Escalating tariff (typically 2-3% annual): Better long-term protection but requires complex negotiation and may have lower starting tariff

A 2% annual escalation on a ₹3.67/kWh base tariff reaches ₹5.45/kWh by year 20, meaningfully improving long-term returns.

Financing Mix and Cost of Capital

Tariff structure sets the revenue ceiling — financing determines how much of that revenue reaches equity holders. Wind projects are capital-intensive, and Indian projects typically use 70:30 or 75:25 debt-equity ratios.

A 1-2% difference in debt cost can shift equity IRR by 150-200 basis points. Current renewable project finance rates in India range from 9-11% for senior debt. Green financing instruments — green bonds, climate finance from multilateral lenders — can lower the cost of capital to 8-9%, meaningfully improving project economics.

State-Level Regulatory and Grid Risk

Even with strong wind resource, a favorable tariff, and efficient financing, state-level risks can erode returns. Open access charges, DISCOM payment delays, grid curtailment, and shifting regulations all matter — and they vary significantly across states.

PRAAPTI portal data reveals severe DISCOM payment delays:

  • Maharashtra: ₹2,297 Cr overdue
  • Rajasthan: ₹1,442 Cr overdue
  • Andhra Pradesh: ₹1,411 Cr overdue

Payment delays of 6-12 months strain developer working capital and can breach debt covenants. Grid curtailment affects up to 35 GW of renewable capacity, with projects under Temporary General Network Access facing 50% curtailment rates in high-renewable states. A 50% sustained curtailment can compress equity IRR by up to 150 basis points — reason enough to stress-test returns under 10-20% curtailment scenarios and review state DISCOM payment history before committing.

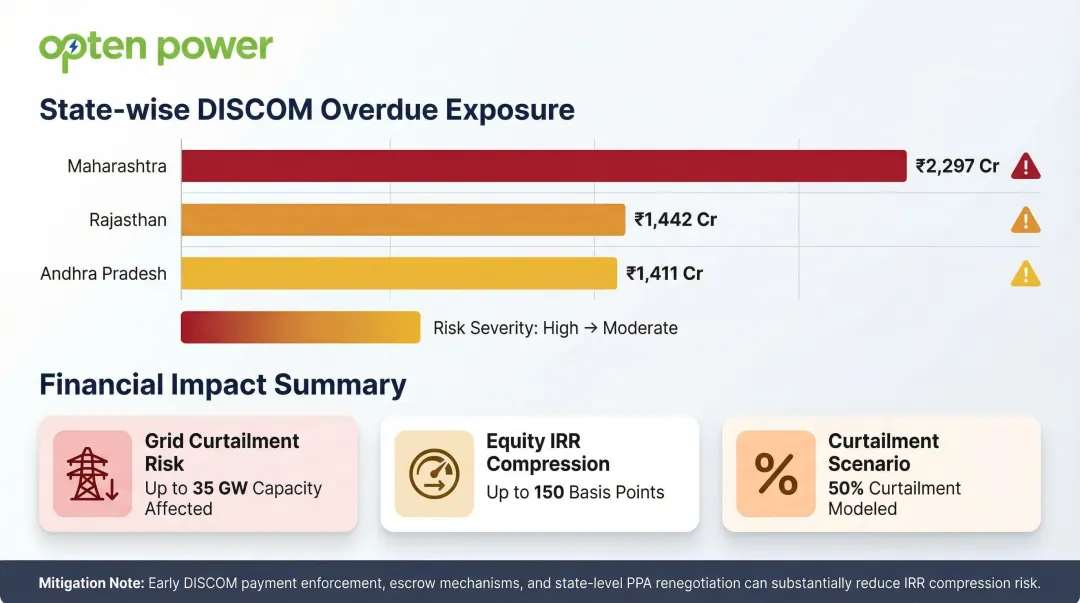

India DISCOM payment overdue amounts by state and grid curtailment risk impact on IRR

Common Mistakes When Investing in Wind Energy Projects

Skipping Independent Wind Resource Verification

Many investors rely solely on developer generation projections without commissioning independent P50/P90 assessments. Developer-supplied estimates are systematically optimistic, which is where projected vs. actual returns diverge most often. Budget ₹5–10 lakh for independent resource assessment on utility-scale projects.

Underestimating State-Level Regulatory Complexity

Entering a state without understanding its specific open access policy, cross-subsidy surcharge structure, and DISCOM approval timelines leads to cost overruns and delayed commissioning. State-level variation in India is significant—Gujarat offers 100% CSS exemption for captive projects, while other states impose 20–40% surcharges.

Before committing capital, verify which CSS exemptions apply to your project category, what the current DISCOM interconnection timelines look like in the target state, and whether open access approvals are locked in or renewed annually.

Mismatching the Investment Route to Your Operational Profile

A high-electricity-consuming industrial unit that takes a financial equity stake in a distant project—rather than signing a Corporate PPA tied to its own consumption—misses the actual value proposition. If your goal is energy cost reduction, a Corporate PPA delivers immediate savings without requiring capital deployment. The route must match your operational and financial profile.

Ignoring Contract Exit and Curtailment Clauses

Investors who sign PPAs or project equity agreements without clear exit rights, curtailment compensation clauses, or performance guarantee thresholds often have no recourse when generation underperforms. This ranks among the most common post-investment complaints. Ensure contracts specify:

  • Minimum generation thresholds with penalty provisions
  • Curtailment compensation at 100% of tariff for forced outages
  • Exit rights after defined performance failures
  • Transfer and assignment provisions

Addressing these clauses before signing is far less costly than pursuing remedies after commissioning.

Frequently Asked Questions

How can I invest in wind energy projects?

Investors can participate through direct project ownership, Corporate PPAs, green bonds, or listed equities/ETFs. The right route depends on your capital availability, risk appetite, and whether your goal is energy cost reduction or financial returns.

How much do farmers or landowners get paid for having a wind turbine on their property?

Landowners typically earn lease royalties of ₹15,000-40,000 per turbine per year in India, depending on installed capacity, location, and negotiated terms with the developer. Rates vary between high-wind states and average wind zones.

What is the minimum investment required for wind energy projects in India?

Corporate PPAs require no upfront capex and are accessible to any creditworthy C&I buyer above 100 kW consumption. Green bonds typically require ₹1-5 Cr minimum. Direct equity in utility-scale projects typically requires ₹5-7 Cr per MW capital commitment.

What is the typical ROI or payback period for a wind energy investment?

Payback periods for direct wind investments typically range from 7-15 years depending on PLF, tariff, and financing structure. Corporate PPAs offer immediate savings from Day 1 without a traditional payback period, delivering 30-40% cost reduction versus grid tariffs.

What are the biggest risks of investing in wind energy in India?

The four most material risks are: wind resource variability (below P90 estimates), DISCOM payment delays (6-12 months in high-risk states), open access policy changes, and grid curtailment (affecting up to 35 GW capacity). Proper due diligence and contract structuring can mitigate each.

Is wind energy a good investment in India right now?

Yes. India's policy tailwinds (RPO scaling to 3.48% by FY30, 140 GW capacity target), declining tariffs (₹3.67-3.69/kWh in recent auctions), and rising C&I demand create favorable conditions. That said, project selection and state-level due diligence remain critical, particularly in states with DISCOM payment delays and grid curtailment exposure.
