Introduction
Indian C&I businesses and investors evaluating wind energy in 2026 face a central question: will this project deliver adequate returns? Internal Rate of Return (IRR) is the primary metric for answering it. Yet IRR remains widely misunderstood in wind energy contexts.
That gap is costly. India's state-level regulatory variations, evolving Corporate PPA structures, and grid curtailment risks all shift IRR outcomes significantly — and most standard financial models don't account for them.
This guide covers what you need to make that assessment accurately:
- IRR definition and mechanics specific to wind projects
- Key drivers that move IRR up or down in Indian conditions
- 2026 benchmarks across project types and states
- Step-by-step calculation approach
- Strategies to improve project IRR
- How IRR compares to LCOE, payback period, and other metrics
With wind capacity additions accelerating across 16+ states and Corporate PPAs gaining traction among steel, cement, and manufacturing industries, a rigorous IRR analysis is the difference between a well-structured deal and an underperforming one.
TLDR
- Onshore wind IRR typically ranges 8–15% (levered); offshore wind runs 8–10% due to higher CapEx
- Five biggest drivers: capacity factor, CapEx, OpEx, PPA tariff, and weighted average cost of capital (WACC)
- Wind IRR targets sit below oil & gas (25–30%) — lower risk, predictable revenue, and a 20–25-year asset life justify the difference
- India's 2026 RPO mandates, policy incentives, and Corporate PPA structures can push IRRs 1–3 percentage points higher for C&I buyers and developers
What Is IRR in Wind Energy Projects?
Defining IRR in Plain Terms
Internal Rate of Return (IRR) is the discount rate at which the net present value (NPV) of all project cash flows (upfront investment and future revenues) equals zero. A higher IRR means the project generates more return relative to its cost of capital. Unlike simpler metrics like payback period, IRR accounts for the time value of money across a 20–25 year project life, which is essential for long-horizon infrastructure like wind farms.
Wind Project Cash Flow Structure
Wind projects follow a distinctive financial pattern:
- Upfront CapEx: Large initial investment in turbines, civil works, and grid connection
- 20–25 years of revenue: Relatively stable electricity sales via PPA or merchant market
- Ongoing OpEx: Maintenance, land lease, insurance, and repairs
This front-loaded cost structure makes IRR especially sensitive to discount rate and capacity factor. Even small changes in these variables can shift IRR by 1–2 percentage points, which is the difference between deal approval and rejection.
IRR vs. Hurdle Rate
Wind projects are approved when their projected IRR exceeds the investor's minimum acceptable return (hurdle rate). For renewable infrastructure in India, hurdle rates typically fall in the 10–14% range depending on project scale, state, and off-taker creditworthiness.
Wind projects command lower hurdle rates than many alternative investments because they carry a distinct risk profile: revenues are predictable, there is no commodity price exposure, and long-term PPAs provide cash flow certainty.
Levered vs. Unlevered IRR
Wind project negotiations use two IRR lenses:
- Unlevered (Project) IRR: Measures return on total investment assuming no debt. Reflects the project's standalone profitability.
- Levered (Equity) IRR: Measures return on the equity portion after accounting for debt financing. This is the figure most equity investors focus on.
Debt structuring significantly changes the outcome. Higher debt ratios at favorable interest rates can substantially boost levered IRR, making the same project more attractive to equity investors.
Key Drivers That Determine Wind Project IRR
Capacity Factor: The Most Sensitive Variable
Capacity factor (actual energy output as a percentage of theoretical maximum) is the single most sensitive variable in wind IRR modeling. NREL research confirms that wind resource and installation costs have the largest incremental effect on LCOE and IRR.
Typical onshore wind capacity factors range from 25–45%. A project at 40%+ capacity factor delivers materially better IRR than one at 25%. According to IRENA's 2025 data, India's average onshore capacity factor reached 39% in 2024—well above the global average of 34%.

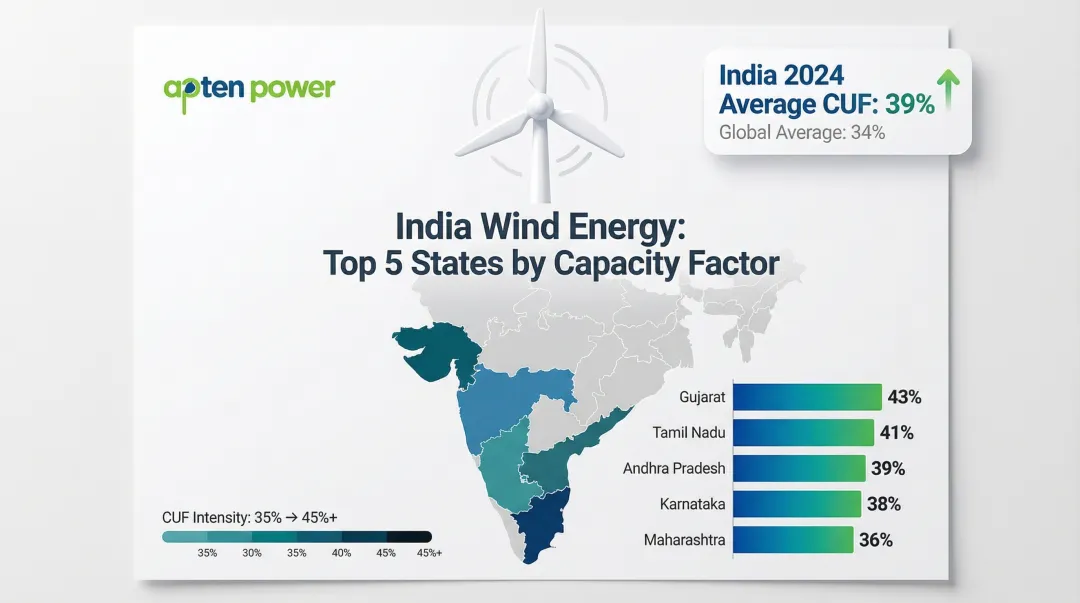

India's top wind states (Gujarat, Tamil Nadu, Andhra Pradesh, Karnataka, Maharashtra) offer high-potential zones exceeding 35% Capacity Utilization Factor (CUF), according to NIWE's 150m wind atlas.
Capital Expenditure (CapEx)
Turbine cost is the largest single CapEx component, representing 40–50% of total project capital expenditure for onshore wind, followed by balance-of-system costs (foundation, electrical infrastructure, civil works).
2024–2026 Indian Wind Project CapEx Benchmarks:
- Total installed cost: ₹4.5–6.5 crore per MW (industry sources)
- CERC benchmark: ₹7.9 crore per MW
- Global comparison: India's installed cost of USD 1,110/kW is close to the global average of USD 1,041/kW, reflecting competitive but not materially lower CapEx
CapEx overruns directly compress IRR. Even a 10% cost increase can reduce project IRR by 1–2 percentage points.
PPA Tariff and Revenue Certainty
The signed PPA or expected merchant power price is the revenue anchor for IRR calculations. A higher, longer-duration PPA tariff improves IRR directly.
Recent Indian Wind Auction Tariffs (2024–2026):
| Auction | Date | Capacity | Winning Tariffs |
|---|---|---|---|
| SECI Tranche XVI | Feb 2024 | 1,175 MW | ₹3.60–₹3.70/kWh |
| SECI Tranche XVII | Oct 2024 | 100 MW | ₹3.81–₹3.82/kWh |
| SECI Tranche XVIII | Jun 2025 | 300 MW | ₹3.97/kWh |
| SECI Tranche XIX | Feb 2026 | 1,200 MW | ₹3.67–₹3.69/kWh |
| GUVNL Phase X | Jan 2026 | 250 MW | ₹3.43–₹3.44/kWh |
Corporate PPAs (C&I buyers contracting directly with wind developers) carry different tariff structures than utility-scale auctions, which affects project IRR accordingly. CRISIL reports that the weighted average tariff for standalone wind projects rose to ₹3.7 per unit in fiscal 2025, expected to generate a 12–13% IRR.
Operating Expenditure (OpEx)
Wind project OpEx breaks into fixed costs (scheduled maintenance, land lease, insurance) and variable costs (unscheduled repairs, component replacement).
Indian Wind Project OpEx Benchmarks:
- CERC's 2024 regulations specify normative O&M expenses at ₹72.69 lakhs per MW for the first year
- Global onshore wind O&M ranges from USD 20/kW/year (Brazil) to USD 93/kW/year (Japan)
Older turbines and remote sites increase OpEx over time, eroding IRR in later project years. A 1% annual OpEx escalation can reduce overall project IRR by 0.3–0.5 percentage points.
Weighted Average Cost of Capital (WACC) and Financing Structure
Keeping OpEx in check matters — but how a project is financed determines how much of that margin reaches equity investors. WACC represents the blended cost of debt and equity used to finance the project. Higher debt ratios (leverage) at low interest rates can significantly boost levered IRR.

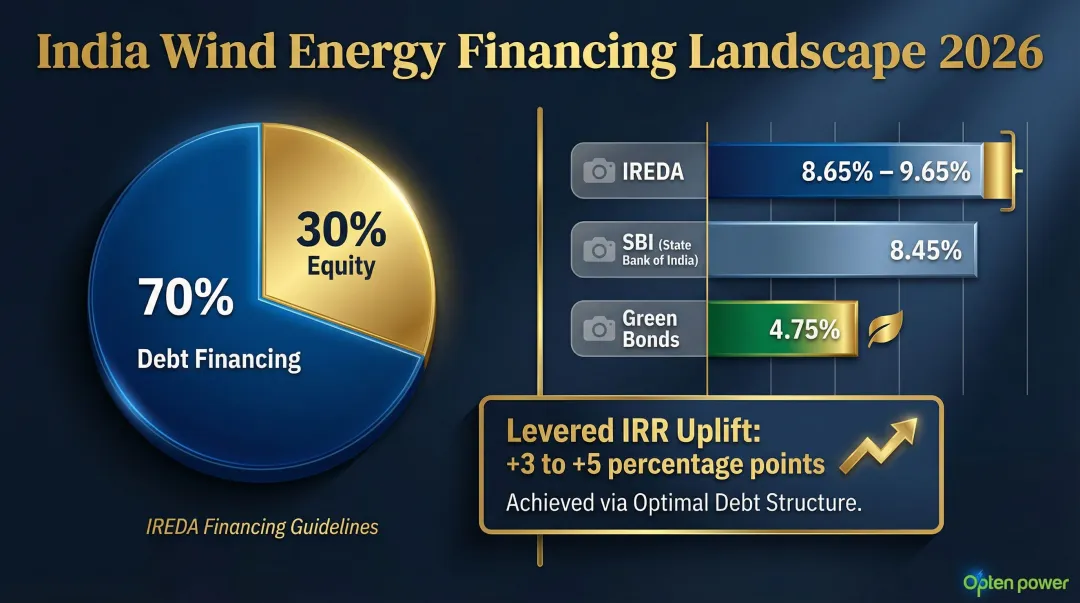

India's 2026 Financing Environment:
- Standard debt-to-equity ratio: 70:30 (per IREDA guidelines)
- IREDA lending rates: 8.65–9.65% for renewable energy projects (July 2025)
- State Bank of India: 8.45% for 20-year renewable energy loans (September 2025)
- Green bonds: REC Ltd raised USD 500 million at 4.75% coupon (September 2024)

A project financed at 70% debt with 8.5% interest can achieve 3–5 percentage points higher levered IRR compared to 50% debt financing.
Policy and Regulatory Environment
Beyond financing structure, the policy environment sets the outer boundary for returns. Production incentives, grid connectivity approvals, and state-level wheeling charges can shift project IRR by 1–3 percentage points.
Key India Policy Factors (2026):
- ISTS waiver: 100% waiver of Inter-State Transmission System charges for wind projects commissioned by June 30, 2025 (applicable for 25 years)
- Offshore wind ISTS waiver: 100% waiver for projects commissioned by December 31, 2032
- Accelerated depreciation: 40% depreciation rate in Year 1 under Income Tax Act
- RPO mandates: Minimum wind renewable energy consumption targets rising to 1.97% by 2026–27
States with favorable open-access regulations (Rajasthan, Gujarat, Tamil Nadu) consistently produce better wind project IRRs than states with restrictive wheeling and banking norms.
Typical IRR Benchmarks for Wind Energy Projects in 2026
Onshore Wind: Global vs. India
Global benchmarks:
- Unlevered project IRR: 8–12%
- Levered IRR: 10–15%
India-specific benchmarks:
- CRISIL data shows 12–13% levered IRR for projects with ₹3.7/kWh tariffs
- Well-sited projects in wind-rich states can achieve 12–16% levered IRR
India's wind-rich states (Rajasthan, Gujarat, Tamil Nadu, Andhra Pradesh) deliver higher IRR than less-resourced regions due to superior capacity factors and open access policies that reduce wheeling costs.
Offshore Wind
Offshore wind economics differ substantially:
- Global CapEx: USD 2,852/kW (vs. USD 1,041/kW for onshore)
- Typical IRR: 8–10% despite higher capacity factors
- India status: Nascent (Gujarat coastline projects); early projects are likely to carry higher IRR risk premiums
RWE targets an IRR of >8.5% for new offshore projects. India has planned an auction trajectory of 37 GW of offshore wind capacity till 2029–30, supported by Viability Gap Funding with a budget of ₹74.53 billion.
C&I Corporate PPA Projects vs. IPP/Utility-Scale
Beyond project type, the offtake structure shapes IRR outcomes just as much. Benchmarks vary sharply by buyer category:
- Utility-scale SECI/state auctions: Target 12–15% levered IRR
- Captive/group captive or Corporate PPA projects: C&I buyers often achieve >20% IRR from an energy cost savings perspective
Opten Power's Corporate PPA marketplace connects wind developers with pre-qualified C&I buyers across 16 Indian states, giving developers offtake security and giving buyers documented energy cost reductions of up to 40%.

IRR Sensitivity Reference
| Capacity Factor | Low CapEx (₹5 Cr/MW) | Mid CapEx (₹6.5 Cr/MW) | High CapEx (₹8 Cr/MW) |
|---|---|---|---|
| 25% | 8–9% | 6–7% | 4–5% |
| 35% | 12–13% | 10–11% | 8–9% |
| 45% | 15–16% | 13–14% | 11–12% |

Note: Assumes ₹3.7/kWh tariff, 70:30 debt-equity, 8.5% interest rate, 20-year project life
How to Calculate IRR for a Wind Energy Project

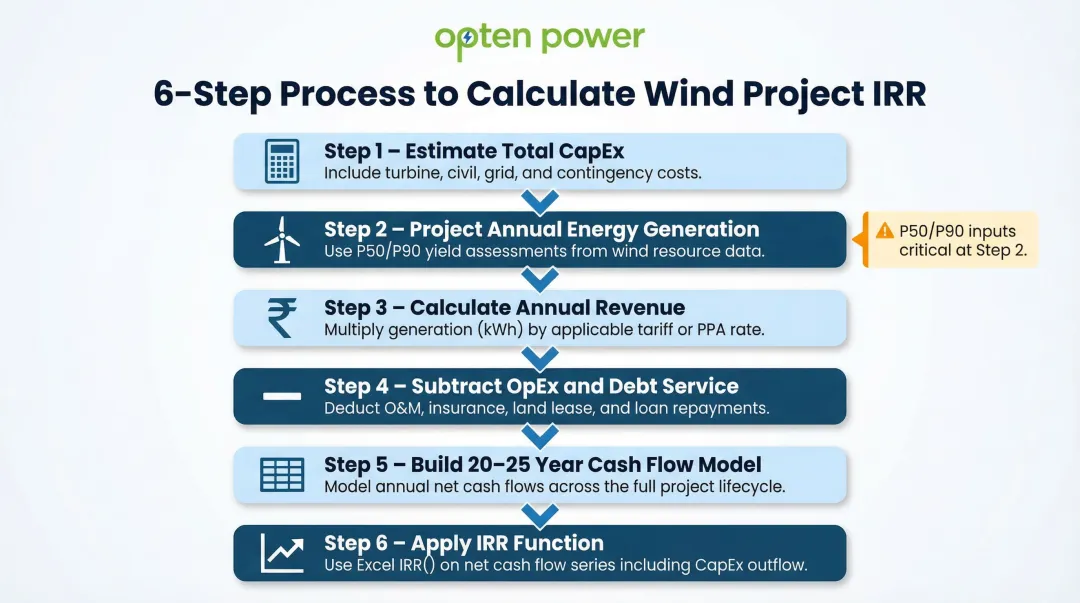

Step-by-Step IRR Calculation Process
- Estimate total CapEx: Include turbines, balance-of-system, grid connectivity, and soft costs
- Project annual energy generation: Use P50 wind yield assessment and net capacity factor
- Calculate annual revenue: Apply contracted PPA tariff or expected tariff escalation
- Subtract annual OpEx and debt service: Account for fixed and variable O&M costs
- Build 20–25-year cash flow model: Include all inflows and outflows
- Apply IRR function: Calculate the discount rate where NPV equals zero
Key Modeling Assumptions
These assumptions can shift IRR by 1–2 percentage points — get any one wrong and your projections drift:
- Degradation rate: Studies indicate 0.53% per year for wind turbines
- Inflation escalation on O&M: Typically 3–5% annually
- Terminal value assumptions: Asset value at end of project life
- Tax treatment: 40% accelerated depreciation in Year 1 in India
- P50 yield: Median production estimate with 50% probability of being exceeded
Note that Indian banks typically lend based on more conservative P90 estimates (90% probability of exceeding) to ensure debt service coverage.
Managing these variables across multiple projects in a spreadsheet model is where most analysis breaks down — assumptions drift, comparisons become inconsistent, and decisions slow.
IRR Analysis with Opten Power
Opten Power addresses this by aggregating real-time data on DISCOM tariffs, developer project costs, and regulatory variables across 16 Indian states into a single platform. It delivers IRR and payback analysis on demand, with standardized inputs that make comparing projects side by side straightforward.
Strategies to Improve Wind Project IRR
Optimize Site Selection and Technology Choice
Selecting high-wind-resource sites (P50 wind speed above 7 m/s) and pairing them with appropriately sized turbines directly maximizes capacity factor and IRR. India's best onshore sites average 6–7 m/s wind speeds.
Technology optimization:
- Deploy high rotor-to-generator ratio turbines for low-wind sites — the Vestas V155-3.3 MW, for instance, improves annual energy production by >3% for 300 MW wind parks in India
- Prioritize sites where capacity factor gains are achievable: a 5-percentage-point improvement (from 35% to 40%) adds roughly 1.5–2 points to project IRR
- Model P50/P90 wind estimates from multiple independent consultants before committing to a site

Leverage Favorable Financing and Tax Incentives
Once the energy baseline is set by site and technology choices, financing structure determines how much of that energy yield converts to investor returns. India's policy environment offers several tools to optimize this:
- Accelerated depreciation: 40% in Year 1 reduces taxable income in the critical early years, improving after-tax cash flows when debt service is highest
- ISTS waiver: 100% waiver for 25 years saves significant transmission costs
- GST exemptions: Reduce upfront capital requirements
- Competitive debt rates: Secure rates below 9% from IREDA, SBI, or green bonds
Increasing debt ratio from 60:40 to 70:30 at 8.5% interest can boost levered IRR by 2–3 percentage points.
Structure Long-Term Corporate PPAs Strategically
Favorable financing relies on predictable revenue. Long-duration Corporate PPAs (15–25 years) with creditworthy C&I buyers provide that certainty — reducing the risk premium in the discount rate and improving the IRR a lender will finance against.
Ideal C&I buyer segments for wind:
- Steel plants
- Cement facilities
- Textile manufacturers
- Data centers (hybrid with solar)
- Heavy industries with 24x7 operations
Opten Power's Corporate PPA marketplace gives wind developers access to pre-qualified C&I buyers across 16 states in India, with automated RFPs and pre-approved contracts that cut typical deal timelines by around 50%.
IRR vs. Other Financial Metrics for Wind Projects
IRR vs. LCOE
LCOE (Levelized Cost of Energy) measures the average cost per MWh of electricity generated over a project's life—it's a cost metric. IRR measures profitability from an investor's perspective—it's a return metric.
Both are needed: LCOE benchmarks competitiveness, IRR determines investability. A project with low LCOE can still have poor IRR if the PPA tariff is below market or if financing costs are high. India's 2024 onshore wind LCOE was USD 0.048/kWh.

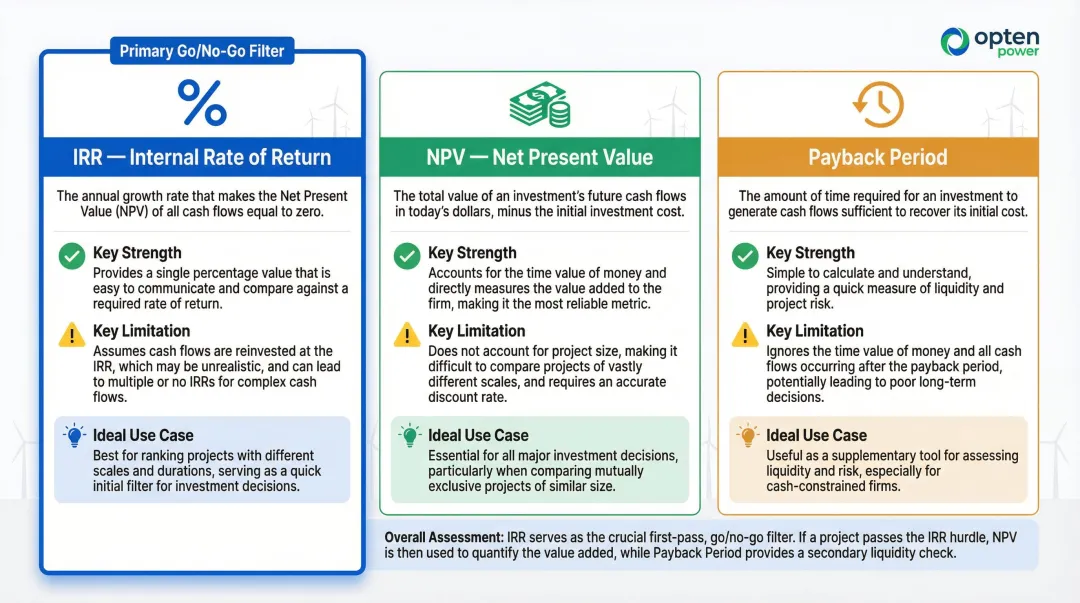

IRR vs. Payback Period vs. NPV
Each metric answers a different question — and each has a blind spot:
- Payback period: How long until you recover the initial investment. Fast to calculate, but it ignores all cash flows after payback and the time value of money. Good for quick screening; not sufficient for project finance decisions.
- NPV (Net Present Value): Shows absolute value creation in rupee terms, but the output shifts significantly depending on your chosen discount rate. A project with strong NPV at 8% can look weak at 12%.
- IRR: Discount-rate-independent, which makes it easier to compare projects of different sizes, structures, and geographies without anchoring to an assumed rate.

Wind energy investors and C&I buyers typically use all three together, with IRR as the primary go/no-go filter.
Frequently Asked Questions
What is the cost of 1 MW windmill?
A 1 MW wind turbine in India typically costs ₹5–8 crore (turbine only), with total installed project cost ranging from ₹7–10 crore per MW depending on site, turbine technology, and state-specific requirements. CERC benchmarks average costs at ₹7.9 crore/MW for 2024–2026.
What is a good IRR for a wind energy project?
A "good" unlevered IRR for onshore wind typically falls between 8–12% globally, with levered IRR of 10–15% considered attractive for institutional investors. In India, well-sited projects can reach 12–16% levered IRR — strong performance for infrastructure-class assets.
How does capacity factor affect IRR in wind projects?
Capacity factor is the most sensitive variable in wind IRR modeling. A project generating at 40% capacity factor will meaningfully outperform one at 25–30% with all other inputs equal. A 5% improvement in capacity factor (e.g., 35% to 40%) can add 1.5–2 percentage points to project IRR.
What is the difference between IRR and LCOE for wind energy?
LCOE measures the average cost per MWh of energy produced (a cost benchmark), while IRR measures the return on investment for the project owner (a profitability metric). LCOE informs competitiveness against other generation sources, IRR determines whether the project clears the investor's hurdle rate.
What is the hurdle rate for wind energy investments in India?
Indian wind project hurdle rates typically range from 10–14% (levered IRR) for institutional investors, varying by project risk, state regulations, and offtake structure. C&I buyers evaluating captive wind projects often set higher internal hurdles of 15–20%+ based on their cost-of-capital assumptions.
How long does it take for a wind project to achieve its target IRR?
Wind projects are modeled over a 20–25 year financial life, with meaningful cash flow payback beginning in years 5–8 after commissioning. IRR is a time-weighted metric — not "achieved" at a single point, but realized across the full project lifecycle as revenues accumulate and debt is repaid.
