Internal Rate of Return (IRR) for Renewable Energy Projects: Complete Guide

Introduction

A 50 MW solar project in Rajasthan can look attractive on paper and still destroy capital if the returns don't clear the cost of debt. For commercial and industrial buyers and renewable investors in India, committing capital to projects with 20–25 year horizons requires one reliable number to anchor every decision: the Internal Rate of Return (IRR).

Unlike simple payback periods or Levelized Cost of Energy (LCOE), IRR accounts for the time value of money — making it the standard for comparing solar, wind, and hybrid projects across India's diverse state markets. By the end of this guide, you'll know how to calculate IRR, interpret the results, and identify the variables that make or break returns in Indian renewable projects.

TL;DR

  • IRR is the discount rate at which a renewable project's net present value equals zero, measuring the effective annualized return on investment
  • In India, utility-scale solar typically achieves 7.7–8.2% project IRR and 9.6–16% equity IRR; C&I captive projects deliver 14–18% project IRR and 15–20% equity IRR
  • IRR is calculated by modeling CAPEX, annual revenues, OPEX, and incentives, then solving iteratively for the rate that zeros out NPV
  • Tariff/PPA rates, capacity utilization, CAPEX, and accelerated depreciation (40% in Year 1) are the primary levers that move project IRR
  • Platforms like Opten Power enable C&I buyers to compare real-time IRR across multiple renewable developers instantly, eliminating manual modeling complexity

What Is IRR and Why Does It Matter for Renewable Energy?

Defining IRR in Plain Terms

IRR is the discount rate at which the net present value (NPV) of all project cash flows — both inflows and outflows — equals zero. A project with an IRR above the investor's required rate of return (hurdle rate) is considered financially viable. Put directly: IRR tells you the effective annualized return you'll earn on your investment over the project's life.

Core Inputs That Feed Into a Renewable Energy IRR Model

To calculate IRR accurately, you need:

  • Initial CAPEX: Equipment (modules/turbines), civil works, grid connection, and land acquisition
  • Annual cash inflows: PPA or tariff revenues, REC income, and accelerated depreciation tax benefits
  • Annual OPEX: O&M costs, land lease, insurance, and AMC contracts
  • Project life — typically 20–25 years per CERC regulations
  • Discount or financing rate, used to benchmark against the calculated IRR

Project IRR vs. Equity IRR: Understanding the Difference

Project IRR measures return on total capital before financing — it represents the project's standalone economics regardless of how it's funded.

Equity IRR is calculated after debt servicing and reflects the return to equity holders only. Because leverage amplifies both gains and losses, equity IRR is typically higher than project IRR when debt is involved.

Developers and financiers often cite different IRR figures for the same project — and both can be accurate. For C&I buyers evaluating captive projects, project IRR is the more relevant benchmark. For financial investors structuring leveraged deals, equity IRR matters most.

IRR vs. Related Metrics: A Quick Comparison

Knowing which metric to use matters. Here's how IRR compares to the other figures commonly cited in renewable energy evaluations:

MetricWhat It MeasuresBest Use Case
IRRAnnualized return rateComparing projects with different sizes and timelines
NPVAbsolute profit in currency termsSizing decisions when choosing between investment scales
Payback PeriodYears to recover investmentQuick screening, but ignores returns beyond breakeven

IRR versus NPV versus payback period comparison for renewable energy evaluation

IRR is preferred for multi-year capital comparison because it accounts for both the magnitude and timing of cash flows. In India's renewable sector — where PPAs often run 20–25 years and tariff structures vary by state — that time-sensitivity makes IRR especially useful for evaluating whether a project truly clears your hurdle rate.

How to Calculate IRR for a Renewable Energy Project – Step by Step

IRR cannot be solved algebraically — it's found through iteration. Start with the NPV formula (sum of discounted future cash flows minus initial investment), set NPV to zero, and solve for the discount rate that satisfies this condition. Excel's =IRR() function automates the iteration. The five steps below walk through each input in sequence.

Step 1 – Define Project Parameters

Lock in your technical and commercial inputs before building any cash flow model:

  • Installed capacity (MW) and technology type: solar PV, wind, or hybrid
  • Plant location: determines irradiance or wind speed assumptions
  • Project life: 25 years per CERC norms
  • Degradation rate: 0.45% per year for Tier-1 solar panels

These inputs are the single biggest driver of IRR reliability. Overstating capacity utilization or understating degradation inflates projected returns — and leads directly to poor investment decisions.

Step 2 – Estimate Initial Investment (CAPEX)

Year 0 capital outflow typically includes:

  • Module or turbine cost, inverters, and mounting structures
  • Civil and electrical works
  • Grid interconnection charges
  • Land acquisition or lease
  • Development and EPC fees

Current CAPEX benchmarks in India:

Technology₹ Cr/MWUSD/W
Utility-scale solar₹3.84–₹6.61 Cr/MW$0.525–$0.771/W
Onshore wind₹6.7–₹9.1 Cr/MW
C&I rooftop solar₹4–₹5 Cr/MW

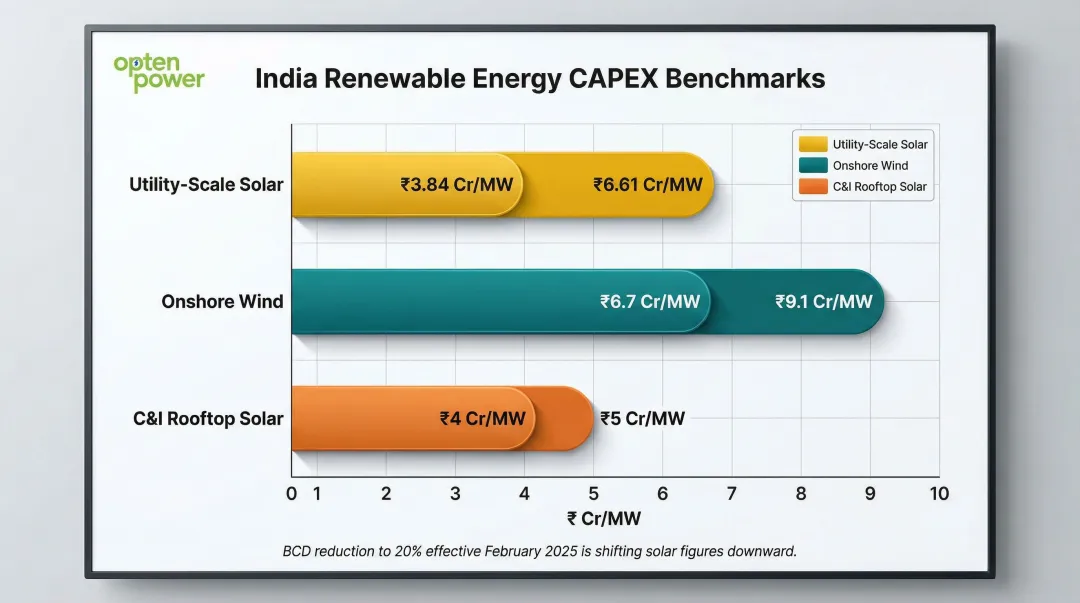

India renewable energy CAPEX benchmarks comparison across solar wind and rooftop technologies

CAPEX varies by technology, project scale, and state. The reduction of Basic Customs Duty from 40% to 20% on solar modules (effective February 2025) has already shifted these figures downward for new projects.

Step 3 – Project Annual Cash Inflows

Revenue for each year = Annual Energy Generation (kWh) × Tariff or PPA Rate (₹/kWh)

Beyond the core tariff, include:

  • Renewable Energy Certificate (REC) income
  • Accelerated depreciation tax benefit (40% in Year 1 under Section 32 of the Income Tax Act)
  • Performance-based incentives

Apply the degradation rate to reduce generation each year. For wind, consult manufacturer warranties for the applicable rate.

A 1 MW solar plant generating 1.5 million kWh in Year 1 (CUF of 17%) at ₹4.50/kWh yields ₹67.5 lakhs. By Year 2, with 0.45% degradation, generation drops to 1.493 million kWh — revenue falls to ₹67.2 lakhs. That compounding effect over 25 years is material.

Step 4 – Estimate Annual Cash Outflows (OPEX)

Recurring annual costs to model:

  • O&M charges (fixed ₹/MW/year or variable)
  • Land lease or rent
  • Insurance premiums (typically 0.3–0.5% of CAPEX)
  • AMC contracts for inverters and other equipment
  • Debt servicing (for project-level IRR, include annual repayments and interest)

OPEX typically escalates at 3–5% per year. CERC mandates 5.89% annual O&M escalation for tariff calculations, based on a 60:40 WPI/CPI weighting. In a 25-year model, a 1% underestimate in escalation can shave 50–80 basis points off your terminal IRR — worth checking before finalizing assumptions.

Step 5 – Solve for IRR

Compile all cash flows into a time-series:

  • Year 0: Negative number (net investment after subtracting any upfront incentives)
  • Years 1–25: Positive net annual cash flows (revenue minus OPEX minus debt servicing)

Apply Excel's =IRR() to the cash flow column, or use a dedicated financial modeling tool.

Compare the output against your hurdle rate or Weighted Average Cost of Capital (WACC). If IRR exceeds the hurdle rate, the project clears the financial viability threshold. For renewable projects in India, typical hurdle rates run 8–12% for utility-scale projects and 12–15% for C&I captive projects.

Renewable Energy IRR Calculation: A Practical Worked Example

Hypothetical Scenario: 1 MW Captive Solar Project for a C&I Consumer

Assumptions (illustrative only):

  • Installed capacity: 1 MW
  • Gross CAPEX: ₹4.5 Cr
  • Net CAPEX (after accelerated depreciation benefit): ₹2.7 Cr (assuming 40% depreciation benefit monetized in Year 1)
  • Annual generation (Year 1): 1.5 million kWh (CUF of 17%)
  • PPA/avoided cost tariff: ₹5.00/kWh
  • Annual OPEX: ₹3 lakhs in Year 1, escalating at 5% per year
  • Panel degradation: 0.45% per year
  • Project life: 25 years

Year 0 Cash Flow

Net investment: ₹4.5 Cr (gross CAPEX) - ₹1.8 Cr (accelerated depreciation tax benefit) = ₹2.7 Cr outflow

Annual Cash Flows (Sample Years)

YearGeneration (kWh)Revenue (₹ lakhs)OPEX (₹ lakhs)Net Cash Flow (₹ lakhs)
11,500,00075.03.072.0
21,493,25074.73.271.5
51,473,00073.73.670.1
101,434,00071.74.767.0
251,344,00067.27.859.4

1 MW captive solar project 25-year cash flow model showing revenue OPEX and net returns

Calculated IRR

Applying the =IRR() function to this cash flow series (Year 0: -₹2.7 Cr; Years 1–25: as shown above) yields an IRR of approximately 26%.

What this means: If this IRR exceeds the typical hurdle rate for C&I renewable projects (12–15%), the investment is financially justified. This example illustrates why C&I captive projects typically deliver equity IRRs of 15–20%: high avoided grid tariffs translate directly into strong returns.

Common Modeling Mistakes That Distort IRR

These results are only as reliable as the inputs. Three errors consistently inflate IRR in C&I solar models:

  • Overstating CUF: Using 22% CUF when 17% is realistic inflates revenue projections. A 1–2% CUF drop reduces IRR by 100–150 basis points.
  • Ignoring panel degradation: Assuming flat generation across 25 years overstates long-term cash flows. Applying 0.45% annual degradation instead of 0% reduces IRR by 50–100 basis points.
  • Treating accelerated depreciation as cash revenue: Accelerated depreciation is a tax shield, not a cash inflow. It must be netted against actual tax liability — not recorded as ₹1.8 Cr income in Year 1.

Conservative modeling should instead:

  • Use location-specific irradiance data for CUF estimates
  • Apply Tier-1 manufacturer degradation warranties (≤0.45% per year)
  • Model accelerated depreciation as a reduction in tax outflow

Key Factors That Influence IRR in Renewable Energy Projects

Tariff and PPA Rate

The contracted power sale price is the single largest driver of IRR. Higher tariffs or well-structured PPA escalation clauses (annual 3–5% tariff escalation, for example) significantly improve long-run returns.

Recent tariff benchmarks in India:

  • Utility-scale solar: ₹2.60–₹2.61/kWh (SECI Tranche XI, July 2023)
  • Firm and Dispatchable RE (FDRE): ₹4.98–₹5.16/kWh (SECI FDRE Tranche IV)
  • C&I open access: Variable, but landed costs rising due to cross-subsidy surcharges and wheeling charges

PPA structures in India:

  • Fixed-tariff PPAs: Stable revenue, but no inflation protection
  • Market-linked PPAs: Revenue fluctuates with market prices, adding risk
  • Captive/self-consumption models: Savings based on avoided grid tariff (₹10–₹15/kWh for many C&I consumers)

A 10% increase in tariff (say, from ₹4.50 to ₹4.95/kWh) can boost project IRR by 100–150 basis points.

Capacity Utilization Factor (CUF) and Resource Quality

CUF (for solar) or Plant Load Factor (PLF) for wind directly determines total annual generation and revenue. A 1–2 percentage point drop in CUF cuts IRR noticeably — as the example below shows.

CERC norms:

  • Solar PV: Minimum 21% CUF
  • Onshore wind: PLF norms range from 22% to 35%, based on annual mean wind power density

Example sensitivity: For a base case solar project with 15.15% pre-tax IRR, a 1% reduction in CUF lowers pre-tax project IRR to 14.08% and equity IRR from 15.22% to 13.49%.

Critical factors for CUF/PLF:

  • Accurate resource assessment (irradiance/wind speed data)
  • Technology selection (bifacial modules, tracker systems)
  • Project location (high-irradiance states like Rajasthan vs. lower-irradiance states)

Financing Structure and Cost of Debt

Equity IRR is highly sensitive to the debt-to-equity ratio and interest rate. Higher leverage amplifies equity IRR when project returns exceed the cost of debt, but increases risk.

Typical financing in India:

  • Normative D:E ratio: 70:30 (per CERC regulations)
  • Actual project finance: Often 80:20 for utility-scale projects
  • Debt pricing: 8.5–9.75% for post-COD term loans
  • Loan tenor: 15–20 years

Leverage impact: A utility-scale solar project with 7.7% project IRR yields 9.6% equity IRR at 70:30 leverage. Increasing leverage to 80:20 can push equity IRR to 12–13%. Refinancing at lower rates (such as 7.5% via bond markets) can boost equity IRR to 16%+.

Debt to equity leverage impact on equity IRR for utility scale solar projects in India

Government Incentives and Policy Benefits

Several India-specific policy levers can shift IRR by 50–200 basis points. Understanding each one matters when stress-testing a project model.

Accelerated depreciation: 40% in Year 1 under Section 32 of the Income Tax Act (reduced from 80% pre-2017). This tax shield significantly boosts equity IRR for projects with strong taxable income.

Basic Customs Duty (BCD): Reduced from 40% to 20% on solar modules (effective February 2025), lowering CAPEX by 5–10% and improving IRR by 50–100 basis points.

GST structure: Composite EPC contracts taxed at 70:30 ratio (70% goods at 12%, 30% services at 18%), affecting effective CAPEX.

Renewable Purchase Obligation (RPO) compliance value: RECs generated from projects can be sold to obligated entities, adding revenue.

State-level subsidies: Vary by state; some offer capital subsidies or wheeling charge exemptions.

BCD and GST adjustments have shifted project CAPEX by 5–10% in recent cycles. Any IRR model should include a dedicated policy sensitivity scenario to capture this risk.

OPEX Escalation and O&M Quality

Underestimating O&M escalation or degradation rates erodes later-year cash flows and overstates IRR — often by more than investors expect.

Conservative modeling requires:

  • Realistic degradation rates: Use Tier-1 manufacturer warranties (≤0.45% per year for solar). A 0.5% higher annual degradation rate can reduce 25-year IRR by 50–100 basis points.
  • OPEX escalation: Model 5–6% annual escalation (CERC mandates 5.89% for tariff calculations). Assuming flat OPEX inflates IRR by 50–100 basis points.
  • Quality O&M contracts: Poor maintenance accelerates degradation and increases unplanned downtime, reducing actual generation below modeled levels.

How Opten Power Can Help

Opten Power is India's unified clean energy marketplace built for C&I buyers, investors, and developers who need financial clarity fast. The platform delivers instant IRR, payback, and regulatory analysis — so you can compare tariffs, savings, and returns across multiple developers side by side, without building a single spreadsheet model.

Key Platform Capabilities

  • Access 4+ GW of pre-vetted solar, wind, and hybrid projects spanning 16 states
  • Real-time Discom intelligence with standardized state-level landing prices — so you never overpay on cost comparisons
  • Portfolio management dashboard to track returns across all assets from one interface
  • Automated RFPs and pre-approved contracts that close deals 50% faster, with PPA templates across Capex, Group-Capex, and Third-Party Open Access models

Opten Power platform dashboard displaying renewable project IRR comparisons across multiple developers

Ready to Compare Renewable Project IRRs Without Spreadsheets?

Compare renewable project IRRs across India's leading power producers — without manual modeling or spreadsheet complexity. Visit app.optenpower.com or call +91 78959 41766 to get started.

Frequently Asked Questions

What is IRR in renewable energy?

IRR in renewable energy is the annualized rate of return a project is expected to generate over its lifetime. It is the discount rate that makes the net present value of all project cash flows (revenues minus costs) equal to zero, and it is used to assess whether a project meets an investor's required return threshold.

What is a good IRR for a project?

A "good" IRR depends on asset class, risk profile, and market. In India, utility-scale solar and wind typically achieve project IRRs of 7.5–8.2% and equity IRRs of 9.6–16%, while C&I captive projects deliver project IRRs of 14–18% and equity IRRs of 15–20%. Any IRR above the cost of capital — roughly 8–12% for most renewable projects — is considered acceptable.

What is the average IRR for solar projects?

In India, utility-scale solar achieves base case project IRRs around 7.7% and equity IRRs of 9.6–16% depending on leverage. C&I rooftop or captive solar delivers higher returns — project IRRs of 14–18% and equity IRRs of 15–20% — driven by avoided grid tariffs and accelerated depreciation benefits.

Is 30% IRR high?

Yes, a 30% IRR is exceptionally high for most infrastructure or energy investments. Standard renewable energy project IRRs in India range from 7.5–18% depending on segment. A 30% figure may appear in equity IRR calculations for highly leveraged projects with extreme optimization (self-EPC margins, carbon credits, InvIT sales), but verify the assumptions behind leverage ratios and cost structures before accepting it.

What is the rate of return on wind turbines?

Onshore wind projects in India typically generate project-level IRRs around 7.5%, with equity IRRs ranging from 8.9% to 19% depending on leverage, financing structure, and self-EPC margins. Returns depend heavily on wind resource (PLF), land costs, O&M complexity, and tariff rates.

What is the return on equity for renewable energy?
