Introduction
Selling a renewable energy asset at the right price—to the right buyer, at the right time—is harder than most developers expect. India's installed capacity has crossed 200 GW, and as policy tailwinds attract fresh capital, developers and IPPs are increasingly recycling operational assets to fund new projects. The M&A pipeline is active, but outcomes vary sharply.
Asset health, valuation methodology, buyer targeting, and regulatory compliance all directly affect the final sale price. Poor preparation leaves 15–25% of potential value on the table, while rushed transactions frequently collapse during due diligence.
This guide covers when to sell, what to prepare, how to secure the right valuation, the exact steps from listing to closing, and common mistakes to avoid: everything sellers need to maximize exit value in India's competitive renewable M&A market.
TL;DR
- Selling involves five stages: asset audit, valuation, documentation, buyer discovery, and negotiation
- Value hinges on PPA tenure, actual generation performance, grid connectivity, and DISCOM creditworthiness
- Buyers demand clean documentation, verified generation data, and regulatory approvals before proceeding
- Under-prepared sellers consistently receive 15–25% lower valuations — documentation gaps are the leading cause
- Platforms like Opten Power with pre-vetted buyers and standardized workflows close deals up to 50% faster
How to Sell a Renewable Energy Asset: Step-by-Step
Step 1: Conduct a Pre-Sale Asset Audit
Technical Audit
Run a comprehensive technical assessment covering:
- Plant health and equipment condition (inverters, modules, turbines)
- O&M records and maintenance schedules
- Actual vs. projected generation performance (PLF/CUF)
- Underperformance issues requiring resolution before listing
Buyers benchmark actual generation against the original Detailed Project Report (DPR). Consistent underperformance—even if explainable—reduces projected IRR and lowers bid prices.
Financial Audit
Review financial records including:
- Revenue records and PPA invoices for the past 3 years
- Outstanding liabilities and loan covenants
- Lender NOC requirements (many lenders have first right of refusal or pre-approval clauses)
- Accumulated Renewable Energy Certificates (RECs) representing monetizable value
According to project finance documentation standards, lenders typically require explicit consent for change-of-control transactions, making early lender engagement critical.
Step 2: Get a Professional Asset Valuation

Engage an independent valuer to determine fair market value using:
- Discounted Cash Flow (DCF): Projects future cash flows based on generation, tariff, and operating costs
- Comparable transaction multiples: ₹/MW or EV/EBITDA benchmarks from recent deals
- Replacement cost: Current cost to build an equivalent asset
Document all assumptions: tariff rates, degradation rates, O&M costs, and discount rates. That said, valuation is a range—not a single number. Buyer type, deal structure (full asset vs. equity stake), and market timing all shift where within that range a final price lands.

Step 3: Prepare Documentation and Legal Clearances
Compile a complete data room including:
- Land documents (lease agreements or ownership titles)
- Grid connectivity and evacuation agreements
- DISCOM Power Purchase Agreement
- Environmental and regulatory clearances
- Equipment warranties and O&M contracts
- Corporate documents and audited financials (minimum 3 years)
Verify all state-level regulatory approvals are current. Unresolved disputes with DISCOMs, State Load Dispatch Centers (SLDCs), or government authorities are a leading cause of deal failure during due diligence.
Step 4: Identify and Qualify Buyers
Buyer Categories
Map potential buyers by type:
- Strategic buyers: Larger IPPs and utilities seeking portfolio expansion
- Financial investors: Infrastructure funds, private equity, sovereign wealth funds
- Industrial buyers: Companies seeking captive renewable assets
Each category has different valuation frameworks, risk appetites, and timelines.
Buyer Discovery
Use marketplaces to reach multiple vetted buyers simultaneously. Platforms like Opten Power connect sellers to qualified buyers across 16 states with pre-approved deal structures, closing transactions up to 50% faster through automated RFPs and standardized contracts—compared to the slower pace of bilateral outreach.
Step 5: Negotiate Terms, Complete Due Diligence, and Close
Negotiation
Align on key commercial terms via term sheet:
- Enterprise value and equity value
- Treatment of existing debt
- PPA transition and O&M contract assignment
- Representations and warranties
Due Diligence
Expect buyer-side due diligence covering technical, legal, financial, and regulatory dimensions. Allocate 4–8 weeks and ensure the data room is complete upfront to avoid delays.

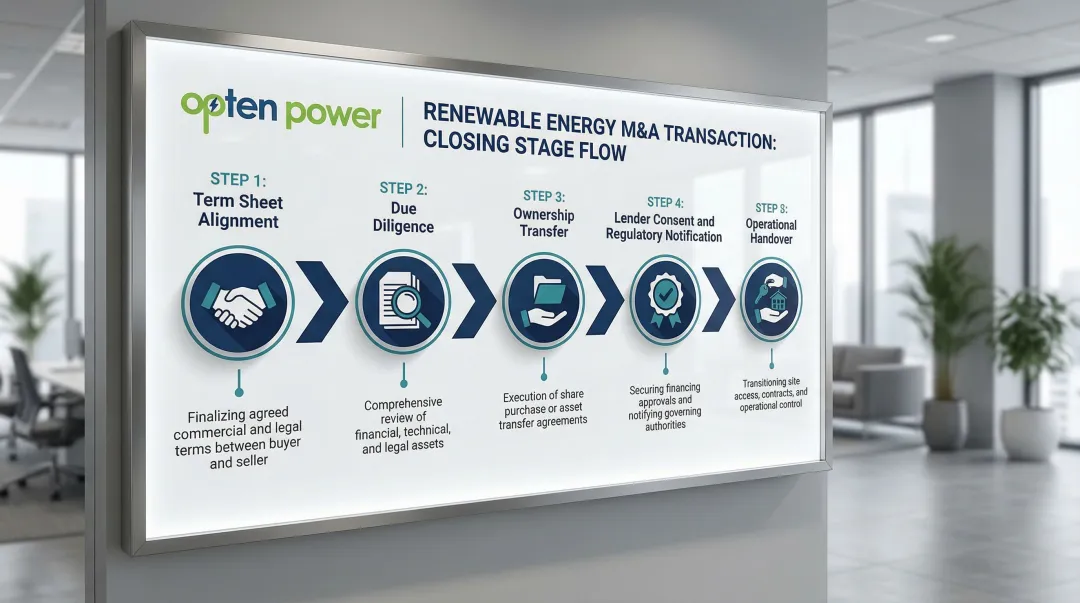

Closing
Final closing involves several coordinated steps:
- Transfer ownership via share transfer or asset transfer
- Obtain lender consent and notify DISCOM and regulatory bodies
- Hand over operational control with documented handover protocols

Engage a legal advisor experienced in Indian energy M&A throughout this stage.
What to Prepare Before You List Your Renewable Energy Asset
Most renewable energy asset deals stall — or price down — because of documentation gaps discovered during due diligence. Getting your asset ready before listing isn't just housekeeping; it directly affects both the offer you receive and how quickly you close.
Technical Readiness
Buyers will scrutinize generation performance first. Make sure your technical records leave no room for doubt.
- Resolve known equipment defects before buyer inspections begin
- Confirm all O&M maintenance schedules are current and documented
- Prepare recent generation data (monthly and annual PLF or CUF)
- Benchmark actual output against original DPR projections — unexplained gaps trigger valuation discounts
Financial and Commercial Readiness
Clean financials reduce negotiation friction. Buyers price in ambiguity, so leaving loose ends costs you.
- Organize 3 years of audited financials, including any DISCOM payment delay history and security mechanisms
- Reconcile all PPA invoices and receivables — outstanding amounts need clear aging schedules
- Clarify status of government subsidies, RPO incentives, and accumulated RECs
- Unaccounted RECs are often left on the table — quantify them explicitly, as they represent monetizable value in the transaction
Legal and Regulatory Readiness
Legal ambiguities are the most common deal-killers. Address these before a buyer's legal team finds them.
- Confirm land title clarity, particularly for multi-parcel or leased land arrangements
- Verify all environmental, forest, and construction clearances are valid and transferable to the new owner
- Obtain lender NOC or pre-approval if the asset carries project debt
- Map out state-specific approval requirements early — regulations governing ownership changes vary across India's 16+ state jurisdictions and can add months to your timeline if addressed late

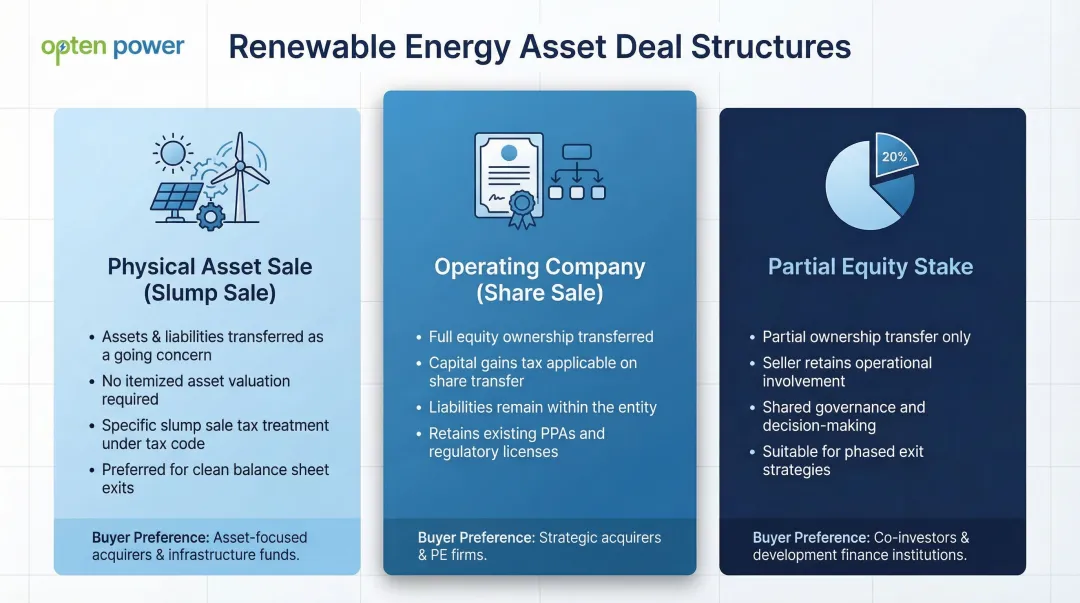

Structuring the Deal Format
Decide upfront whether you're selling:
- Physical asset (slump sale or direct asset transfer — a structure where assets and liabilities are transferred as a going concern)
- Operating company (share sale)
- Partial equity stake
Each structure carries different tax treatment, lender implications, and buyer preferences — and the wrong choice can shrink your buyer universe significantly. Lock in your preferred structure with a tax advisor before you go to market, not after you receive offers.

Key Factors That Determine the Value of Your Renewable Energy Asset
Asset valuation is not based on installed capacity alone—buyers price in risk-adjusted cash flows.
Remaining PPA Tenure and Tariff Quality
Long-tenor PPAs (10+ years remaining) with creditworthy offtakers command premium valuations. Central government utilities typically receive higher valuations than state DISCOMs due to payment reliability.
Assets with expired or soon-expiring PPAs are valued significantly lower unless the seller demonstrates a credible re-contracting pathway. Plant performance tells a similar story at the asset level.
Actual Plant Performance (PLF/CUF)
Actual generation relative to P50/P90 projections is among the first metrics buyers examine. According to ICRA's rating methodology for wind power producers, consistent underperformance reduces projected IRR and directly lowers bid prices.
Grid Connectivity and DISCOM Health
Two interconnected factors drive risk assessment here:
- Evacuation reliability: Assets with low curtailment history and stable grid access fetch higher multiples. Transmission constraints directly erode revenue predictability.
- DISCOM receivables: Payment delays or arrears from the state DISCOM signal counterparty risk. Buyers scrutinize receivables aging closely, particularly for state-level offtakers.
Debt Structure and Lender Obligations
Existing project debt affects equity value calculation (enterprise value minus net debt). Current market rates for renewable project finance from institutions like Power Finance Corporation (PFC) and REC Limited range from 8.95% to 9.70%.

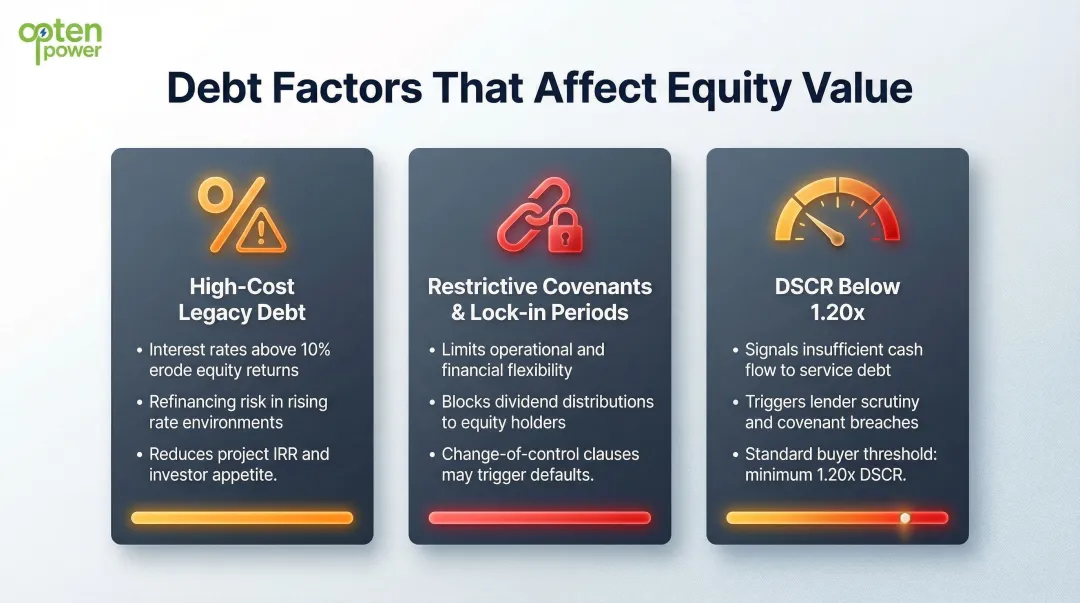

Key debt considerations buyers flag:
- High-cost legacy debt (above 10%) may require refinancing before sale
- Restrictive covenants or lender lock-in periods complicate transactions
- Minimum Debt Service Coverage Ratio (DSCR) of 1.20x is standard; assets below this face financing challenges

When Is the Right Time to Sell Your Renewable Energy Asset?
Timing a renewable energy asset sale correctly can mean the difference between a strong exit and a discounted one. The decision hinges on a combination of financial performance, market conditions, and operational realities specific to India's RE landscape.

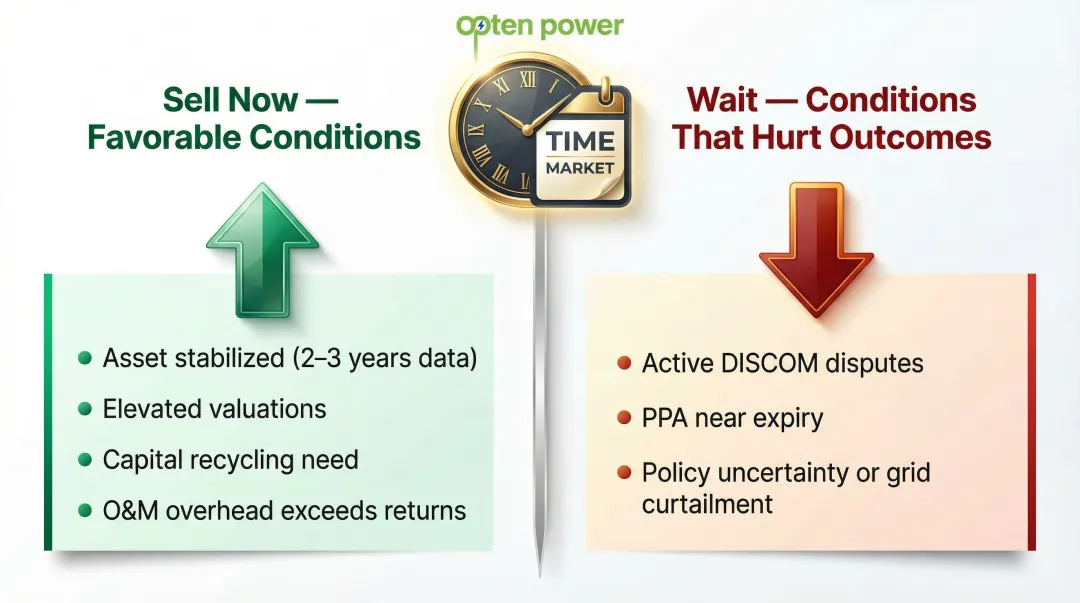

Favorable Conditions to Sell
- After asset stabilization (2–3 years of consistent generation data)
- When valuations are elevated — typically during periods of strong RPO compliance demand or active foreign capital inflows into Indian RE
- When developers need capital to recycle into earlier-stage or higher-return projects
- When managing multi-state assets creates O&M overhead that outweighs the returns of continued ownership
Timing matters just as much on the downside. Selling under the following conditions typically compresses valuations or stalls deals entirely.
Conditions That Hurt Sale Outcomes
- Active DISCOM disputes or payment arrears
- Plants approaching end-of-PPA with no extension in sight
- Periods of state-level policy uncertainty or significant grid curtailment that undermines generation track records

Common Mistakes When Selling Renewable Energy Assets
Most deals that fail or reprice downward share the same root causes. Avoiding these four mistakes before you go to market significantly improves your outcome.
Skipping Pre-Sale Preparation
Many sellers list assets without resolving pending regulatory issues, incomplete land records, or underperformance gaps. These surface during buyer due diligence — and either kill deals or force price renegotiation downward.
Overpricing Based on Installed Capacity Alone
Sellers frequently anchor on nameplate capacity — a per-MW figure — rather than cash flow-based valuation. Buyers use IRR-based models and walk away when seller expectations don't reflect actual performance or risk.
Approaching Only One or Two Buyers
Bilateral negotiations without competitive tension almost always result in lower prices. Running a structured process with multiple qualified buyers achieves fair market value and protects your negotiating leverage.
Underestimating Regulatory and Lender Timelines
Failing to budget time for DISCOM intimation, state regulatory approvals, and lender NOC causes deal timelines to slip — often by months. Build these clearances explicitly into your transaction plan from day one.
Frequently Asked Questions
How do you sell RECs (Renewable Energy Certificates)?
RECs are sold through CERC-accredited power exchanges such as IEX or PXIL in India by registered generators meeting eligibility criteria. RECs represent the green attributes of electricity generation and are traded separately from the physical power itself.
Is selling back to the grid worth it for renewable energy asset owners?
Grid-connected renewable assets generate revenue through PPAs or merchant sales to the grid. The key variables are the tariff achieved, DISCOM payment reliability, and whether ongoing revenue streams outweigh the lump-sum exit value from a full asset sale.
What documents are required to sell a renewable energy asset in India?
Core document categories include:
- Land records and title documents
- Grid connectivity and evacuation agreements
- Signed PPA
- Environmental and regulatory clearances
- Audited financials
- Corporate/entity documents
- Lender NOC
How is a solar or wind power plant valued before sale?
Indian renewable assets are typically valued using Discounted Cash Flow (DCF) analysis based on projected generation, remaining PPA tenure, and operating costs, supplemented by comparable transaction multiples on a ₹/MW or EV/EBITDA basis.
What taxes apply when selling a renewable energy asset in India?
A share sale is subject to capital gains tax on equity, while an asset/slump sale is subject to capital gains on individual assets or business transfer rules. Applicable rates depend on holding period (short-term vs. long-term) and deal structure. Consult a tax advisor for transaction-specific guidance.
Can foreign investors or funds buy renewable energy assets in India?
FDI in the renewable energy sector is permitted under the automatic route in India, making infrastructure and PE funds frequent acquirers. Specific sector regulations, FEMA compliance, and RBI remittance rules must be adhered to during transactions.
