Introduction
At 3GW, an onshore wind project crosses into a different category entirely — enough to power approximately 3-5 million homes and match the output of multiple conventional coal or gas plants. Global benchmarks like Saudi Arabia's $8.3 billion PIF5 program (a 1GW Shaqra site and a 2GW Starah site) and the US's 3GW Chokecherry and Sierra Madre project in Wyoming show that gigawatt-scale wind is becoming the industry standard, not the exception.
Developing a project at this scale is a decade-long process — and it is rarely straightforward. Challenges that barely register at 100-500MW become critical risk factors at 3GW:
- Regulatory clearances across multiple central and state agencies
- Capital deployment exceeding ₹15,000-18,000 crore
- Grid infrastructure that can take 3-5 years to commission
- Turbine logistics requiring specialized permits and night-movement clearances
- Multi-party offtake arrangements spanning DISCOMs, corporate buyers, and merchant markets
Each of these carries compounding risks that smaller projects simply don't face.
This guide covers the full development and implementation lifecycle of a 3GW onshore wind project: from site selection and regulatory strategy through EPC execution, grid integration, financing structures, and long-term operations. It is written for developers, investors, and large industrial energy buyers who need to understand what this scale of project actually demands.
TLDR
- A 3GW onshore wind project requires 300-600 turbines, roughly 1,20,000–2,10,000 acres of land, and 8–12 years from inception to full commissioning
- Five distinct phases drive development: pre-development (site selection + approvals), EPC execution, grid integration, financial close + offtake, and long-term O&M
- Transmission and grid evacuation infrastructure is the single most time-consuming bottleneck at this scale, often requiring dedicated 400kV or 765kV lines
- Financing typically combines 70:30 debt-to-equity project finance from REC, PFC, or DFIs, with long-term PPAs providing revenue certainty
- C&I buyers can secure 20–25 year corporate PPAs from large wind projects, typically delivering 30–40% savings versus grid tariffs
What Separates a 3GW Project from Standard Wind Development
Most wind projects in India are developed in the 100–500MW range. A 3GW project is an order-of-magnitude larger in complexity, not just capacity. Large Indian developers — including those executing SECI-tendered gigawatt-scale blocks — routinely split 3GW targets into phased sub-projects specifically to manage regulatory, logistics, and financing risk in parallel.
Coordination Challenges at Gigawatt Scale
The sheer scale creates coordination challenges that smaller projects never face:
- Multiple EPC contractors in parallel: No single contractor typically has the balance sheet or capacity to execute 3GW simultaneously — consortium models become the norm
- Multi-zone transmission planning: Evacuating 3GW requires active coordination between STUs and the CTU, often triggering dedicated ISTS infrastructure
- Centralized PMO: A project of this size needs a dedicated Project Management Office spanning permitting, engineering, finance, and multi-party stakeholder coordination
Stakeholder Complexity
Behind each of those coordination challenges sits a distinct set of stakeholders, each with competing priorities. At 3GW scale, that list grows considerably:
- National and state governments (MNRE, state nodal agencies, SERCs)
- Grid operators (STU, CTU, regional load dispatch centres)
- Local communities (hundreds of landowners across multiple villages or talukas)
- Equipment OEMs (turbine manufacturers, BoP suppliers)
- Lenders and equity investors (banks, DFIs, infrastructure funds)
- Offtakers (DISCOMs, C&I buyers, merchant market participants)
Managing this many counterparties simultaneously is why 3GW projects require formal governance structures, risk allocation matrices, and multi-year phased execution plans — tools that are optional at 200MW but unavoidable at this scale.
Phase 1 — Site Selection, Wind Resource Assessment & Regulatory Approvals
Wind Resource Assessment Process
Developers conduct long-term wind measurement campaigns using meteorological masts and LiDAR (Light Detection and Ranging) systems for 12-36 months to capture inter-annual variability. Measurements must comply with IEC 61400-12-1 standards to ensure bankability.
These campaigns generate P50 (median) and P90 (90% probability of exceedance) energy yield scenarios. The National Institute of Wind Energy (NIWE) estimates that India has 164 GW of wind potential at 150m hub height in zones with Capacity Utilization Factors (CUF) exceeding 35%—primarily in Gujarat, Rajasthan, Karnataka, Tamil Nadu, and Andhra Pradesh.
High-yield onshore wind zones in India typically achieve capacity factors of 30-40%, with the best sites exceeding 35% CUF.
Site Selection Criteria
At 3GW scale, a single contiguous site is rarely available. Developers must assemble land parcels across multiple villages or talukas, requiring simultaneous negotiation with hundreds of landowners and state revenue departments.
Key site selection parameters:
- Wind speeds of 6.5-8.5 m/s at hub height (120-150m) are the minimum threshold for commercial viability
- Land footprint of 40-70 acres per MW means a 3GW project needs 120,000-210,000 acres, though physical turbine occupation stays below 1%
- Proximity to 220kV or 400kV substations directly controls evacuation CapEx and connection timelines
- Shorter distance to load centres reduces line losses and improves overall project economics
- Avoiding forests, wildlife corridors, and wetlands prevents EIA delays that can add 12+ months to timelines
- Revenue land with clear titles is preferred over forest or community land, which requires complex multi-agency approvals
Regulatory Clearances & Permitting

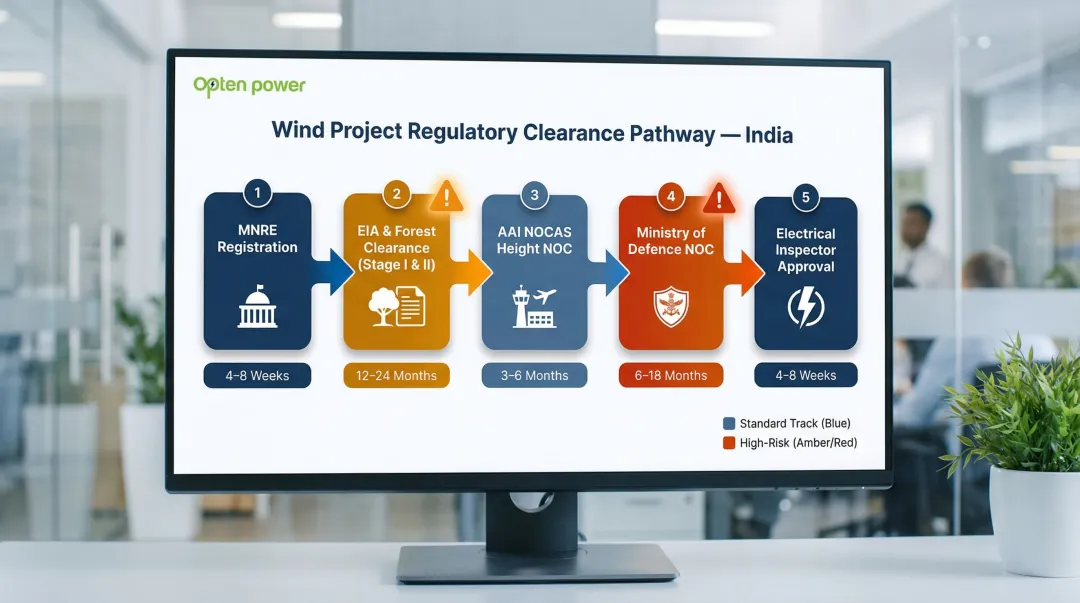

The sites identified through resource assessment immediately trigger a multi-layer permitting process — and at gigawatt scale, permitting timelines are one of the most consistent sources of schedule risk. Required approvals in India include:
Core Clearances:
- MNRE/state nodal agency project registration
- Environmental Impact Assessment (EIA) and forest clearance (Stage I and II)
- Aviation height NOC from AAI NOCAS
- Defence NOC from Ministry of Defence (categorized into Red, Yellow, Green zones)
- Electrical Inspector approvals
Forest clearances (Stage I and II) and MoD/AAI NOCs are the most consistent schedule risks, routinely delaying Indian megaprojects by 12-24 months. The AAI NOCAS process evaluates whether turbine heights obstruct navigable airspace; the MoD NOC alone can consume 60+ working days. Initiating these clearances during the wind resource assessment phase — not after — is the only way to avoid regulatory gridlock.

State Electricity Regulatory Commission (SERC) orders and Renewable Purchase Obligation (RPO) frameworks also shape project viability and offtake terms at the pre-development stage, especially for projects targeting DISCOM PPAs.
Phase 2 — Engineering, Procurement & Construction at Gigawatt Scale
EPC scope for a 3GW project typically follows a consortium model, as seen in the Saudi PIF5 project with CEEC Global and design institutes. Work is divided across specialized contractors handling civil works, turbine supply and erection, electrical balance of plant (BoP), and substation construction. How that work is structured — and how execution risk is shared — shapes project delivery across every phase.
Risks of EPC fragmentation vs. single-contractor models:
- Fragmented EPC reduces single-point execution risk but increases coordination complexity
- Single-contractor models simplify accountability but concentrate risk with one entity
- Phased construction (commissioning in 500MW-1GW tranches) reduces financing risk and allows early revenue generation to support ongoing construction cash flows
Turbine Selection & Procurement

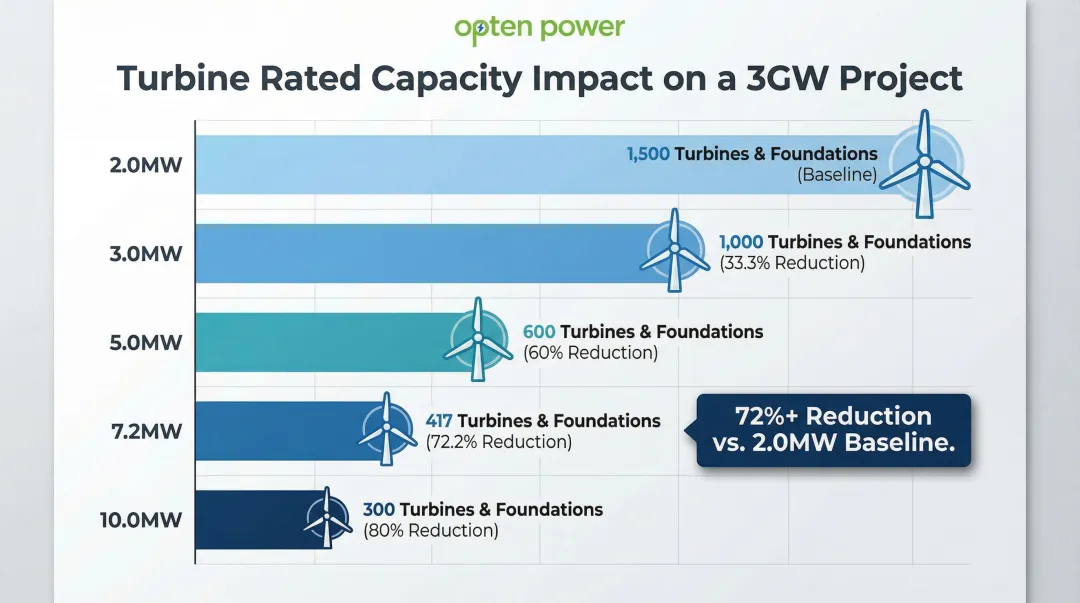

Modern turbines in the 5-10MW range are increasingly preferred for gigawatt-scale projects. Leading OEMs offer models like the Siemens Gamesa SG 5.0-145 (5.0 MW, 145m rotor), the Vestas V162-7.2 MW, and the GE Vernova 6.1 MW-158m. Envision has even unveiled a 10MW onshore turbine (EN220/10MW).
Impact of Higher-Rated Turbines on 3GW Projects:
| Turbine Rating (MW) | Turbines Required | Foundations Required | % Reduction vs 2.0MW |
|---|---|---|---|
| 2.0 | 1,500 | 1,500 | 0.0% |
| 3.0 | 1,000 | 1,000 | 33.3% |
| 5.0 | 600 | 600 | 60.0% |
| 7.2 | 417 | 417 | 72.2% |
| 10.0 | 300 | 300 | 80.0% |

Upscaling from a 2.0MW turbine to a 7.2MW model reduces total turbine and foundation counts by over 70%, significantly lowering civil works, access roads, and crane lift requirements. Those larger turbines, however, create direct logistical constraints that must be planned well in advance.
Logistics Challenges at Gigawatt Scale
Transporting 5-10MW turbine components — particularly blades exceeding 70-80 meters — creates significant transport and supply chain constraints:
- Blade transportation — Length restrictions, MoRTH/NHAI overlength permits, night-movement rules, and specialized escorts are mandatory for blades over 60m
- Nacelle weight and crane mobilization — Modern nacelles weigh 100-150 tonnes, requiring heavy-lift cranes and reinforced access roads
- OEM production slots — Developers must pre-order turbines 18-24 months ahead of installation to secure OEM production slots amid global supply chain constraints
Civil Works & Infrastructure
Civil construction at 3GW scale involves:
- Foundation design — Gravity base or rock anchor foundations depending on soil conditions, with each foundation requiring 300-500 cubic meters of concrete
- Internal road network — Hundreds of kilometers of access roads (typically 6-8 meters wide) to support 150-tonne cranes and turbine component transport
- Drainage and erosion control — Critical in monsoon-prone regions to prevent foundation damage
- Labour camp infrastructure — Workforce may peak at thousands of workers simultaneously, requiring temporary housing, medical facilities, and logistics support
Commissioning & Quality Assurance
The commissioning process includes:
- Turbine-by-turbine PAT (Performance Acceptance Testing) validates power curves, availability, and performance guarantees
- SCADA integration configures the wind farm management system for real-time monitoring and control
- Third-party independent engineer sign-off is required by lenders before each tranche achieves COD (Commercial Operations Date)
- Lender technical advisors verify construction completion, performance warranties, and O&M readiness before financial close on each tranche
Phase 3 — Grid Integration, Transmission & Power Evacuation
Transmission is the critical bottleneck at 3GW scale. The project's output requires dedicated high-capacity evacuation infrastructure—typically 400kV or 765kV lines and pooling substations—that must be commissioned in sync with each generation tranche.
Global Transmission Benchmarks
The TransWest Express (TWE) project in the US serves as a prime example. This 732-mile HVDC and HVAC transmission system is designed to deliver 3,000 MW of Wyoming wind power to Nevada—a $2.9 billion commitment that illustrates what evacuation infrastructure costs at this scale.
Indian Grid Context
In India, grid integration involves:
- STU and CTU coordination — State Transmission Utilities manage intra-state networks, while the Central Transmission Utility coordinates the Inter-State Transmission System (ISTS)
- ISTS waiver — The Ministry of Power has waived ISTS charges for solar and wind projects commissioned by June 30, 2025
- Transmission lead times — Dedicated transmission lines often require 3-5 years for planning, land acquisition, and construction
CERC GNA Regulations and Connectivity Revocation Risks
CERC's 2022 General Network Access (GNA) Regulations (Regulation 24.6) allow grid connectivity to be revoked if a project misses its scheduled commissioning date by more than six months. This rule has already triggered show-cause notices for hundreds of megawatts of delayed projects, including those from Serentica Renewables and ReNew Green Energy.
Developers must build aggressive 6-9 month risk buffers into project schedules and prioritize land acquisition and Right-of-Way (RoW) to prevent stranded grid assets.
Grid Stability Provisions at 3GW Scale

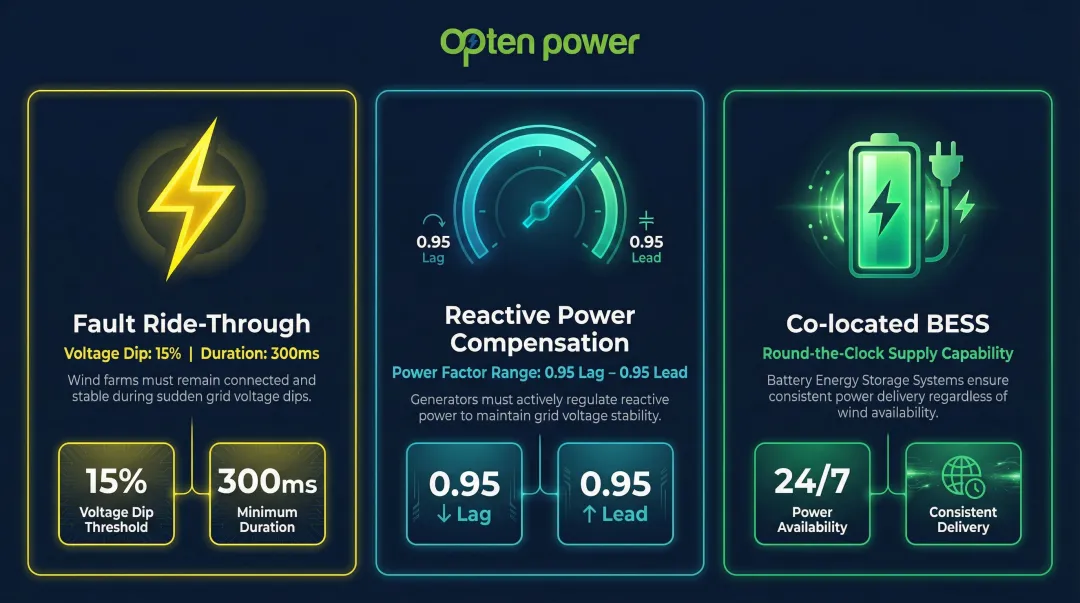

The CERC Grid Code mandates:
- Fault Ride-Through (FRT) capability — Wind farms connected at 33kV and above must remain connected during voltage dips down to 15% of nominal voltage for 300ms
- Reactive power compensation — Wind farms must maintain a power factor between 0.95 lagging and 0.95 leading at the connection point
- Co-located BESS — Battery Energy Storage Systems are now commonly deployed to smooth intermittency and meet round-the-clock (RTC) power supply requirements for industrial offtakers

Financing Structures & Power Offtake Models
A 3GW onshore wind project in India requires approximately ₹15,000–18,000 crore in total CapEx (based on current benchmarks of ₹5–6 crore per MW). The capital structure typically follows a 70:30 debt-to-equity ratio, with project finance (non-recourse or limited recourse debt) from institutions like REC, PFC, and SBI, and equity participation from infrastructure funds, IPPs, or strategic industrial investors.
Offtake Models
A 3GW project typically combines three primary offtake structures to optimize revenue certainty and returns:
1. Long-term PPAs with DISCOMs via competitive tariff-based auctions
SECI (Solar Energy Corporation of India) and state nodal agencies conduct e-bidding auctions for 25-year PPAs. Recent SECI auctions have discovered tariffs ranging from ₹2.90–3.42/kWh for standalone wind projects and ₹4.64–4.73/kWh for wind-solar hybrid projects.
2. Direct corporate PPAs with C&I consumers
Large industrial consumers (steel plants, data centres, cement manufacturers) can secure 20–25 year fixed-price power agreements under open access or group captive models. The Green Energy Open Access (GEOA) rules have lowered the eligibility threshold to 100kW, opening the market for mid-sized C&I buyers.
State-specific banking restrictions impact C&I economics:
| State | Banking Charge | Peak-ToD Drawal Restriction |
|---|---|---|
| Gujarat | ₹1.5/unit on energy wheeled | Allowed if injected during peak |
| Maharashtra | 8% in-kind | Disallowed |
| Karnataka | 8% in-kind | Allowed if injected during peak |
| Rajasthan | 8% in-kind | Not specified |
| Haryana | 8% in-kind | Disallowed |
C&I investors must model state-specific Time-of-Day (ToD) banking penalties into their PPAs and consider co-locating BESS to avoid punitive peak-drawal charges.
3. Merchant/exchange-based sales
Projects with partial uncontracted capacity can sell power on the Indian Energy Exchange (IEX) or through bilateral short-term contracts, though day-ahead market prices can swing significantly with seasonal demand — adding revenue risk that DISCOM PPAs avoid.
Corporate PPA Route for C&I Buyers
For C&I buyers, corporate PPAs typically deliver 30–40% savings versus grid tariffs — ₹3–5/unit in high-tariff states — making long-term wind procurement one of the most cost-effective hedges against rising commercial power rates.
Platforms like Opten Power simplify this process: C&I buyers can compare tariffs across multiple wind projects, get instant IRR and regulatory cost analysis, and execute PPAs through automated RFP workflows and pre-approved contract frameworks — all in one place.
Risk Allocation & Financial Close
Lenders and equity investors focus on key risks during due diligence:
- Resource risk: P90 energy yield assessments derived from 12–36 month IEC-compliant measurement campaigns
- Counterparty risk: DISCOM payment track record, often mitigated through payment security mechanisms like LCSGF or escrow accounts
- Transmission availability risk: Dedicated transmission infrastructure must be commissioned in sync with generation tranches
- Construction completion risk: EPC warranty provisions, performance guarantees, and liquidated damages clauses
- Regulatory change risk: Changes to RPO frameworks, open access charges, or banking regulations

Sequencing these risks into the financial close timeline is where most 3GW projects face delays. Financial close depends on four interdependent milestones:

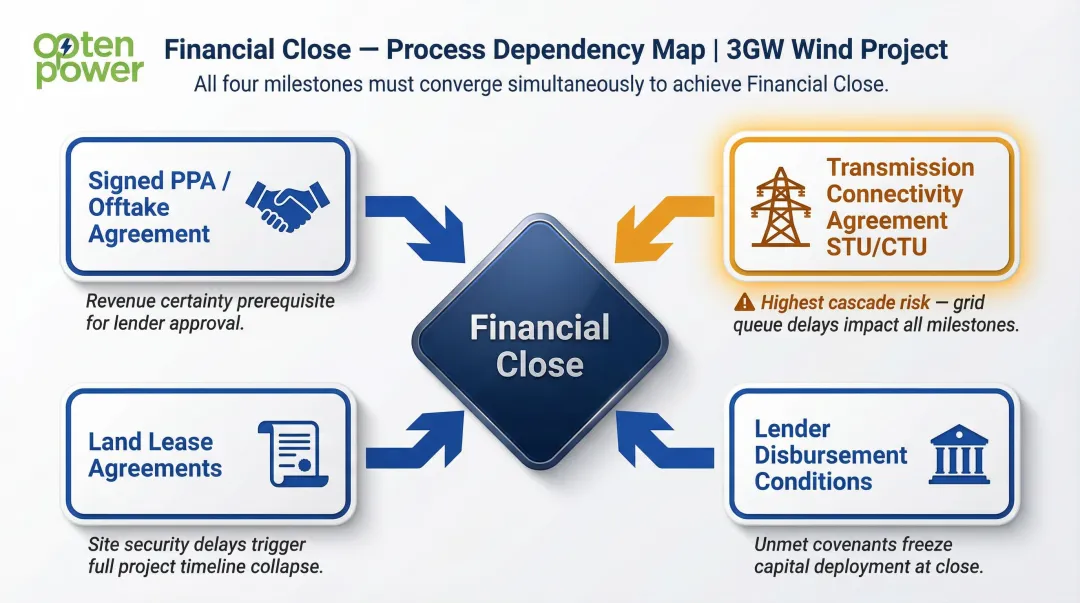

- Signed PPA or offtake agreement
- Land lease agreements covering the project's full footprint
- Transmission connectivity agreement from STU/CTU
- Lender disbursement conditions (independent engineer reports, insurance, security packages)
A slip in any one milestone — particularly transmission connectivity — can cascade into construction delays and cost overruns across the entire project tranche.
Operations, Maintenance & Long-Term Performance
At 3GW scale, O&M is not a background function — it directly determines whether the project meets its financial model over a 25-year life. Developers typically establish on-site operations centres with SCADA monitoring, predictive maintenance analytics, and rotating crew structures targeting availability above 95%.
O&M Model Options
- OEM-operated AMC (Annual Maintenance Contract) — Turbine manufacturers like Vestas and Siemens Gamesa offer service agreements with availability guarantees up to 97-98%
- Independent O&M service providers — Third-party operators provide specialised maintenance expertise
- In-house O&M teams — Large developers with multi-GW portfolios often build internal O&M capabilities to reduce long-term costs
Choosing the right model shapes both cost structure and risk allocation. Once that foundation is in place, the focus shifts to active performance optimization across the project's operating life.
Performance Optimization Levers
Over the project's 25-year life, developers can enhance performance through:
- Periodic repowering assessments — Replacing aging turbines with higher-rated units on the same existing site can increase capacity by 2-3x and energy yield by up to 3x
- Wake effect management — Wake steering and yaw optimization can increase Annual Energy Production (AEP) by 0.4-1.7%
- Blade erosion management — Leading-edge protection and periodic blade repairs maintain aerodynamic efficiency
- Portfolio performance dashboards — Real-time reporting on generation output, availability rates, and revenue performance gives lenders and offtakers the data transparency they require
Frequently Asked Questions
How long does it take to develop and commission a 3GW onshore wind project?
The full timeline from site identification to final commissioning typically spans 8-12 years. Pre-development and permitting take 3-5 years, while phased EPC construction requires an additional 4-6 years depending on grid readiness and financing timelines.
How many wind turbines are needed for a 3GW onshore wind project?
The number depends on individual turbine rated capacity. A project using 3MW turbines requires roughly 1,000 units, while 5MW turbines require around 600 and 10MW machines reduce that to about 300, making higher-rated turbines increasingly preferred.
How much land is required for a 3GW onshore wind project?
Onshore wind requires approximately 40-70 acres per MW depending on terrain and wind patterns. A 3GW project could require between 120,000 and 210,000 acres of land, though only a small fraction is physically occupied by turbines and infrastructure.
What are the biggest challenges in developing a large-scale onshore wind project in India?
The three most common bottlenecks are land aggregation at scale, securing timely transmission connectivity, and navigating multi-layer environmental and regulatory approvals (EIA, Forest, MoD, AAI NOCs), which together account for the majority of pre-COD delays.
What is the typical capital cost per MW for onshore wind in India?
Current CapEx benchmarks range from ₹5-6 crore per MW (inclusive of turbine supply, BOP, and transmission), though costs vary by state, terrain, turbine class, and whether dedicated transmission infrastructure is required.
How can C&I companies access power from large onshore wind projects?
C&I buyers can access power through open access corporate PPAs, group captive structures, or through aggregator platforms. Opten Power, for example, lets buyers compare tariffs, evaluate financial scenarios, and execute PPAs faster, securing long-term wind power at below-grid rates without investing in project development directly.
