Introduction
A Solar PV Power Plant Project Report (formally, a Detailed Project Report or DPR) is the foundational document required before any solar project can receive regulatory approval, lender financing, or proceed to EPC contracting.
Without a complete, bankable DPR, projects stall at the DISCOM approval stage, lenders reject financing applications, and equipment procurement moves forward without a validated design basis — producing underperforming systems and disputes at commissioning.
The consequences are significant. Between 2020 and 2024, 38.3 GW of utility-scale renewable capacity was cancelled due to undersubscription and delayed power sale agreements. For rooftop solar, roughly 60% of applications stall due to documentation gaps.
Yet across developers, C&I buyers, and investors, the actual structure of a credible, bankable DPR remains poorly understood. Most failures trace back to reports that don't meet lender, DISCOM, or regulatory standards — not to the projects themselves.
TL;DR
- A solar PV power plant project report is a structured technical-commercial document covering site assessment, technical design, energy yield analysis, financial modeling, and regulatory compliance
- DISCOMs, banks, government bodies, and EPC contractors all require it before any solar project can move forward in India
- Incomplete project reports directly cause solar projects to miss financial close or regulatory approval
- C&I buyers use it to evaluate whether a solar investment meets IRR, payback period, and energy cost targets
- Strong reports include a bankable P90 yield assessment, compliant equipment specs, sensitivity-tested financials, and state-specific regulatory documentation
What Is a Solar PV Power Plant Project Report?
A Solar PV Power Plant Project Report (DPR) is a technical and commercial document that makes the case for a proposed solar installation, covering site suitability, equipment design, projected energy generation, and financial returns. It gives lenders, DISCOMs, equipment suppliers, and project owners the evidence they need to make informed decisions.
The Ministry of New and Renewable Energy (MNRE) provides Central Financial Assistance (CFA) of up to ₹25 lakh per solar park specifically for the preparation of a DPR, underscoring the document's importance. The Indian Renewable Energy Development Agency (IREDA) provides a standard DPR template (Form APP-P-DPR-1-1) requiring sections on Executive Summary, Site Parameters, Power Potential studies & Simulation results, Technical Aspects, Project Cost Estimates, and Financial Analysis.

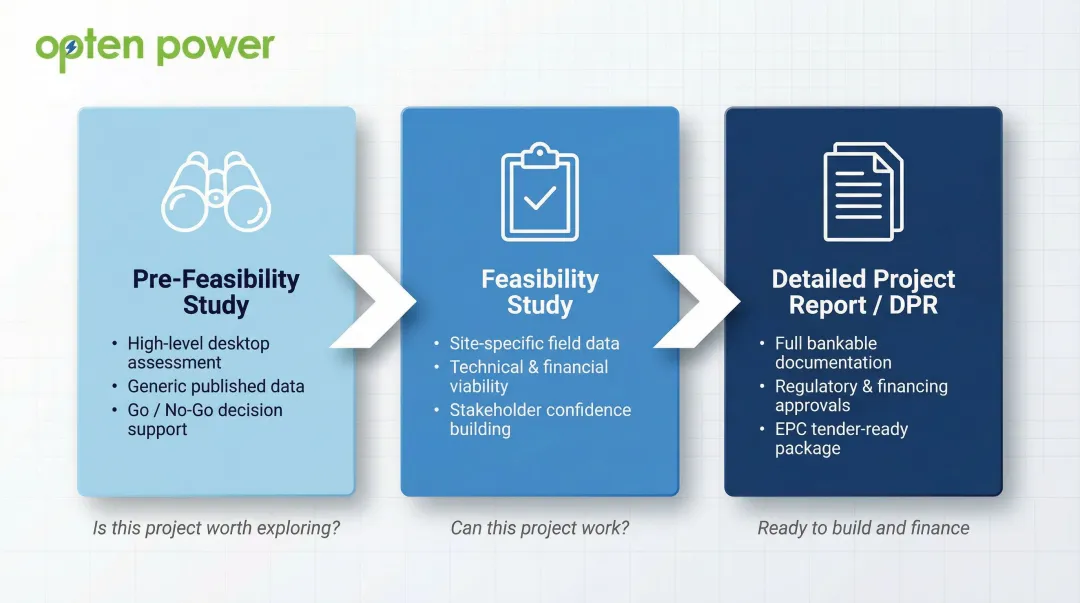

Three closely related documents are often confused:
- Pre-feasibility study: High-level desktop assessment using generic data to make initial go/no-go decisions
- Feasibility study: Mid-level assessment with site-specific data to validate project viability
- Detailed Project Report (DPR): Full, bankable document used for financing, regulatory approvals, and EPC tendering

Why a Solar PV Project Report Is Critical for Industrial and C&I Projects
Regulatory and Commercial Drivers
In India, a DPR is not optional — it is mandatory for multiple regulatory and commercial processes:
- DISCOM connectivity applications and net/gross metering approvals require detailed technical documentation
- Bank lending requires a bankable energy yield assessment and financial model
- MNRE subsidy schemes mandate compliance with approved equipment lists and design standards
The lending requirement goes beyond paperwork. State Bank of India's Surya Shakti Solar Finance requires a minimum Average Gross DSCR (Debt Service Coverage Ratio) of 1.20, calculated strictly against P90 generation scenarios. That standard cannot be met without a properly structured DPR.
What C&I Projects Demand from a DPR
Industrial and commercial buyers have specific requirements:
- Energy yield accuracy: Even a 5–10% error in estimated generation directly affects IRR calculations for large consumers with high electricity bills
- CAPEX/OPEX breakdowns: These must hold up to scrutiny from independent engineers and lenders benchmarking against current market rates
- Tariff assumptions: Must be validated against current state DISCOM policies and net metering limits
For C&I buyers comparing options across multiple developers, platforms like Opten Power allow real-time comparison of tariffs, savings, and ROI across projects and developers to validate project report assumptions before committing.
What Goes Wrong Without a Proper DPR
Without a well-structured DPR, projects fail in predictable ways:
- Projects stall at the DISCOM approval stage due to missing documentation or state-incompatible regulatory filings
- Lenders reject funding applications citing insufficient technical due diligence or unbankable yield assessments
- Equipment procurement proceeds without a validated design basis — resulting in underperforming systems and disputes during commissioning
What a Complete Solar PV Power Plant Project Report Must Cover
A credible DPR is organized into interconnected sections, each serving a distinct stakeholder audience. The executive summary targets decision-makers, the technical section speaks to EPC contractors and reviewers, the energy yield section addresses lenders, and the financial model is built for investors.
Executive Summary and Project Overview
Lenders and DISCOMs read this section first. It must include:
- Project objectives and capacity (kWp/MWp)
- Location and project proponent details
- Key technical highlights (module type, inverter type, grid connection type)
- Expected annual generation (kWh/year)
- Top-line financial metrics (CAPEX, IRR, payback period)
Precision is non-negotiable here. Any mismatch between the executive summary and the detailed sections raises immediate red flags during review.
Site Assessment and Solar Resource Analysis
A thorough site assessment covers:
- Solar irradiation data: GHI (Global Horizontal Irradiance), DNI (Direct Normal Irradiance), GTI (Global Tilted Irradiance)
- Shading analysis: Horizon profile and near-field obstructions
- Available land or rooftop area: Verified through survey
- Topographic and geotechnical conditions: Critical for mounting structure design
- Proximity to DISCOM grid connection point: Determines interconnection costs
- Land ownership/lease status: Must be legally documented
India-specific irradiation data from sources like SolarGIS, PVGIS, or MNRE's solar resource maps should be used. A site visit is essential for large-scale projects to validate desktop assessments.
Technical Design and Equipment Specifications
Equipment selection and design specifications form the technical backbone of the DPR. Cover:
- PV module selection: Type (mono-PERC, bifacial), rated capacity, efficiency, certifications required under IEC 61215 and BIS for Indian projects
- Inverter type and capacity: String vs. central vs. distributed
- Mounting structure design: Fixed-tilt or tracking, wind and seismic load calculations
- DC/AC cabling sizing: Based on voltage drop and current carrying capacity
- Earthing and lightning protection design: Per IS standards
- Metering arrangement: Net metering, gross metering, or bi-directional metering
Equipment must comply with MNRE's Approved List of Models and Manufacturers (ALMM) and be sourced from MNRE-approved manufacturers where applicable. From June 1, 2026, all solar PV modules used in net-metering and open access projects must source solar cells from ALMM List-II.
The BIS 2025 Quality Control Order mandates a minimum 18% efficiency for mono-crystalline modules and 17% for poly-crystalline modules.
Energy Yield Analysis
The energy yield section is the most scrutinized by lenders — it directly determines debt sizing. It must include:
- Annual generation estimates: Using software simulation (PVSyst is the industry standard)
- P50 and P90 values: P50 is the expected annual generation with 50% probability of exceedance; P90 is the conservative estimate with 90% probability. Lenders size debt based on P90
- System losses accounted for:

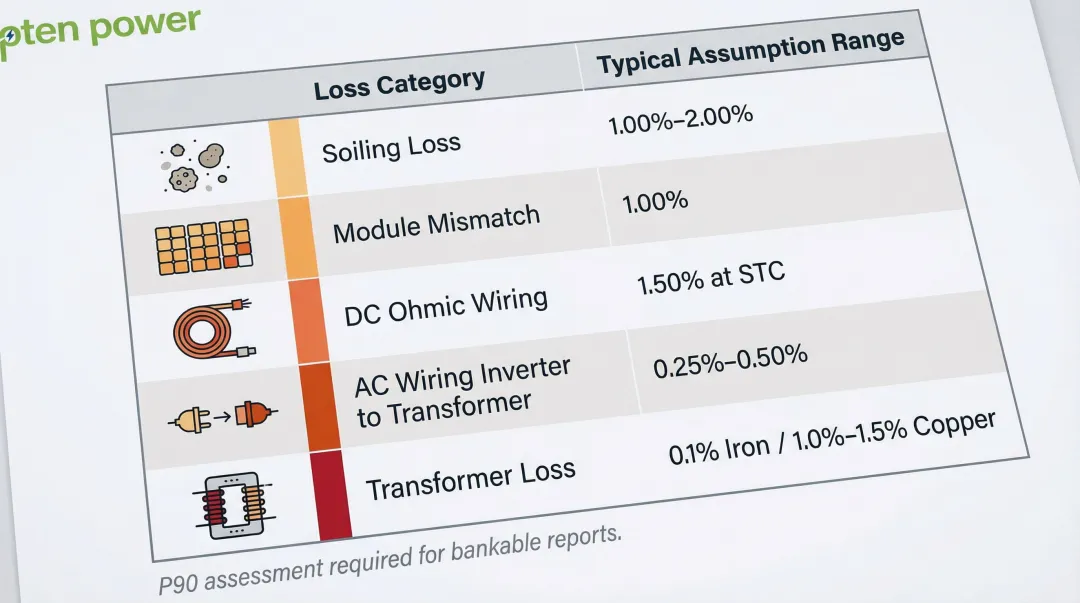

| Loss Category | Typical Assumption Range |
|---|---|
| Soiling Loss | 1.00% – 2.00% |
| Module Mismatch | 1.00% |
| DC Ohmic Wiring | 1.50% (at STC) |
| AC Wiring (Inverter to Transformer) | 0.25% – 0.50% |
| Transformer Loss | 0.1% Iron / 1.0% – 1.5% Copper |

Performance Ratio (PR) Assumptions:
The PR of a well-designed PV power plant typically ranges from 77% to 86%, with an annual average of 82%. For ground-mounted plants in India, a PR of 80–82% is realistic; for rooftop installations, 75–80% is typical due to higher soiling and shading losses.
A bank-grade P90 estimate is the lender standard in India. Without P90 uncertainty analysis, the DPR is typically considered unbankable.
Financial and Commercial Analysis
Investors and lenders will stress-test every number here. Structure it around three components:
CAPEX Breakdown:
- Modules, inverters, Balance of System (BOS)
- Civil works and grid interconnection
- EPC management fee and land costs
Utility-scale project capital costs are USD 550–650 / kW (approximately ₹46–54 million/MW) for 2025. CERC notes actual capital costs for solar PV projects (up to 500 MW) ranged from ₹3.52 to 7.27 crore/MW.
OPEX Estimates:
- Annual O&M, insurance, land lease
- Annual O&M costs for a 1 MW solar plant typically range between ₹6–₹10 lakh
Revenue Projections:
- Based on applicable tariff structure (net metering credit, PPA rate, Feed-in Tariff)
- Must reflect state-specific DISCOM policies

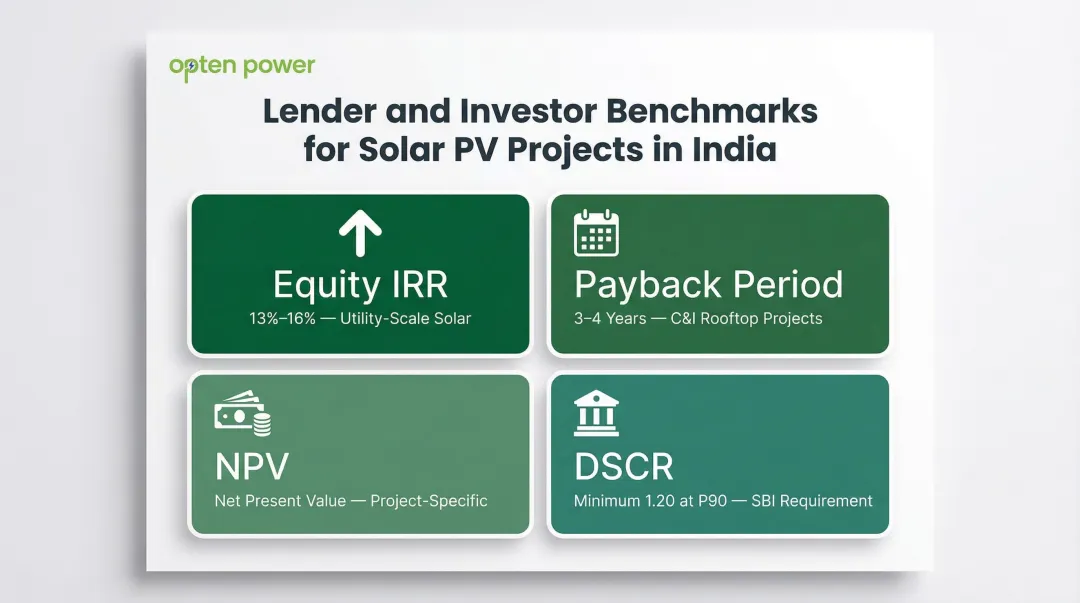

Key Financial Outputs:
- IRR (equity and project) — typical utility-scale equity IRR ranges from 13% to 16%
- Payback period — typically 3–4 years for C&I rooftop projects
- NPV (Net Present Value)
- DSCR for debt financing — SBI requires a minimum of 1.20 at P90

C&I buyers evaluating multiple developers can use Opten Power's platform to compare IRR, payback, and regulatory outputs across projects in real time — compressing what typically takes weeks of back-and-forth into a single session.
Regulatory and Compliance Documentation
Regulatory documentation is the most project-specific section in any DPR. It must capture all permits and approvals applicable to the project:
- DISCOM connectivity application
- Net/gross metering agreement
- Building permit and land use consent
- Environmental clearance (if applicable)
Each state administers its own metering policy, capacity limits, and export tariff rules — which means the regulatory chapter cannot be templated across geographies. Key state-level positions as of 2025:
- Tamil Nadu: Net billing or net feed-in allowed up to 999 kW for C&I; network charges apply
- Gujarat: Rooftop Solar PV System permitted under net-metering up to 1000 kW; gross-metering above 10 kW to 1000 kW
- Karnataka: Distributed Solar PV plants allowed up to sanctioned load/contract demand (previous capacity restriction of 2000 kW removed)
- Rajasthan: Exported units under net-billing remunerated at ₹3.14/kWh
Missing or outdated regulatory documentation is a leading cause of project report rejection. Always verify applicable state orders before finalising this section — regulations are updated frequently and outdated filings are rejected without exception.
How a Solar PV Project Report Is Prepared: The Step-by-Step Process

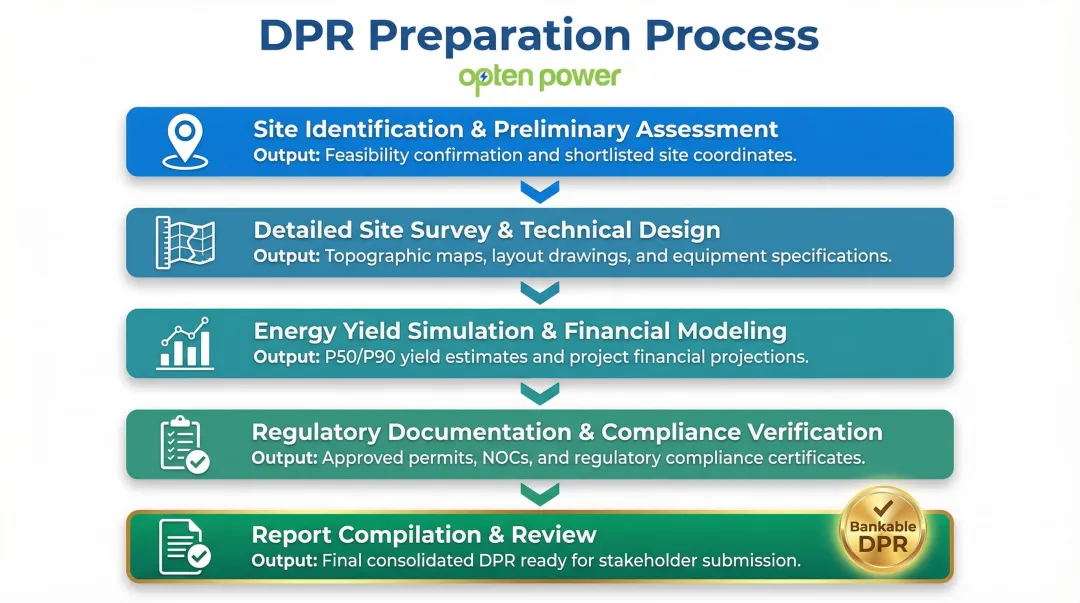

DPR preparation is iterative — each stage builds on the last, adding detail as the project moves from initial concept to a bankable report.
Step 1: Site Identification and Preliminary Assessment
Before committing to a full DPR, the project team screens potential sites against core feasibility criteria:
- Identifying potential sites
- Assessing solar irradiation from satellite databases
- Confirming grid connection feasibility with the local DISCOM
- Reviewing land ownership or rooftop rights
- Conducting a preliminary financial check (back-of-envelope CAPEX and yield estimate) to determine whether the project warrants a full DPR
Step 2: Detailed Site Survey and Technical Design Development
Once a site clears preliminary screening, the technical design work begins in earnest:
- Physical site survey (topographic survey, shading horizon analysis, geotechnical assessment)
- Validation of irradiation data
- Development of the detailed technical design including string configuration, array layout, single-line electrical diagrams, cable sizing, and Bill of Quantities (BOQ)
This step produces the technical annexures of the DPR.
Step 3: Energy Yield Simulation and Financial Modeling
Energy yield is simulated using software (PVSyst or equivalent) with site-specific inputs:
- Module specifications
- Tilt and orientation
- Shading and soiling
- System loss assumptions
This produces P50 and P90 annual generation estimates. Simultaneously, the financial model is built incorporating confirmed CAPEX/OPEX inputs, the applicable tariff structure, and financing terms to derive IRR, payback, and DSCR.
For C&I buyers evaluating multiple project options, tools like Opten Power provide instant IRR, payback, and regulatory analysis — cutting the time needed at this stage by allowing real-time comparison across projects and developers.
Step 4: Regulatory Documentation and Compliance Verification
Each state carries its own regulatory requirements; this step gathers and verifies all applicable documentation:
- DISCOM connectivity application
- Grid code compliance documentation
- Net/gross metering application
- Land-use and building permits
- Environmental impact assessment (where required)
Verify MNRE-approved equipment lists and BIS certifications for modules and inverters at this stage.
Step 5: Report Compilation and Review
The project team assembles all outputs into a structured, internally consistent DPR ready for lender or investor review:
- Assembling all sections into a structured DPR
- Ensuring consistency between the technical design, energy yield, financial model, and BOQ
- Independent technical review or Owner's Engineer review (recommended for projects above 500 kWp)
The final document should include an executive summary, all technical drawings, a BOQ with rates, the energy yield report, the financial model, and all regulatory documentation.

Common Mistakes and What Makes a Solar PV Project Report Unbankable
Overestimating Energy Yield
Using overly optimistic performance ratio assumptions, incorrect irradiation data, or inadequate shading analysis leads to inflated generation projections. DISCOMs and lenders increasingly scrutinize yield reports, and a P50-only assessment without P90 uncertainty analysis is typically insufficient for bank financing.
The IFC notes that lack of high-quality resource data and failure to carry out uncertainty analysis (P90) are key risks that make projects unbankable. A realistic PR benchmark for Indian ground-mount projects is 80–82%; for rooftop projects, 75–80%.
Missing or State-Incompatible Regulatory Documentation
Many project reports are prepared using generic templates that do not reflect state-specific DISCOM requirements — for example, differing net metering limits, export restrictions, or mandatory equipment sourcing rules. A project report prepared for Maharashtra regulations cannot be submitted unchanged for a project in Rajasthan or Tamil Nadu.
Weak Financial Modeling and Absent Sensitivity Analysis
Two modeling gaps consistently trigger lender rejection:
- No sensitivity analysis — lenders require stress-testing across tariff, yield, and CAPEX variables to assess IRR and payback under downside scenarios
- Ignored module degradation — failing to model annual output decline across the 25-year project life distorts long-term revenue forecasts
A study of large-scale grid-connected solar PV in India estimated degradation rates between 0.27%/year and 0.50%/year after 50 months. MNRE rooftop specifications require a performance warranty of >90% for the first 10 years and >80% for the next 15 years.
Unaccounted degradation overstates revenue projections in later years, directly undermining debt serviceability calculations.
Frequently Asked Questions
What is the difference between a DPR and a feasibility report for a solar PV project?
A feasibility study is an earlier-stage assessment used to determine whether a project should proceed further, while a DPR is the full, bankable document with detailed engineering design, certified energy yield analysis, and complete financial and regulatory documentation. A feasibility study typically becomes the foundation from which the DPR is developed.
Who prepares a solar PV power plant project report?
DPRs are prepared by EPC contractors, specialized project development consultants, or the owner's engineer. For larger projects, lenders require the energy yield component to be verified by an independent technical consultant, while financial and regulatory sections are typically handled by advisors with state-specific expertise.
What documents are required along with a solar project report for DISCOM approval in India?
Key supporting documents typically include a net/gross metering application form, proof of land ownership or lease agreement, single-line diagram approved by a licensed electrical engineer, list of MNRE-approved equipment, and technical specifications of modules and inverters. Document requirements differ by state DISCOM — check your state's latest connectivity regulations before submission.
How long does it take to prepare a complete solar PV project report?
Rooftop and small ground-mount reports typically take 2–4 weeks. Large-scale utility or C&I plant DPRs — requiring site surveys, independent energy yield assessments, and detailed financial modeling — run 6–12 weeks. Per MNRE Solar Park guidelines, Solar Power Park Developers must submit their DPR within 60 days.
Is a detailed project report required for rooftop solar systems below 100 kW?
A full DPR is not mandatory for small rooftop systems, but DISCOM approval still requires a technical proposal covering site assessment, single-line diagram, equipment specifications, and a net metering application. For systems above 50 kWp, DISCOMs and financing institutions expect a more detailed report.
Can a solar PV project report be used directly to secure bank financing?
A DPR is the core technical input for lender due diligence, but banks typically commission an independent technical advisor to verify it before approving financing. The report must include a P90 energy yield assessment, detailed financial model with sensitivity analysis, regulatory compliance proof, and bankable equipment warranties — gaps in any of these will delay financial close.
