Greenfield vs. Brownfield Investments: What's the Difference?

Introduction

India's renewable energy sector pulled in $68 billion in clean energy capital during 2023 alone — a nearly 40% surge from the 2016–2020 average. Billions are flowing into both new project development and acquisition of existing assets, with the greenfield versus brownfield decision sitting at the heart of most capital allocation strategies in this space.

This distinction determines capital outlay, time to first power, risk exposure, and long-term returns for C&I buyers, developers, and investors alike.

Whether you're a steel plant optimising procurement costs, a data centre targeting 24x7 renewable power, or an infrastructure fund deploying capital across India's 16 renewable-rich states — understanding these two models is essential to building a resilient, cost-efficient energy strategy.

TLDR

  • Greenfield investment builds new renewable projects from scratch on undeveloped land—offering full control, higher upfront costs, and longer timelines
  • Brownfield investment acquires or repurposes existing projects—delivering faster cash flow, lower initial capital, but inherited technical and regulatory risks
  • Choose Greenfield for custom design, specific technology selection, and long-term margin optimisation
  • Choose Brownfield when speed to market, predictable cash flows, or ready project pipelines take priority
  • The right choice depends on capital position, risk appetite, timeline pressure, and strategic goals in India's energy transition

Greenfield vs. Brownfield: Quick Comparison

DimensionGreenfieldBrownfield
Capital RequirementsHigh upfront investment — land acquisition, power evacuation infrastructure, grid connectivity, statutory clearancesLower initial capital — existing infrastructure, pre-cleared land, established grid connections
Time to Revenue/Operations18–36+ months due to land, forest clearances, and DISCOM approvalsImmediate or near-term cash flow from operational or near-operational assets
Risk ProfileHigh execution risk — construction delays, technology selection, policy changesLower execution risk but inherited equipment condition, PPA terms, potential land disputes
Regulatory ComplexityExtensive approvals required — MNRE, state nodal agencies, CERC/SERC, forest/wildlife clearancesPre-approved permits in most cases, but thorough legal and technical due diligence essential
Flexibility/Design ControlComplete design freedom — capacity, technology, layout, PPA structure optimisationLimited flexibility — constrained by existing equipment, capacity, and contractual terms

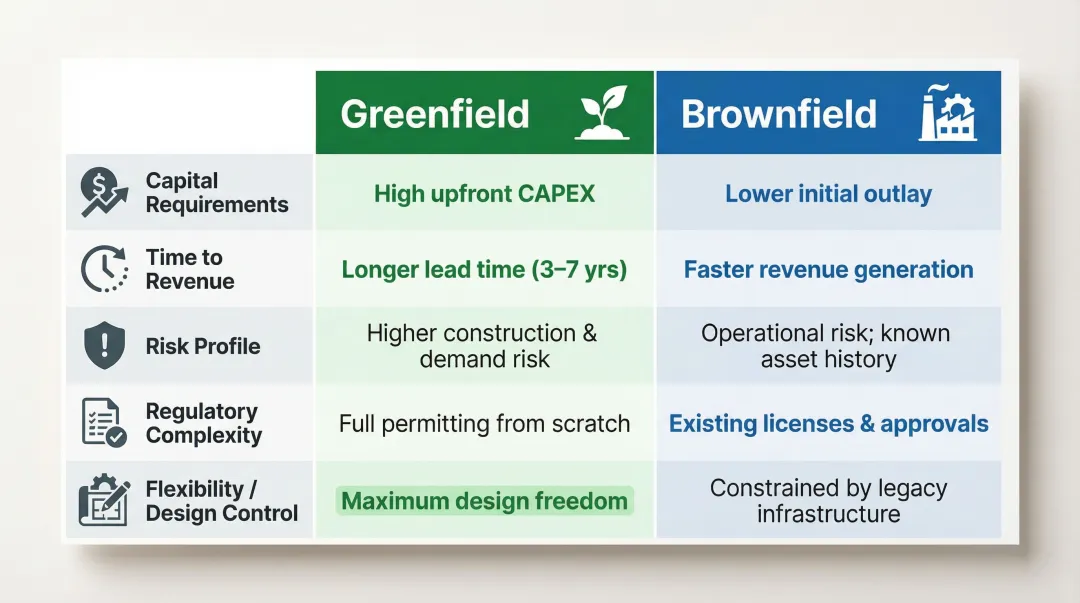

Greenfield versus brownfield renewable energy investment five-dimension comparison infographic

Regulatory Timeline Reality Check

MNRE guidelines stipulate 18–24 months from PPA signing to commissioning for greenfield solar projects. Ground realities routinely exceed that:

  • Land acquisition: Officially 6–8 months; in practice, 15–49 months due to fragmented ownership and conversion complexities
  • Grid connectivity approvals: Targeted at 18 months; frequently extends to 28–93 months because of transmission infrastructure backlogs

The return profiles reflect these realities. Greenfield projects carry development-stage risk but typically deliver stronger long-term returns when executed well — 9.6% base case for utility-scale and 14–18% for C&I open access. Brownfield assets trade upside for predictability, with IRRs typically ranging 9–11% and significantly lower execution risk.

What is a Greenfield Investment?

A greenfield investment represents a renewable energy project built from scratch on previously undeveloped or undedicated land, with no existing infrastructure in place. In India's context, this includes new utility-scale solar parks, wind farms, or hybrid projects developed on virgin or repurposed agricultural/wasteland.

Core Advantages for Energy Investors

Greenfield projects give developers control that no brownfield asset can match. Key advantages include:

  • Full design flexibility — complete control over capacity sizing, technology selection (latest panels, turbines, battery storage), plant layout, and PPA alignment. This directly improves capacity utilisation factors (CUF) and lowers O&M costs over a 25-year project life.
  • Technology optimisation — deploy the most efficient equipment available, avoiding performance degradation inherent in older brownfield assets. Solar EPC costs dropped to ₹32–37 million/MW in FY24 on the back of global module price declines.
  • Long-term margin control — projects designed around specific offtakers or tender requirements let developers optimise everything from land lease terms to evacuation infrastructure sizing.

Key Challenges and Execution Risks

Despite these advantages, greenfield projects face substantial hurdles:

  • High upfront capital for land acquisition, evacuation infrastructure, grid connectivity, and statutory clearances
  • Long pre-revenue period with cash outflows but no generation income
  • Dependency on stable policy environments—changes in customs duties, ALMM requirements, or tariff structures can impact project economics mid-development
  • Execution risk during construction—contractor delays, equipment supply chain disruptions, and cost overruns

The reimposition of the Approved List of Models and Manufacturers (ALMM) mandate in April 2024 threatens to inflate module costs by 15-20% by restricting developers to domestically approved modules, reducing international competition.

India's Regulatory Journey for Greenfield Projects

Navigating India's renewable energy regulatory landscape requires clearing multiple approval layers:

State-Level Clearances:

  • Land acquisition and conversion approvals
  • Forest and wildlife clearances (where applicable)
  • State nodal agency project registration

Grid and Evacuation:

  • DISCOM connectivity approvals
  • Central Transmission Utility (CTU) or State Transmission Utility (STU) infrastructure coordination
  • Pooling station and evacuation line construction

Tariff and Commercial:

  • CERC (Central Electricity Regulatory Commission) or SERC (State) tariff approvals
  • PPA execution with offtakers

States with proactive renewable policies—Rajasthan, Gujarat, Madhya Pradesh, and Andhra Pradesh—have created designated solar and wind zones with single-window clearance systems that cut greenfield approval timelines considerably.

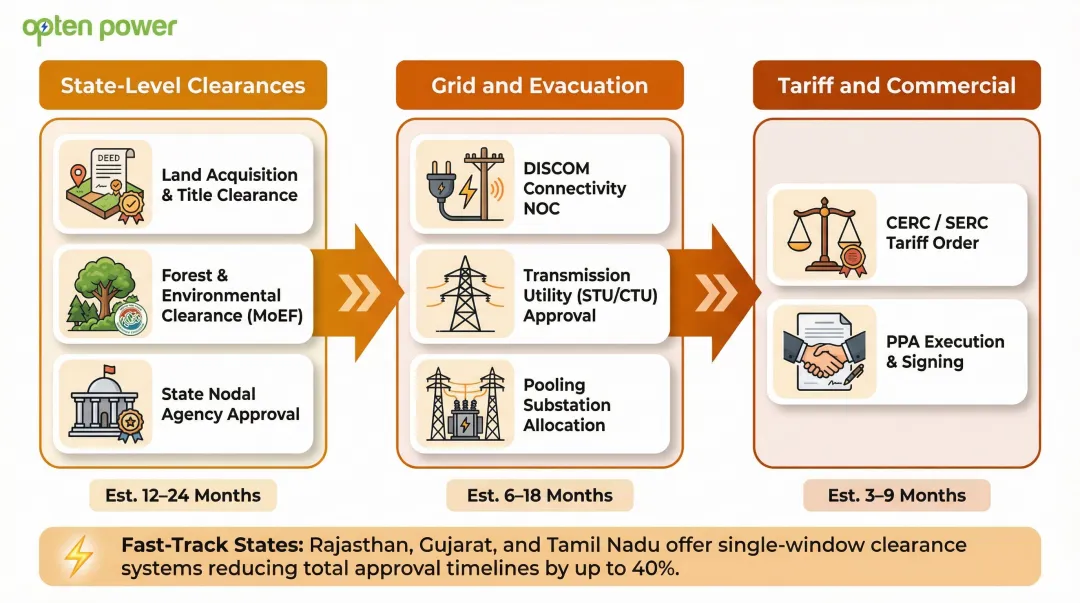

India greenfield renewable energy regulatory approval process multi-stage flow diagram

Rajasthan's Integrated Clean Energy Policy 2024 designates RREC as the nodal agency for land allotment and power evacuation approvals. Andhra Pradesh mandates technical feasibility clearance within 14 days of application.

Use Cases of Greenfield Investment in Renewable Energy

Utility-Scale IPPs: Large independent power producers building 100+ MW solar or wind parks under state or central tenders represent the classic greenfield use case. SECI's recent Tranche XV solar-plus-storage tender awarded 1,200 MW at ₹3.41-3.42/kWh to developers including JSW Neo Energy, ACME Solar, and Hero Solar, with 24-month commissioning timelines from PPA signing.

C&I Captive Projects: Commercial and industrial buyers setting up captive renewable projects—whether rooftop solar or ground-mounted installations—to meet 24x7 power needs increasingly opt for greenfield development when they have patient capital and specific load profiles to match.

Hybrid Solar-Wind Projects: In resource-rich states where no existing infrastructure exists, hybrid projects combining solar's daytime generation with wind's nighttime output represent high-value greenfield opportunities. These projects deliver grid stability and optimised tariffs for round-the-clock industrial loads.

Real Example: The Rewa Ultra Mega Solar Park (750 MW) in Madhya Pradesh stands as a premier greenfield success story. By utilising robust payment security mechanisms and state-facilitated land acquisition, the project achieved a historic low tariff of ₹2.97/kWh without viability gap funding and was fully commissioned by January 2020.

What is a Brownfield Investment?

A brownfield investment involves acquiring, leasing, or repurposing an existing operational or near-operational renewable energy asset. In India's energy sector, this includes buying a functioning solar plant, acquiring a distressed wind project, repowering aging turbines with higher-capacity models, or taking over an existing captive power setup.

Core Advantages for Investors

  • Immediate cash flow: Operational assets generate revenue from day one, eliminating the 18–36 month pre-revenue period greenfield projects face — improving bankability and accelerating ROI.
  • Ready infrastructure: Grid connectivity, evacuation lines, cleared land, and regulatory approvals are already in place, bypassing the most time-consuming bottlenecks in greenfield development.
  • Real performance data: Actual generation history lets investors validate capacity utilisation, seasonal variability, and maintenance requirements before closing — no modelled assumptions.
  • Lower execution risk: Construction is complete, so buyers sidestep contractor delays, supply chain disruptions, and cost overruns that routinely affect greenfield budgets.

Specific Risks and Due Diligence Requirements

Brownfield investments carry distinct risks that require thorough technical and legal due diligence:

  • Equipment degradation: Solar panels lose 0.5–0.8% output annually; older wind turbines from the 1990s–2000s run at significantly reduced efficiency. A Moody's analysis found 15–20% of Indian wind and solar projects missed capacity utilisation targets in FY2019–20.
  • Below-market PPA terms: Acquired assets often carry tariffs locked in years earlier. Evaluate remaining tenure and escalation clauses carefully before pricing the deal.
  • Land and community liabilities: Disputes over lease terms, right-of-way, or local community relations can surface as unexpected costs after acquisition.
  • Hidden upgrade costs: The SunEdison collapse is a cautionary case — TerraForm Global alleged it was forced to invest an additional $73 million to remediate India projects misrepresented as ready for drop-down.

The Repowering Opportunity

India holds an estimated 25.4 GW of aging wind assets installed during the 1990s–2000s with turbines of 250–750 kW capacity. Repowering these sites with modern 2–4 MW turbines — on land with existing grid connections — represents a high-value brownfield play.

The MNRE's National Repowering & Life Extension Policy for Wind Power Projects (2023) provides the framework:

  • Eligibility: Turbines below 2 MW capacity, those completing design life, or voluntary repowering after 15 years
  • Scale: 25.4 GW national potential, concentrated in Tamil Nadu (7.38 GW), Gujarat (4.66 GW), and Maharashtra (3.43 GW)
  • Incentives: IREDA provides an additional 0.25% interest rate rebate, plus a 2-year moratorium on PPA power supply during repowering execution

India wind repowering opportunity national potential by state with MNRE policy incentives breakdown

A feasibility study of the Chalkewadi wind farm in Maharashtra demonstrated repowering's impact: replacing eight old 250 kW turbines with a single 5.2 MW turbine achieved a 2.6x capacity increase and 3.9x annual energy yield increase, delivering an 11.89% IRR.

Use Cases of Brownfield Investment in Renewable Energy

  • PE/infrastructure fund acquisitions: Well-capitalised platforms add gigawatts of operational capacity in a single transaction. Adani Green Energy's $3.5 billion acquisition of SB Energy India's 5,000 MW portfolio in 2021 shows how quickly brownfield deals can build scale.
  • C&I strategic acquisitions: Industrial buyers can secure dedicated renewable supply at attractive valuations by purchasing distressed or off-contract solar assets near their facilities — particularly when sellers face financial stress or PPA expiration.
  • Development pipeline acceleration: Acquiring partially-constructed or late-stage development assets reduces timeline risk while preserving some design flexibility — a middle path between pure greenfield and operational brownfield.
  • Sector consolidation: JSW Neo Energy's 2022 acquisition of Mytrah Energy's 1,753 MW wind and solar portfolio for ₹10,530 crore (enterprise value) illustrates the scale of brownfield consolidation now reshaping India's renewable sector.

Greenfield vs. Brownfield: Which is Better for Renewable Energy Investors?

There is no universal answer—the right choice depends on investor profile, available capital, timeline, and strategic intent.

Key Decision Factors

Five factors tend to drive the decision:

  • Capital structure: Greenfield demands substantial upfront spend on land, construction, and pre-revenue carrying costs. Brownfield acquisitions need less initial capital, though post-acquisition upgrades can close the gap. Whether you're deploying patient equity or structured project debt fundamentally shapes which path is viable.
  • IRR targets: Funds targeting 14–18% equity returns typically need greenfield C&I open-access or hybrid projects. If 9–11% stable yields are acceptable, operational brownfield assets with 25-year PPAs deliver predictable cash flows with lower execution risk.
  • Offtake urgency: C&I buyers facing rising grid tariffs can't wait 24–36 months for greenfield commissioning. Operational brownfield assets or Third Party Open Access arrangements deliver cost savings from day one.
  • Risk profile: Greenfield carries construction, policy, and technology selection risk. Brownfield brings equipment condition risk, inherited PPA terms, and potential hidden liabilities. Your due diligence capabilities — not just your risk appetite — determine which you can manage.
  • Asset availability: In states with thin brownfield inventory or specific technology requirements, greenfield may be the only option. In markets with financially stressed developers or aging wind farms ready for repowering, brownfield can offer superior risk-adjusted returns.

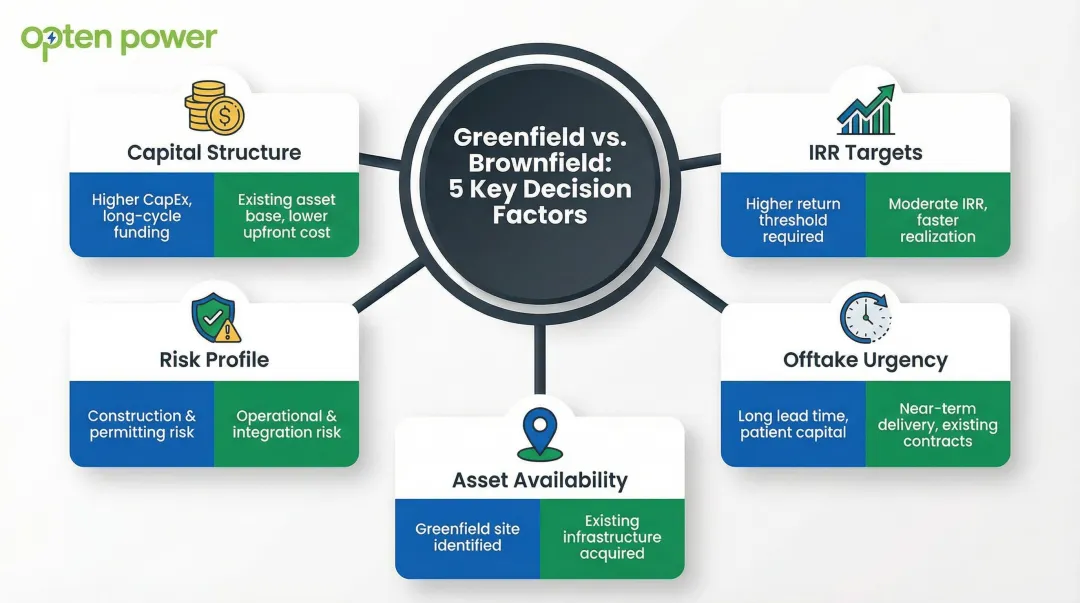

Five key decision factors for choosing greenfield versus brownfield renewable energy investment

Situational Guidance

Choose Greenfield If:

  • Patient capital allows absorbing 18–36 month pre-revenue periods
  • Maximum design control is needed for specific capacity, technology, or PPA structures
  • Development is under long-term government tenders with assured offtake
  • Custom configurations (hybrid solar-wind-storage) are unavailable in existing assets
  • Land in designated renewable energy zones with streamlined approvals is securable

Choose Brownfield If:

  • Revenue timing is critical: cash flows are needed within months, not years
  • Entering a new market requires operational proof points before scaling
  • A distressed asset offers significant price advantage with manageable technical risk
  • Strong due diligence capabilities exist to identify and price inherited risks
  • Repowering opportunities in high-wind states with aging turbine stock are the target

The Emerging Hybrid Portfolio Strategy

The either/or framing above has limits. Sophisticated developers and funds increasingly build portfolio strategies that balance both—acquiring brownfield assets for near-term cash flows while developing greenfield projects for long-term capacity addition.

Brookfield Renewable's asset recycling program generated $4.5 billion in proceeds globally to fund new development, while Adani Green Energy's portfolio combines over 3.1 GW of operational hybrid capacity with aggressive greenfield bidding.

Platforms like Opten Power enable this strategy by allowing investors and C&I buyers to compare greenfield and brownfield renewable opportunities side-by-side—evaluating IRR, payback period, regulatory status, and tariff benchmarks across 4+ GW of listed capacity in real-time across 16 states. The result: investors spend less time sourcing deals and more time closing them.

Real-World Examples in India's Renewable Energy Sector

Greenfield Success: SECI Tranche XV Solar-Plus-Storage

SECI's Tranche XV tender awarded 1,200 MW of solar capacity with integrated energy storage systems to developers including JSW Neo Energy, ACME Solar, and Hero Solar. The discovered tariff of ₹3.41-3.42/kWh reflects the premium paid for dispatchable power compared to vanilla solar tariffs below ₹2.70/kWh.

The Challenge: Developers faced long development timelines (24 months from PPA signing), upfront capital requirements for both solar and storage components, and the complexity of integrating battery systems with solar generation.

The Investment Case: Despite higher costs and longer timelines, developers chose greenfield development to capture the premium tariffs available for firm and dispatchable renewable energy (FDRE). With India's grid increasingly requiring storage-backed renewable power, these projects position developers for long-term contracted revenue with reduced curtailment risk.

The Outcome: Projects will deliver 25-year contracted revenue streams with high capacity utilisation factors, providing base load power to DISCOMs and industrial offtakers requiring round-the-clock renewable supply.

Brownfield Success: Chalkewadi Wind Farm Repowering

The Chalkewadi wind farm repowering project in Maharashtra replaced eight aging 250 kW turbines from the 1990s with a single modern 5.2 MW turbine on the same land with existing grid connectivity.

The Challenge: The original turbines had completed their design life and operated at significantly reduced efficiency, generating minimal revenue despite occupying a prime Class-I wind site.

Why Brownfield Won Here: The existing grid connectivity, cleared land, and proven wind resource eliminated the 18-36 month approval timeline required for greenfield development. The discounted asset price relative to building new capacity on virgin land, combined with IREDA's 0.25% interest rate rebate for repowering projects, made the economics compelling.

The Outcome: The project achieved a 2.6x capacity increase and 3.9x annual energy yield increase, delivering an 11.89% IRR. The 2-year moratorium on PPA power supply during repowering execution allowed the developer to complete the upgrade without contractual penalties.

Key Takeaway

The most successful renewable energy investors in India evaluate both routes with careful due diligence: understanding not just the asset, but the regulatory and commercial landscape before committing capital.

If you're assessing greenfield or brownfield opportunities, Opten Power's marketplace gives you instant access to vetted projects, real-time tariff intelligence, and automated deal tools across 16 states.

Conclusion

Greenfield and brownfield investments each serve distinct strategic purposes in renewable energy. The right choice depends on where the investor or C&I buyer sits on the spectrum of capital availability, timeline flexibility, and risk tolerance—and both paths can deliver strong returns when the project fundamentals hold.

For industries navigating India's energy transition—from steel plants optimising procurement costs to data centres targeting 24x7 renewable power—understanding these two models shapes every procurement and investment decision that follows.

Whichever path you pursue, three factors determine outcomes:

  • Due diligence: Validate land, permits, grid connectivity, and off-take terms before committing capital
  • Timeline realism: Greenfield timelines routinely extend; brownfield closings carry their own regulatory lag
  • Capital alignment: Match your financing structure to the actual risk profile of the asset, not the projected one

Frequently Asked Questions

What is the difference between brownfield and greenfield assets?

Greenfield assets are newly developed renewable energy projects built from scratch on previously undeveloped land with no prior infrastructure. Brownfield assets are existing or previously developed projects—operational solar plants, wind farms, or partially built facilities—that are acquired, repurposed, or upgraded. The key difference lies in development stage, risk profile, and speed to operation.

What is a brownfield asset?

A brownfield asset is an existing facility, project, or piece of land with prior development history. In renewable energy, this means an operational solar or wind plant already generating revenue, a partially built project with existing approvals, or a site with established grid connectivity.

What is an example of a brownfield asset?

A company repowering aging 250-750 kW wind turbines from the 1990s with modern 2-4 MW models on the same site is a classic brownfield transaction—leveraging existing grid connections and land clearances to deliver 2-3x capacity increases with minimal regulatory delays.

Which is better: greenfield or brownfield investment in renewable energy?

Neither is universally better. Greenfield offers complete design control and long-term margin potential; brownfield delivers faster returns, lower execution risk, and immediate cash flows. The right choice depends on your capital position, timeline urgency, and appetite for construction versus inherited equipment risk.

What are the main risks of greenfield renewable energy investments?

Key risks include long pre-revenue timelines (18-36+ months), regulatory and land acquisition delays, construction cost overruns from equipment price volatility, and technology selection risk if module or storage costs shift mid-development. Contingency budgets and experienced EPC contractors are the primary mitigants.

Can brownfield renewable energy projects qualify for government incentives in India?

Yes, brownfield projects—particularly wind repowering initiatives—qualify for MNRE policy support under the National Repowering & Life Extension Policy for Wind Power Projects (2023). This includes IREDA's additional 0.25% interest rate rebate and a 2-year moratorium on PPA power supply during repowering execution. Acquired operational projects under new ownership may benefit from state-level incentives in Gujarat, Tamil Nadu, and other states with dedicated repowering frameworks.
