Introduction
Developers, investors, and C&I buyers share a common challenge: renewable energy projects demand substantial upfront capital, and without a reliable valuation, there's no way to know whether projected returns justify the risk. Valuation sits at the foundation of every financing decision, acquisition negotiation, and PPA pricing discussion in the sector.
Unlike conventional assets, renewable energy projects have characteristics that make standard valuation templates fall short. These assets operate over 25–30 year horizons, generate revenues tied to contracted PPA rates or volatile merchant markets, face production variability from weather, and depend heavily on evolving policy frameworks.
In India specifically, generic models miss several critical layers of complexity:
- State DISCOM payment reliability and off-take risk
- RPO compliance obligations and their impact on project economics
- Open access regulations that vary significantly by state
This article breaks down the most widely accepted valuation methods for renewable energy projects, examines the factors that drive value, and provides practical guidance on selecting the right methodology for your project type and stage.
TLDR
- Renewable energy projects require purpose-built valuation approaches: DCF, comparable analysis, asset-based valuation, WACC/CAPM, and LCOE benchmarking
- DCF captures long-term PPA revenue streams but is highly sensitive to discount rate and energy yield assumptions
- EV/EBITDA and EV/MW multiples suit M&A transactions where operational assets have proven cash flows
- Asset-based valuation anchors value to physical replacement costs, making it relevant for pre-revenue or early-stage projects
- PPA structure, capacity factor, and regulatory incentives must be stress-tested across every methodology
What Is Renewable Energy Project Valuation?
Renewable energy project valuation estimates the fair market value or investment value of energy-generating assets—solar, wind, hybrid, or storage—based on expected financial, operational, and regulatory characteristics. Valuations can target a single asset (project-level) or an entire portfolio (company-level or IPP valuation).
Valuation in renewables is uniquely complex. Assets generate revenue over 20–30 year horizons, with income tied to contracted PPA prices or merchant market rates, and production that shifts with weather. Policy frameworks—RPO obligations, subsidies, tax incentives—further affect cash flows.
In India, several additional variables make generic valuation models unreliable:
- State DISCOM pricing reliability and payment history
- RPO compliance enforcement across different state regulators
- Open access charges, wheeling fees, and banking regulations
- Merchant rate volatility in short-term power markets
Choosing the right valuation method depends on the project's stage, deal structure, and what question you're actually trying to answer. The five methods below each serve a distinct purpose.
Top Valuation Methods for Renewable Energy Projects
The right valuation method depends on the project's stage (pre-NTP, under construction, or operational), the purpose of the valuation (financing, M&A, internal portfolio review), and the availability of comparable market data. The five methods below cover the full spectrum—from cash flow modeling to cost benchmarking—each suited to different stages and decisions.
Discounted Cash Flow (DCF) Analysis
DCF is the most widely used and comprehensive method for valuing operational and near-operational renewable energy projects. It estimates present value by projecting future cash flows over the project's life—typically 25–30 years for solar and wind—and discounting them back to today using an appropriate cost of capital.
The method directly reflects the project's revenue structure, whether PPA-linked or merchant, making it highly relevant for lenders and equity investors.

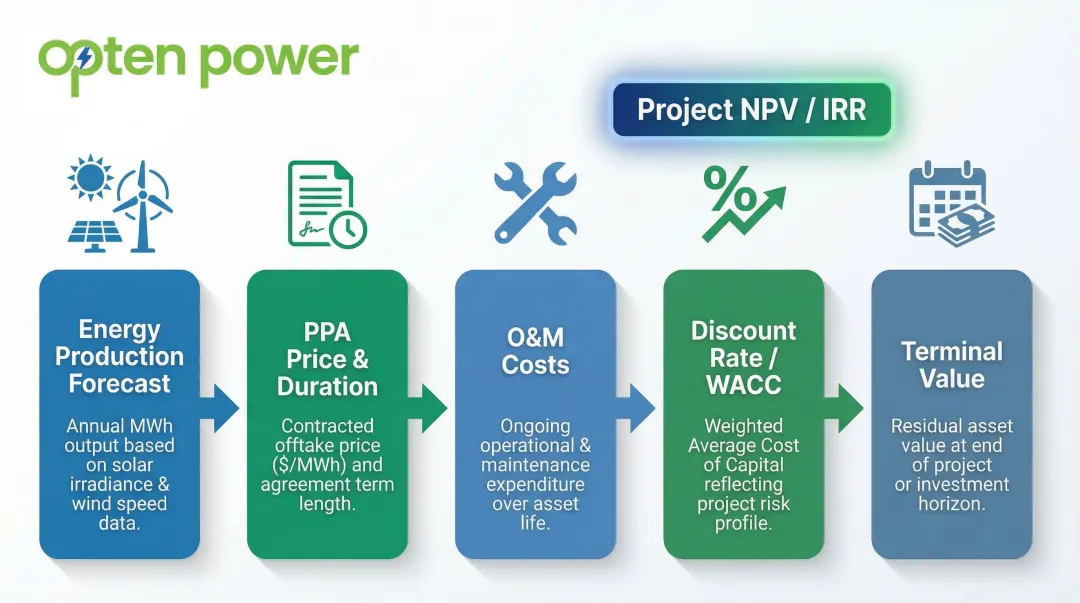

DCF stands out for renewables because it can incorporate project-specific variables that other methods miss:
- P50/P90 energy production estimates
- Long-term PPA price escalation schedules
- Operating expense profiles and debt service
- Terminal value assumptions
Platforms like Opten Power offer real-time IRR and payback analysis across solar, wind, and hybrid assets, automating significant portions of DCF inputs and enabling investors to compare project economics instantly.
| Attribute | Details |
|---|---|
| Best Used For | Operational assets, PPA-backed projects, financing and investment decisions |
| Key Inputs | Energy production forecast (P50/P90), discount rate (WACC), PPA price and duration, O&M costs, terminal value |
| Key Limitation | Highly sensitive to discount rate and production assumptions; small input changes can produce large value swings |

Comparable Company / Precedent Transaction Analysis
This market-based method estimates value by comparing the subject project or company to similar assets recently transacted or publicly traded. In renewable energy, this typically uses EV/EBITDA, EV/MW (installed capacity), and EV/MWh (annual generation) multiples drawn from M&A transactions or listed IPPs. This method is less data-intensive than DCF and provides a useful market sanity check.
It's particularly useful for operational assets and portfolio transactions. When a developer sells a 100 MW solar farm or an investor acquires a wind portfolio, comparable transaction data provides a market-derived value reflecting what informed buyers actually pay. Recent 2022–2024 transactions for contracted operational assets in India indicate EV/MW multiples of approximately ₹50M–₹55M per MW and EV/EBITDA multiples around 7.1x–7.6x.
| Attribute | Details |
|---|---|
| Best Used For | M&A transactions, portfolio acquisitions, investor benchmarking for operational assets |
| Key Inputs | EV/EBITDA multiples, EV/MW capacity multiples, comparable transaction data |
| Key Limitation | Comparable data is scarce for early-stage or development-stage assets; multiples vary widely by geography and offtake structure |
Asset-Based (Cost) Approach
The asset-based approach estimates project value by summing the cost to replace all physical assets—panels, turbines, inverters, civil works, grid connection—minus accumulated depreciation. It anchors value to tangible capital expenditure, making it most relevant when income-generating capacity has not yet been established.
This method is most applicable for:
- Early-stage or pre-revenue projects
- Insurance appraisals and collateral lending
- Cross-checks alongside DCF for operating assets

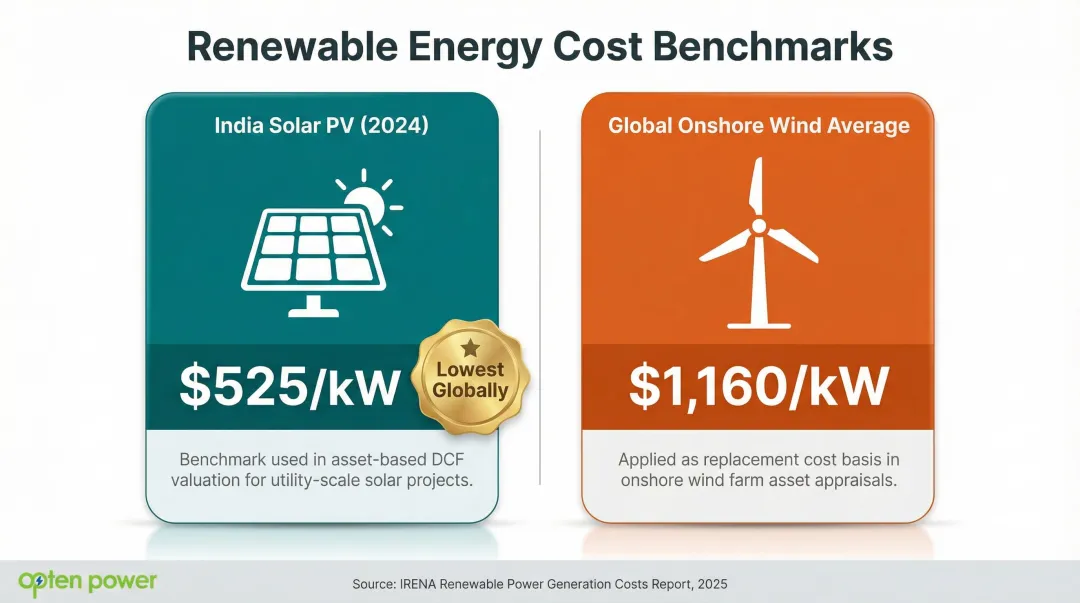

In India, EPC cost benchmarks and MNRE guidelines on equipment costs are standard reference points for asset-based appraisals. India achieved the lowest total installed cost for solar PV in 2024 at $525/kW, while onshore wind costs averaged $1,160/kW globally.
| Attribute | Details |
|---|---|
| Best Used For | Pre-NTP projects, insurance appraisals, early-stage asset collateral, cross-check against income approach |
| Key Inputs | Equipment replacement cost, civil and balance-of-plant costs, depreciation schedule, land value |
| Key Limitation | Does not reflect earning potential or future cash flows; may undervalue well-contracted operating assets |

WACC and CAPM-Based Discount Rate Analysis
WACC (Weighted Average Cost of Capital) and CAPM (Capital Asset Pricing Model) are not standalone valuation methods—they are critical inputs into DCF. CAPM estimates the cost of equity by adding a market risk premium and project-specific risk premium to a risk-free rate (government bond yield).
WACC then blends that cost of equity with the after-tax cost of debt, weighted by the project's expected long-term capital structure.
Getting the discount rate right is essential. An incorrect WACC can over- or undervalue a project by hundreds of crores. In renewable energy, the discount rate must reflect project-specific risks—contracted versus merchant revenue, construction risk, offtaker credit quality, and regulatory risk. In India, interest rate environment, RBI policy rates, and state-level regulatory risk are additional factors influencing appropriate WACC. India's renewable energy sector experienced a 320-basis-point expansion in WACC through 2024 as global monetary conditions tightened.
| Attribute | Details |
|---|---|
| Best Used For | Setting the discount rate in DCF analysis; M&A pricing; tax equity and project finance structuring |
| Key Inputs | Risk-free rate (G-sec yield), equity risk premium, beta (from listed comparables), debt-to-equity ratio, cost of debt |
| Key Limitation | CAPM-derived discount rates can fluctuate with stock market volatility; may not reflect real transaction terms in thinly traded private markets |

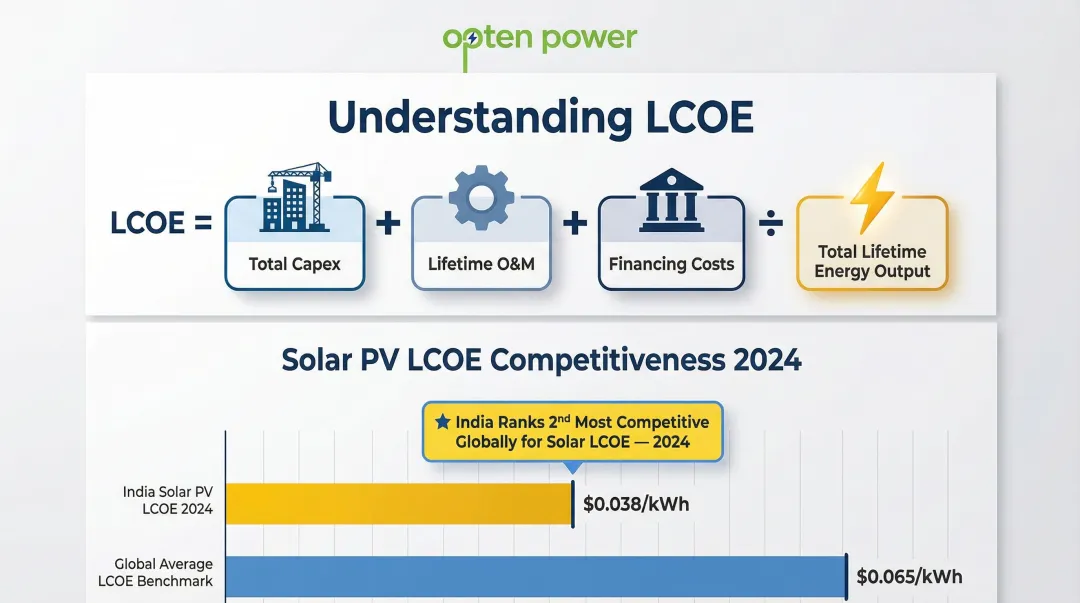

Levelised Cost of Energy (LCOE) Benchmarking
LCOE calculates the average per-unit cost of electricity generation over the lifetime of a project, accounting for all capital expenditure, financing costs, and operating expenses divided by total energy output. While not a valuation method in the strict sense, LCOE is widely used in India to benchmark project competitiveness, set PPA bid prices, and assess whether a project is economically viable relative to prevailing tariff rates.
LCOE has practical value in the Indian context: developers use it to determine minimum PPA prices during tender responses, lenders use it to stress-test project viability under different cost scenarios, and C&I buyers use it to compare the cost of captive renewable power against grid tariffs. India had the second most competitive solar PV LCOE globally at $0.038/kWh in 2024. LCOE comparisons only hold when both projects use the same system boundaries—with or without storage, with or without subsidy.
| Attribute | Details |
|---|---|
| Best Used For | Tender benchmarking, PPA pricing, competitiveness analysis, C&I procurement decisions |
| Key Inputs | Total capex, O&M costs, project life, capacity factor, discount rate |
| Key Limitation | Does not account for the time value of power dispatch (intermittency); an incomplete measure of project profitability for equity investors |

Key Factors That Drive Renewable Energy Project Value
Regardless of which valuation method is applied, several project-level factors serve as the primary levers of value.
Revenue structure is the most critical factor. PPA-contracted projects with investment-grade offtakers trade at a premium because revenue certainty reduces perceived risk and supports lower discount rates. Merchant projects offer potential upside but carry higher valuation uncertainty — typically bearing discount rate premiums of 200–300 basis points above PPA-backed projects.
Energy production estimates (P50 vs. P90) shape lender requirements and NPV outputs. A P50 estimate represents the energy output expected to be achieved or exceeded 50% of the time; a P90 estimate is more conservative and is often required by lenders for debt sizing. More than 60% of wind assets in India lagged their P90 level on average over the last five fiscals, highlighting the necessity of conservative debt sizing. Using P50 inputs in a DCF versus P90 can meaningfully change the project's net present value.
Regulatory incentives and policy risk act as a dual-edged value driver. Subsidies, accelerated depreciation, RPO compliance value, and grid connectivity benefits add to project value in India. But policy reversals, DISCOM payment delays, and changes in open access regulations represent material downside risks. As of December 2024, DISCOMs owed power generators ₹673 billion, with Uttar Pradesh, Andhra Pradesh, and Maharashtra carrying the highest dues. Any serious valuation must stress-test both base-case and policy-risk assumptions.
Capital structure and financing terms directly affect project-level WACC and NPV. Each of the following variables shifts the valuation outcome:
- Debt-to-equity ratio and overall leverage
- Cost of debt and loan tenure
- Access to REC-eligible bonds or multilateral DFI loans
- Presence of tax equity or concessional green finance
Projects with cheaper, longer-tenure financing will show higher valuations than identically performing projects relying on costlier commercial debt.
How to Choose the Right Valuation Method
No single method is sufficient in isolation. Professional appraisers and deal analysts apply multiple methods and triangulate conclusions.
Use this practical decision framework:
- Apply DCF as the primary method for operational or near-operational projects with contracted revenues
- Use comparable analysis to validate DCF outputs against market transactions
- Use the asset-based approach for pre-revenue or early-stage projects
- Use LCOE for competitive benchmarking and bid validation
The most common mistake is relying on single-method valuation without sensitivity analysis. Running scenario analysis — varying the discount rate, PPA price, capacity factor, and policy assumptions — reveals the full range of value outcomes rather than a single point estimate.
Valuations built on aggressive P50 assumptions and low discount rates without stress testing have historically led to deal-pricing errors in renewable M&A.

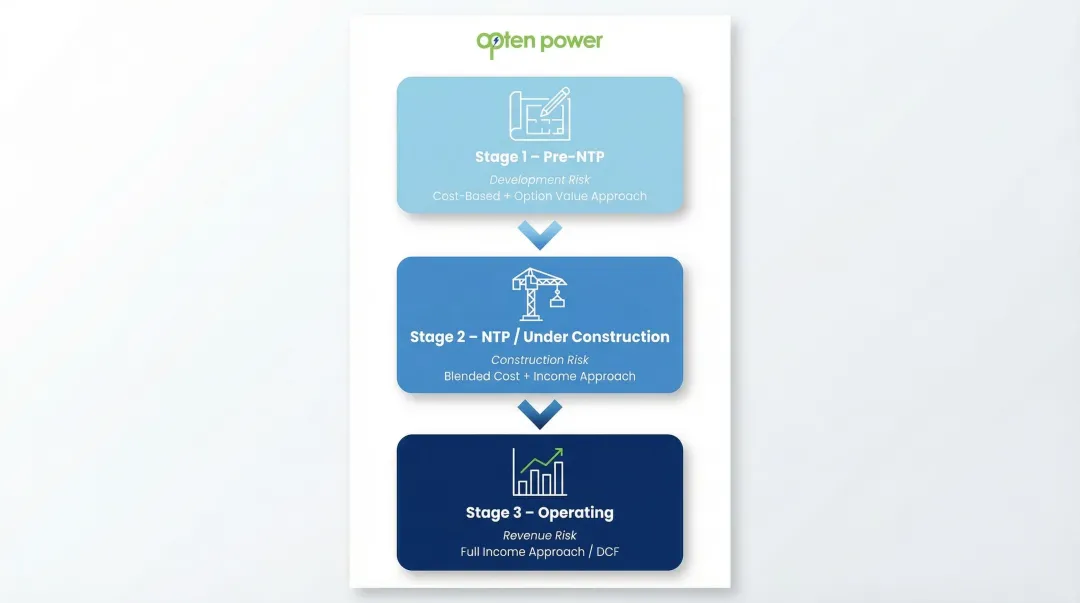

Beyond scenario analysis, method selection also depends on where a project sits in its lifecycle. Each stage carries different risk profiles — and different valuation tools:
| Project Stage | Primary Risk | Recommended Approach |
|---|---|---|
| Pre-NTP | Development risk | Cost-based + option value |
| NTP / Under Construction | Construction risk | Blended cost + income approach |
| Operating | Revenue risk | Full income-approach (DCF) |

Conclusion
No single valuation method tells the whole story. DCF, comparable analysis, asset-based approach, WACC/CAPM, and LCOE benchmarking each serve a distinct purpose—and together, they triangulate a defensible value range that holds up to scrutiny.
For developers, investors, and C&I buyers operating in India, sound valuation practice comes down to three priorities:
- Stress-test assumptions rigorously against realistic generation and tariff scenarios
- Account for India-specific regulatory and DISCOM risks, which can materially shift project economics
- Validate financial model outputs against market-based data, not just internal projections
Getting those inputs right is where independent, data-driven tools make a measurable difference. Opten Power's platform delivers real-time IRR, payback, and regulatory analysis across 4+ GW of solar, wind, and hybrid projects in 16 states—giving investors and buyers the market-grounded data needed to evaluate projects with confidence. Explore the platform at app.optenpower.com or connect with the team to evaluate your first project.
Frequently Asked Questions
What is the most commonly used valuation method for renewable energy projects?
DCF is the most widely used method because it captures long-term cash flows from PPAs and energy sales over 25–30 year project lives. However, professional appraisers typically cross-check DCF outputs using comparable transaction multiples and, for early-stage assets, the cost approach to ensure valuation robustness.
How does a PPA affect the valuation of a renewable energy project?
A long-term PPA with a creditworthy offtaker increases project value by reducing revenue uncertainty — supporting a lower discount rate in DCF analysis and higher EV/EBITDA multiples in comparable transactions. PPA-backed projects typically price 200–300 basis points tighter on discount rates than merchant projects.
What discount rate is typically used for renewable energy projects?
Discount rates vary by project risk, geography, and financing structure. India's 10-year government bond yield stood at 7.00% as of March 2026, serving as the risk-free rate baseline. Contracted solar and wind projects typically use WACC in the range of 9–11%, while merchant projects may require 12–14% or higher.
What is the difference between DCF and asset-based valuation for a renewable energy project?
DCF values a project based on its expected future earnings discounted to present value, while asset-based valuation values it based on the cost of its physical assets minus depreciation. DCF is preferred for operating projects with established cash flows, while the asset-based approach is more relevant for pre-revenue or early-stage assets.
How do government subsidies and tax incentives affect renewable energy project valuation?
Subsidies, accelerated depreciation, and tax incentives directly increase projected cash flows or reduce financing costs, thereby increasing NPV in a DCF model. However, valuations must also scenario-test for policy reversal risk, particularly in markets like India where regulatory frameworks evolve and DISCOM payment reliability varies significantly by state.
What KPIs matter most when evaluating a renewable energy investment?
Key KPIs include IRR, payback period, capacity factor, DSCR, and LCOE — each serving a different stakeholder. Equity investors focus on IRR and LCOE for return potential; lenders use DSCR to assess debt repayment capacity; technical teams rely on capacity factor to evaluate operational performance.
